Cost of Risk Assessment: A 2026 Practitioner Guide

Photo of author
Written By Chris Ekai

IBM’s 2024 Cost of a Data Breach Report put the global average breach cost at $4.88 million, a 10% year-over-year increase and the largest jump since the pandemic. 70% of breached organizations reported significant disruption.

Against that number, the Cost of Risk Assessment looks small. A $20,000 assessment that prevents one $500,000 loss event delivers 25x return on the investment.

Key Takeaways
The 2026 Cost of Risk Assessment in the US ranges from near-zero for an internal qualitative exercise to $50,000-$75,000+ for a deep enterprise or cybersecurity engagement. Cybersecurity SMB assessments typically run $5,000-$25,000; enterprise cybersecurity runs $25,000-$75,000; ERM scoping runs $15,000-$75,000+; project Monte Carlo runs $10,000-$50,000.
IBM’s 2024 Cost of a Data Breach Report put the global average breach cost at $4.88 million, a 10% YoY increase and the largest jump since the pandemic. 70% of breached organizations reported significant or very significant disruption. The Cost of Risk Assessment is small relative to the breach number it can prevent.
The Total Cost of Risk (TCOR) framework places the Cost of Risk Assessment inside the broader risk-control-and-prevention bucket, alongside training, security tools, and compliance systems. RIMS benchmark data positions a well-run program below the peer median; weak programs sit higher with worse premium and retained-loss outcomes.
Five drivers move the Cost of Risk Assessment: organizational size and complexity, scope and depth (qualitative vs. Monte Carlo quantitative), internal vs. external resourcing, industry and regulatory tier, and number of sites and systems. Federal contractors, banks, and HIPAA-regulated entities pay the most because compliance documentation drives up hours.
Project cost risk assessment is a different exercise from the cost of conducting a risk assessment. Probabilistic methods (Monte Carlo, three-point estimates) translate cost uncertainty into P50 / P80 outputs that drive contingency. Interface Consulting reports many deterministic cost estimates have a 15% probability of being met when project risks are properly modeled.
Standards: ISO 31000:2018 risk management, ISO/IEC 27005:2022 information security risk, NIST SP 800-30 Rev 1 risk assessment, NIST SP 800-37 Rev 2 RMF, COSO ERM 2017, RIMS Risk Maturity Model, and OCC Heightened Standards anchor a defensible Cost of Risk Assessment scope.
A 2026 audit-committee paper integrates the Cost of Risk Assessment into TCOR reporting, with year-over-year trend, peer benchmarks, and the dollar-loss events the assessment prevented. The CFO and chief risk officer co-own the dashboard; internal audit reports back on assessment quality and remediation aging.

This guide rebuilds the Cost of Risk Assessment question for a 2026 US chief risk officer, CFO, or audit-committee chair. The honest answer to the cost question is: it depends.

Engagements run from near-zero for an internal qualitative exercise to $75,000+ for a deep enterprise or cybersecurity assessment. The drivers are predictable; the discipline lives in matching method to decision.

The Cost of Risk Assessment is one entry inside the larger Total Cost of Risk (TCOR) framework that the Risk and Insurance Management Society (RIMS) and Alliant Insurance Services define as the sum of risk financing, retained losses, risk control, administrative, and indirect costs.

Assessment spend sits in the risk-control bucket. Done well, it pulls down loss costs and premiums across every other TCOR component.

Cost of Risk Assessment
Cost of Risk Assessment: A 2026 Practitioner Guide

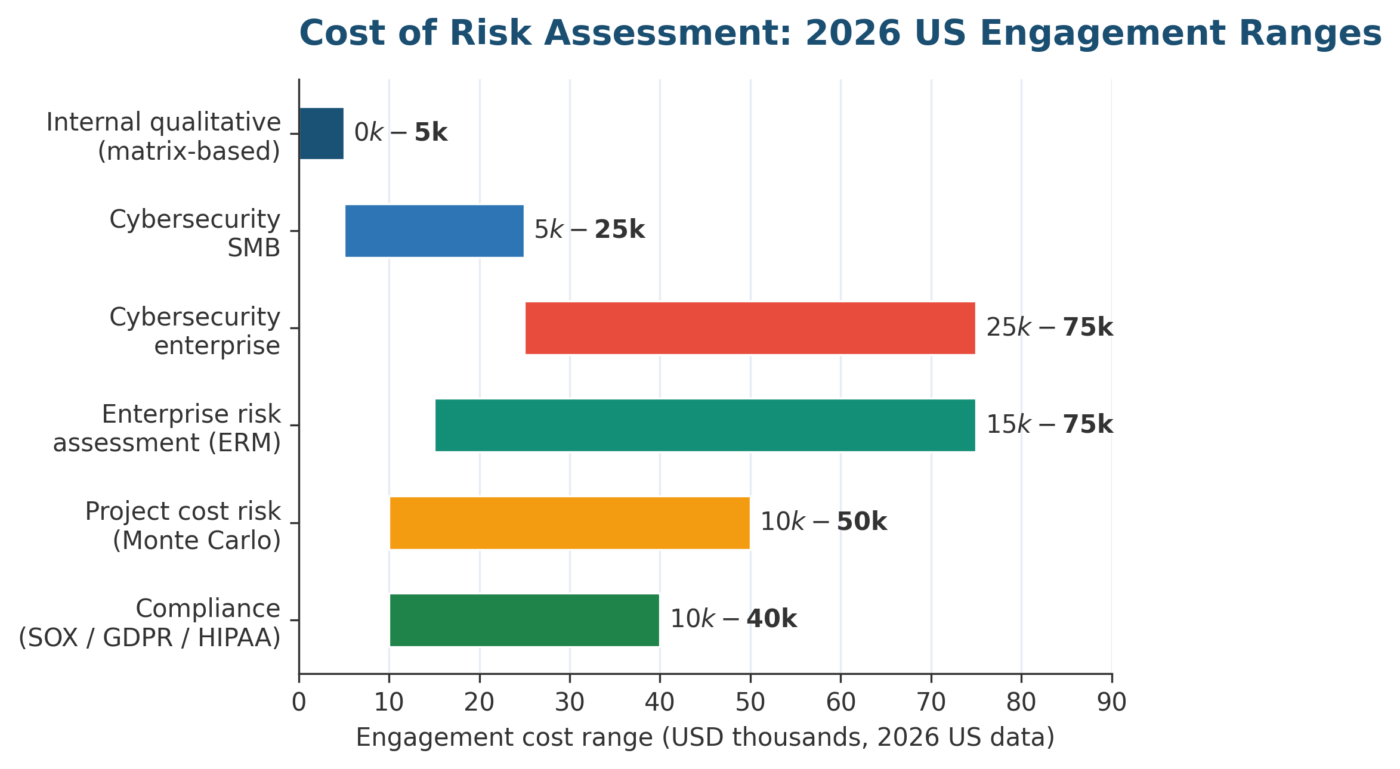

Figure 1. 2026 US Cost of Risk Assessment ranges by engagement type, in USD thousands.

Table of Contents

What the Cost of Risk Assessment Includes

A risk assessment identifies threats to objectives, scores their likelihood and impact, and produces a prioritized response plan. The output is a risk register or risk report with named controls, owners, and mitigation actions.

The Cost of Risk Assessment captures the dollar value of producing that output: staff hours, external consultants, tools, software, workshops, and the documentation work that lands on the audit committee paper.

Useful risk assessment guidance anchors the work in a documented framework. Common references include ISO 31000:2018 for enterprise scope, NIST SP 800-30 for information security, COSO ERM 2017 for governance and controls, and ISO/IEC 27005:2022 for the cyber-specific track. The framework choice changes the methodology, the depth of analysis, and the final price tag.

The five steps of the risk management process run consistently across frameworks: scope and context, identify, analyze, evaluate, and treat / monitor.

Each step takes hours that translate into Cost of Risk Assessment line items. Skipping a step (often the analysis or the treatment plan) produces a cheaper deliverable that fails the next regulator question or audit-committee review.

Cost of Risk Assessment by Engagement Type and Organization Size

The Cost of Risk Assessment varies most by engagement type. A high-level qualitative scan uses risk-matrix templates and facilitated workshops; a deep quantitative assessment uses Monte Carlo simulation, statistical modeling, and sensitivity analysis.

Both have a place. The 2026 US ranges below align to public benchmarks from TechTarget, Cybrwise, and engagement quotes across mid-market and Fortune-500 buyers.

2026 US Cost of Risk Assessment Ranges by Engagement Type

Engagement typeTypical 2026 US costKey cost drivers
Internal qualitative (risk matrix, facilitated workshops)$0 – $5,000 (staff hours + tools)Staff hours, template quality, facilitator experience, scope of business units covered
Cybersecurity risk assessment (SMB, < 50 endpoints)$5,000 – $25,000Endpoint count, compliance scope (HIPAA, PCI-DSS, CMMC), cloud and on-prem mix
Cybersecurity risk assessment (enterprise / multi-site)$25,000 – $75,000+Multi-site, hybrid cloud, regulatory scope, penetration testing add-ons, third-party scope
Enterprise risk assessment (ERM, ISO 31000 / COSO)$15,000 – $75,000+Number of business units, depth of quantitative analysis, board-level reporting expectations
Project cost risk assessment (Monte Carlo, P50 / P80)$10,000 – $50,000Project value, number of cost elements, simulation complexity, sensitivity-analysis depth
Compliance risk assessment (SOX, GDPR, HIPAA, FCPA)$10,000 – $40,000Regulatory scope, data sensitivity, audit-evidence quality, NIST SP 800-30 alignment
Climate risk assessment (TCFD / IFRS S2 / CARB SB 253)$25,000 – $100,000+Asset footprint, scenario count, Scope 1/2/3 GHG accounting depth, audit-grade evidence

Cybersecurity-specific data from Cybrwise places SMBs (under 50 employees) at $5,000-$15,000, mid-sized organizations at $15,000-$35,000, and large enterprises at $35,000+ for a thorough cybersecurity Cost of Risk Assessment.

Healthcare under HIPAA, financial services under SOX, and federal contractors under CMMC 2.0 typically land at the upper bound because compliance documentation drives the hour count.

Five Drivers of the Cost of Risk Assessment

Five drivers move the Cost of Risk Assessment up or down. Knowing them in advance lets a CFO or chief risk officer scope the engagement to the actual decision the assessment is meant to inform.

Most overpayments come from buying methodology depth that the decision does not require, or from buying a low-cost deliverable that fails the next regulator review.

Driver 1: Organizational Size and Complexity Inside the Cost of Risk Assessment

A 50-person company with a single office and one IT environment is a different engagement than a 5,000-employee multinational with hybrid cloud. More people, more processes, and more systems mean more risk surface to assess.

The Cost of Risk Assessment scales near-linearly with sites and full-time-equivalent (FTE) count for cyber and operational engagements, and with business-unit count for ERM.

Driver 2: Scope and Depth Inside the Cost of Risk Assessment

A high-level qualitative assessment with risk matrices and workshops costs less than a quantitative assessment using Monte Carlo simulation and statistical modeling. Qualitative works for prioritization and awareness.

Quantitative is necessary when the audit committee or board asks for probability distributions, confidence intervals, and dollar-value exposure. Match the depth to the decision; over-engineering is the most common Cost of Risk Assessment overspend pattern.

For more on quantitative methods, ISO 31000-aligned risk-assessment methodology and qualitative and quantitative risk assessment guidance walk through the trade-offs.

Most US Fortune-500 ERM programs run a hybrid: qualitative across the broad universe, quantitative on the top-10 risks where leadership needs dollar exposure for capital allocation or insurance-program design.

Driver 3: Internal vs. External Resources Inside the Cost of Risk Assessment

Running the assessment internally with trained staff is the most cost-effective approach. It requires that the team holds the methodology, tools, and independence to do it well.

External consultants bring specialist expertise and credibility for board reporting, but at a premium. Most US Fortune-500 buyers run a hybrid: internal teams handle data collection and risk identification; external specialists handle analysis, validation, and reporting.

Driver 4: Industry and Regulatory Tier Inside the Cost of Risk Assessment

Regulated industries pay more because the Cost of Risk Assessment must satisfy specific compliance standards. Healthcare under HIPAA follows NIST SP 800-30 and produces documentation that survives an HHS-OCR audit.

Financial services under SOX, OCC Heightened Standards, or Basel III face similar bars. Defense contractors under CMMC 2.0 run NIST SP 800-171 controls. The hour count rises 20-40% over an unregulated equivalent.

Driver 5: Number of Sites and Systems Inside the Cost of Risk Assessment

For cybersecurity, IT, and operational engagements, the number of physical sites, network endpoints, cloud services, and third-party integrations directly drives scope. Each new site, SaaS application, or material vendor adds assessment hours.

Mid-market firms with rapid SaaS sprawl often see the Cost of Risk Assessment double during onboarding because the asset inventory work runs first and runs slow.

Cost of Risk Assessment Inside the Total Cost of Risk (TCOR) Framework

The Cost of Risk Assessment is one line in the broader Total Cost of Risk (TCOR) framework. RIMS, Alliant, and Aon use TCOR to benchmark a program’s effectiveness and to pull down insurance premiums over time.

TCOR has five components: risk financing (insurance and broker fees), retained losses (deductibles and uninsured), risk control (training, tools, assessments), administrative (staff and RMIS), and indirect costs (downtime and reputation).

The formula reads simply: Risk Financing + Loss Costs (direct + indirect) + Administrative + Taxes and Fees = TCOR. Alliant notes that a lower TCOR signals effective risk management and tends to drive more favorable insurance premium rates, while a higher TCOR points to gaps in risk control.

The Cost of Risk Assessment sits inside risk control; well-deployed, it pulls down losses and premiums in adjacent components.

Cost of Risk Assessment: A 2026 Practitioner Guide
Cost of Risk Assessment: A 2026 Practitioner Guide

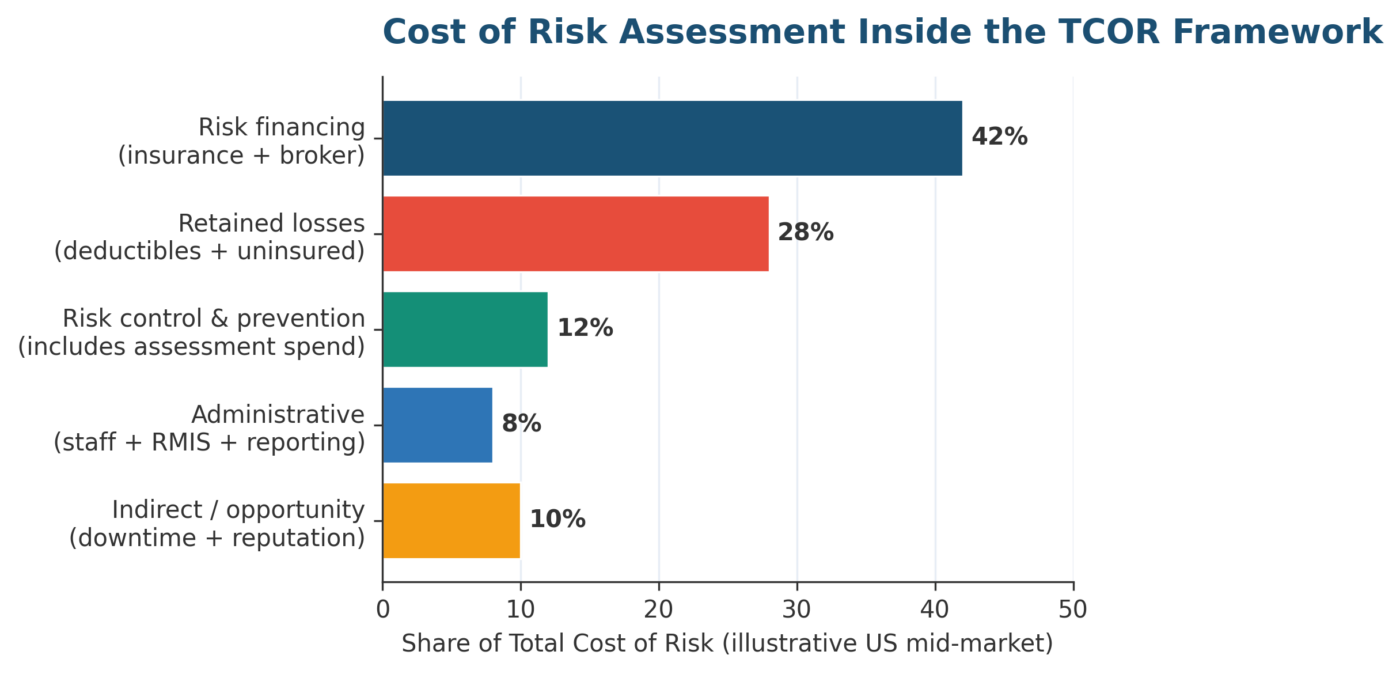

Figure 2. The Cost of Risk Assessment lives inside the risk-control bucket of TCOR (typical US mid-market split, illustrative).

Riskonnect emphasizes that a unified view of risk exposures is required to calculate TCOR accurately and that consolidating data from disparate sources usually requires a risk management information system (RMIS).

Without that backbone, TCOR reporting becomes an annual estimate rather than a quarterly KRI, and the Cost of Risk Assessment cannot be benchmarked year-over-year against retained-loss and premium movement.

Cost of Risk Assessment for Capital Projects: Probabilistic Methods

In capital project management, “cost risk assessment” carries a specific meaning. It is the process of identifying and quantifying financial uncertainties that could push a project past its approved budget.

This is different from the Cost of Risk Assessment for the assessment work itself. Both matter for a CFO; mixing the two on the same paper is a frequent cause of board-paper confusion.

Project cost risk assessment typically identifies cost-risk drivers (material price volatility, labor rate changes, design modifications, permitting delays), assigns probability distributions to uncertain cost elements,

Runs Monte Carlo simulations to generate a range of outcomes, and expresses results as probability-weighted estimates (P50 = $100M, P80 = $120M). The eight-step project risk assessment guide walks through the workflow.

Interface Consulting, which specializes in construction project risk, notes that deterministic cost estimates often have a 15% probability of being met when project risks are properly modeled.

Probabilistic cost risk assessment is now standard practice on large US capital projects. Boards and lenders price projects against P80 outputs, not the deterministic base estimate.

Common Pitfalls in the Cost of Risk Assessment Engagement

Implementation failures around the Cost of Risk Assessment repeat at every revenue scale.

The traps below show up in audit-committee post-mortems, regulator findings, and engagement-debrief sessions across US Fortune-500 buyers and mid-market firms alike. Each one represents a common pattern that turns a useful assessment into shelf-ware.

PitfallRoot causeRemedy
Methodology over-engineeringBuyer purchases Monte Carlo and statistical modeling for an awareness-level decisionMatch method to decision: qualitative for prioritization, quantitative only when leadership needs dollar exposure
Findings in a folderAssessment delivered as a one-time report; no risk register, no owners, no due datesFeed findings into a living risk register; assign one named owner per item; track action closure as a meta-KRI
Compliance-only scopeEngagement scoped to satisfy a single regulator (HIPAA, SOX) without enterprise viewRun a unified Cost of Risk Assessment that covers operational, strategic, and compliance dimensions in one framework
No data preparationConsultants spend 30-40% of hours chasing inventories and policies that should have been readyPrepare network diagrams, asset inventories, prior assessments, and policies before the kickoff meeting
No TCOR linkageAssessment cost reported in isolation; loss-cost and premium movement tracked separatelyPlace the Cost of Risk Assessment inside the TCOR scorecard; track YoY against retained losses and premium ratios
No reassessment cadenceAssessment run once, then not refreshed for three yearsSet an annual cadence with material-event triggers (acquisition, system change, regulator inquiry)
Vanity dashboardsBeautiful risk heat maps no committee actually acts onTie each amber / red item to a triggered action; track action closure as a meta-KRI

Getting More ROI from the Cost of Risk Assessment

Spending money on a risk assessment only creates value when the findings drive action. Six practices push the Cost of Risk Assessment ROI from break-even to multiples of spend.

They map cleanly to the DOJ September 2024 Evaluation of Corporate Compliance Programs (ECCP) refresh, which expects documented risk analytics rather than ad-hoc legal review.

Six Practices That Lift Cost of Risk Assessment ROI

  • Practice 1. Set clear objectives upfront: Define what the engagement must deliver before scoping. Regulator deliverable, board-level appetite paper, system-specific vulnerability scan? The clearer the objective, the more focused and cost-effective the Cost of Risk Assessment becomes.
  • Practice 2. Prepare data in advance: Cybrwise reports cyber assessment costs drop up to 15% when documentation is ready before kickoff. Network diagrams, asset inventories, security policies, and prior assessment reports cut consultant discovery hours.
  • Practice 3. Use a register that drives decisions: Feed the assessment output into a living risk register with named owners, due dates, and review cycles. A register that sits in a folder until the next audit cycle is a wasted Cost of Risk Assessment.
  • Practice 4. Match method to decision: A qualitative matrix is enough for many operational risks. Reserve Monte Carlo for high-stakes capital, insurance program design, or board-level capital allocation. Buying methodology beyond the decision wastes budget.
  • Practice 5. Reassess on cadence: Run an annual enterprise refresh, supplemented by targeted assessments at material events (M&A, new systems, regulatory shifts, market events). Refresh cost is typically lower than initial scoping because framework, data sources, and baseline are already in place.
  • Practice 6. Track TCOR over time: Use the TCOR framework to measure whether the Cost of Risk Assessment is translating into lower retained losses and lower premiums. If assessment spend rises but loss costs and premiums fall by more, the program is delivering positive ROI.
Cost of Risk Assessment: A 2026 Practitioner Guide
Cost of Risk Assessment: A 2026 Practitioner Guide

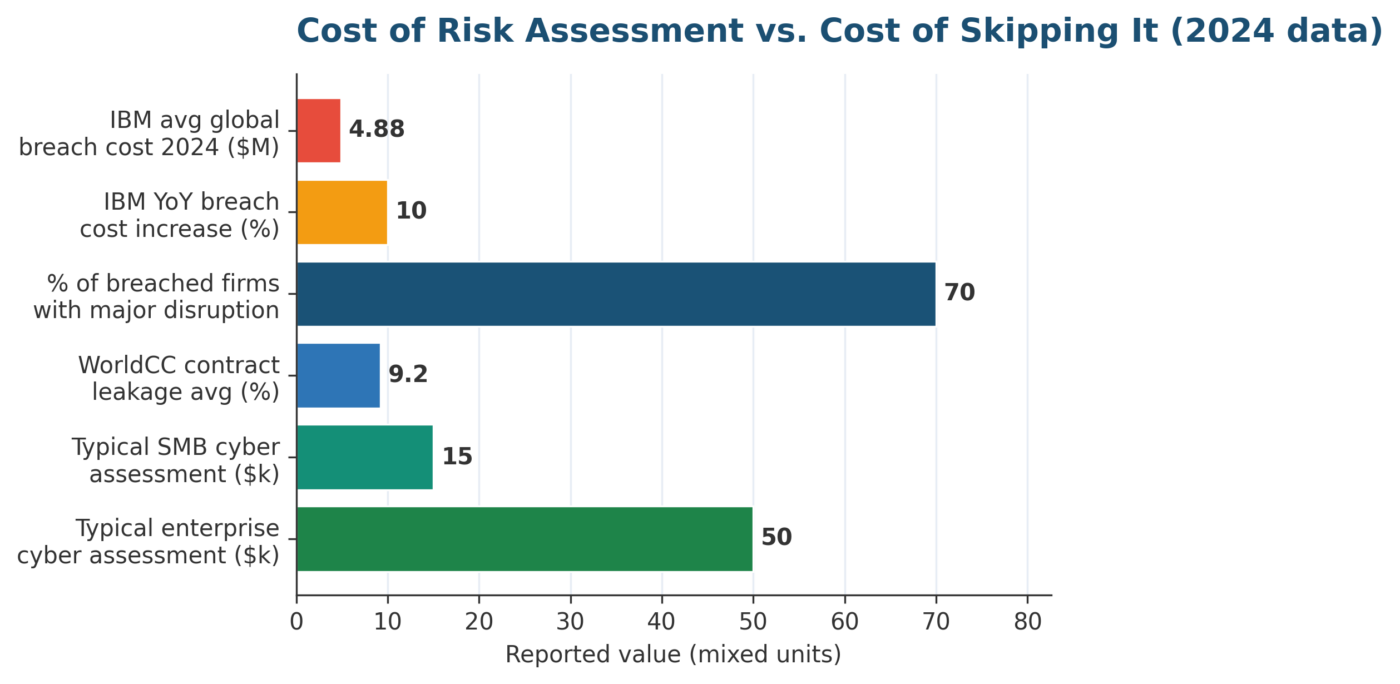

Figure 3. The Cost of Risk Assessment vs. the cost of skipping it. IBM 2024 breach data on the left; typical assessment spend on the right.

Frequently Asked Questions About the Cost of Risk Assessment

What is the typical Cost of Risk Assessment for a US small business in 2026?

The typical Cost of Risk Assessment for a US small business (under 50 employees) ranges from $5,000 to $15,000 for a cybersecurity engagement, $0 to $5,000 for a qualitative internal scan, and $10,000 to $25,000 for a compliance-driven assessment such as HIPAA, PCI-DSS, or SOC 2 readiness. The lower bound assumes the business has documentation and an asset inventory ready before kickoff.

What is the typical Cost of Risk Assessment for a US enterprise in 2026?

The typical Cost of Risk Assessment for a US Fortune-500 enterprise runs $25,000-$75,000+ for cybersecurity, $35,000-$100,000+ for an ERM scoping with quantitative analysis, and $100,000+ for a multi-jurisdiction climate or regulatory deep-dive.

The cost reflects multi-site footprints, hybrid cloud, regulatory tier, and the documentation depth that survives an audit committee or rating-agency review.

How does the Cost of Risk Assessment fit inside the TCOR framework?

The Cost of Risk Assessment is a line item inside the risk-control-and-prevention bucket of the Total Cost of Risk (TCOR) framework.

Other buckets include risk financing (insurance and broker fees), retained losses (deductibles and uninsured), administrative (staff and RMIS), and indirect (downtime and reputation).

A well-deployed Cost of Risk Assessment pulls down losses and premiums in the other four components, lowering TCOR overall.

Which standards govern the Cost of Risk Assessment scoping?

The dominant references are ISO 31000:2018 risk management, ISO/IEC 27005:2022 information security risk, NIST SP 800-30 Rev 1 risk assessment, NIST SP 800-37 Rev 2 RMF, COSO ERM 2017, the RIMS Risk Maturity Model, and the OCC Heightened Standards (for banks).

Healthcare adds HHS-OCR Risk Analysis. Federal contractors add CMMC 2.0. Each standard pulls the Cost of Risk Assessment scope toward its own evidence baseline.

How often should the Cost of Risk Assessment be refreshed?

Refresh the Cost of Risk Assessment annually at minimum, with targeted refreshes at material events (M&A, new systems, regulator inquiries, market events).

Mid-market firms typically run a full assessment every 12-18 months and a lighter delta refresh quarterly. Cybersecurity engagements often run on a six-month cycle in regulated industries because the threat surface changes faster than ERM scope does.

Is internal or external the better option for the Cost of Risk Assessment?

The hybrid model is the most common Cost of Risk Assessment choice in US Fortune-500 buyers. Internal teams handle data collection, asset inventory, and initial risk identification.

External specialists handle analysis, methodology validation, and reporting. The hybrid keeps cost down (internal hours are cheaper than consulting hours) while preserving the independence and credibility a board or regulator expects.

Can a Cost of Risk Assessment ROI be measured?

Yes. Use the TCOR framework as the measurement layer. Track assessment spend year-over-year against retained losses, insurance premium ratios, regulatory fines, and downtime / disruption events.

A program where assessment spend rises modestly but TCOR drops materially is generating positive ROI. IBM’s 2024 $4.88 million average breach cost provides a benchmark for the loss event a strong assessment program can prevent.

How does the Cost of Risk Assessment differ for project risk vs. enterprise risk?

Project Cost of Risk Assessment focuses on quantifying budget uncertainty using Monte Carlo and three-point estimates, producing P50 / P80 outputs that drive contingency.

Enterprise Cost of Risk Assessment scopes the broader risk universe across operational, strategic, financial, and compliance dimensions.

The two engagements share methodology vocabulary but answer different questions and feed different decisions on the audit committee paper.

Looking Ahead: The Cost of Risk Assessment in 2026 and 2027

The Cost of Risk Assessment trends upward through 2026 and 2027 across regulated US sectors. The DOJ September 2024 ECCP refresh raised the bar on documented risk analytics.

SEC’s record FY2024 $8.2 billion in financial remedies tightened the disclosure-committee paper trail. State privacy laws (20 active by mid-2025) and California SB 253 climate disclosure stretch the regulatory scope of every enterprise engagement.

AI integration changes the Cost of Risk Assessment economics on both sides of the engagement. Generative-AI-assisted threat-modeling tools and CLM-style analytics drop discovery hours by 20-30% on cybersecurity and compliance engagements.

AI itself adds a new scope category: AI inventory, AI policy coverage, AI-incident reporting, and shadow-AI scans now sit inside most enterprise Cost of Risk Assessment engagements.

Climate and ESG scope expand fastest. California SB 253 first-disclosure deadline lands August 10, 2026; the EU CSDDD takes phased effect through 2027 and 2028 and reaches US suppliers via in-scope EU buyers.

The Cost of Risk Assessment for asset-heavy industries (utilities, manufacturers, REITs) rises with scenario-analysis depth, GHG accounting documentation, and TCFD / IFRS S2 audit-grade evidence.

A live KRI dashboard with quarterly recalibration and a clear integrated risk management approach is what turns a Cost of Risk Assessment line item into a TCOR-positive program. Without it, the assessment becomes shelfware and the next IBM-grade breach event prices in losses the program could have prevented.

Ready to Operationalize the Cost of Risk Assessment?

At riskpublishing.com we help US chief risk officers, CFOs, and audit-committee chairs scope the Cost of Risk Assessment engagement that holds up under SOX 404 audit, OCC examination, DOJ ECCP review, customer security audits, and rating-agency surveillance.

We start with the decision the assessment must inform, work back to the methodology, and price to the actual scope rather than the catalog default.

The work usually includes the assessment scope document, the framework alignment (ISO 31000:2018, NIST SP 800-30, COSO ERM, ISO/IEC 27005:2022), a TCOR placement model, a risk register design, and a quarterly audit-committee paper template.

We calibrate the Cost of Risk Assessment against peer Fortune-500 benchmarks and against the specific TCOR baseline already in place at the client.

Explore our risk advisory services, or contact us to scope a Cost of Risk Assessment maturity review tailored to the regulatory tier, asset footprint, and 2026-2027 audit-committee agenda.

We also benchmark engagement quotes against peer ranges before signature, run a TCOR baseline within the first thirty days, and align the assessment scope to the next 10-K risk-factor cycle.

Related reading on riskpublishing.com (assessment library): how to conduct a risk assessment, a guide to risk assessment methodology, qualitative and quantitative risk assessment, a step by step guide to risk assessment, and scenario based risk assessment.

Related reading (project, register, mitigation): conducting a project risk assessment, key elements of a risk register, five steps of the risk management process, how to mitigate risk, and a risk mitigation plan might include.

Related reading (ERM, frameworks, KRIs): enterprise risk management framework, ISO 31000 vs COSO ERM Framework, integrated risk management approach, Key Risk Indicators dashboard, and risk appetite statements examples.

Table of Contents

Index
