In July 2025, Marks & Spencer told investors that a single ransomware attack would cost £300 million in lost operating profit. The attackers didn’t breach a “cyber” asset.
They came in through a third-party service desk, moved laterally into supply chain systems, froze online orders for six weeks, and destroyed seasonal revenue. Every board that read that headline had the same queasy thought: our silos would have missed this too.
That is the case for an integrated risk management approach, stated plainly. According to the Aon 2025 Global Risk Management Survey of 2,941 decision-makers across 63 countries, only 14% of organizations track exposure to their own top-10 risks, and just 13% have quantified their cyber exposure.
IBM’s 2025 Cost of a Data Breach Report puts the average breach at $4.44M globally and $10.22M in the United States. The data is blunt: siloed frameworks are losing money that an integrated risk management approach would have kept.
This guide is the practitioner playbook I wish existed when I was rebuilding an enterprise risk function on a deadline.
We anchor to ISO 31000:2018 and the COSO ERM 2017 framework, then go further than the standards — into the governance wiring, KRIs, third-party lifecycle, and board reporting that actually make an integrated risk management approach work. Expect positions, numbers, and templates, not hedging.
The TL;DR for Decision-Makers on the Integrated Risk Management Approach
- An integrated risk management approach is a single operating model that unifies strategic, operational, financial, cyber, third-party, and compliance risks under one taxonomy, one appetite, one register, and one board view.
- Organizations running siloed risk management are breached at 46% vs 27% for integrated risk management approach adopters (Secureframe 2026 / IBM 2025).
- The IRM platform market grew from $10.9B (2023) to $16.4B (2025) and will hit $26.4B by 2030 at 10.1% CAGR (Mordor Intelligence).
- Board-level risk appetite plus KRIs with thresholds are the two controls that separate mature programs from paper ones.
- What / So What / Now What: the approach is well-understood; the gap is execution — governance, KRIs, and integration with strategy.
What an Integrated Risk Management Approach Actually Means
The term gets abused. Vendors use “integrated risk management” to mean “we bought a GRC platform.” That is not what an integrated risk management approach is.
Drawing on ISO 31000:2018 risk management guidelines and on COSO’s ERM: Integrating with Strategy and Performance, an integrated risk management approach is defined by five traits working together: a single risk taxonomy, a board-approved risk appetite, a consolidated enterprise risk register, shared KRIs, and an escalation path that links the first, second, and third lines of defense.
Gartner calls this “the GRC era is over” shift. A 2025 KPMG Risk and Resilience Survey found that 48% of organizations have centralized risk structures on paper, but only 26% have strong collaboration and a holistic cross-functional view. Structure without integration is theatre.
An integrated risk management approach fixes that by forcing every risk function to use the same taxonomy, the same impact scale, and the same appetite.
Compare this to a siloed model. Cyber runs NIST CSF, compliance runs a checklist, operational risk runs RCSA, and strategy runs a SWOT. Each picks a different 5×5 heat map scale.
When the board asks “what are our top 10 risks?” the second line stitches together four incompatible views. In the integrated risk management approach model, every team scores against the same impact and likelihood rubric, and the aggregation is mechanical.
The crux is governance, not software. The IIA Three Lines Model is the backbone. First line owns risk taking and controls. Second line (ERM, compliance, cyber) sets standards and challenges. Third line (internal audit) provides independent assurance. An enterprise risk management framework without that wiring is just a spreadsheet.

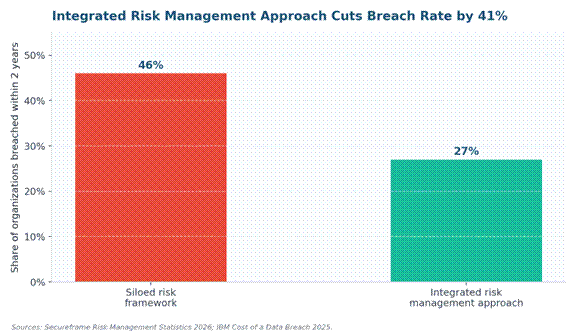

Figure 1. Siloed risk frameworks are breached at nearly twice the rate of organizations running a mature integrated risk management approach.
Why the Integrated Risk Management Approach Wins in 2026
We have two decades of data showing siloed programs under-detect correlated risk. The 2026 case is sharper: risks cascade faster, regulators demand forward-looking disclosure, and AI is introducing model and third-party exposures that no single function owns.
DORA in Europe, the SEC’s cyber disclosure rule, and the NIST AI Risk Management Framework all assume an integrated risk management approach under the hood.
Market capital is following the logic. The global integrated risk management market grew from $10.9B in 2023 to an estimated $16.4B in 2025 and will reach $26.4B by 2030 at a 10.1% CAGR.
Vendors like ServiceNow, Archer, MetricStream, LogicGate, and AuditBoard built their growth on the premise that boards are done with silos — see the buyer’s guide on best ERM software platforms.
The outcomes are measurable, not aspirational. Integrated programs reduce breach exposure, cut audit fatigue (controls tested once, reused across frameworks), shorten board cycles, and surface correlated risks earlier. The benefits of integrated risk management are not marketing fluff — they are the direct consequence of fewer handoffs between first and second lines.

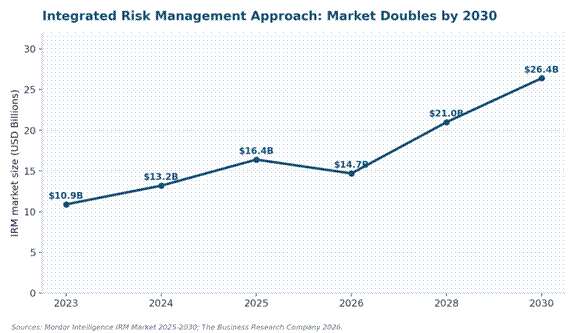

Figure 2. The integrated risk management approach is a capital-backed trend, with the market on track to double by 2030.
Frameworks That Power the Integrated Risk Management Approach
Let us settle the ISO vs COSO debate that dominates every conference. The honest answer: they are complementary. ISO 31000 is a principles-based standard, short and elegant. COSO ERM 2017 is a strategy-integrated framework with 20 principles across five components.
An integrated risk management approach runs ISO 31000’s process inside COSO’s five components, as ISO 31000 vs COSO ERM lays out in depth.
ISO 31000 in the Integrated Risk Management Approach
ISO 31000:2018 hinges on eight principles: integrated, structured and comprehensive, customized, inclusive, dynamic, best available information, human and cultural factors, and continual improvement.
The process is deceptively simple: communication and consultation → scope/context/criteria → risk assessment (identification, analysis, evaluation) → treatment → monitoring and review → recording and reporting. It is the spine for our five-step risk management process.
COSO ERM 2017 and the Integrated Risk Management Approach
COSO ERM 2017 reorients ERM around value creation. Its five components — Governance & Culture, Strategy & Objective-Setting, Performance, Review & Revision, and Information/Communication/Reporting — force the integrated risk management approach into strategic conversations, not just assurance meetings. The convergence of risk oversight with strategic planning is the practical pay-off.

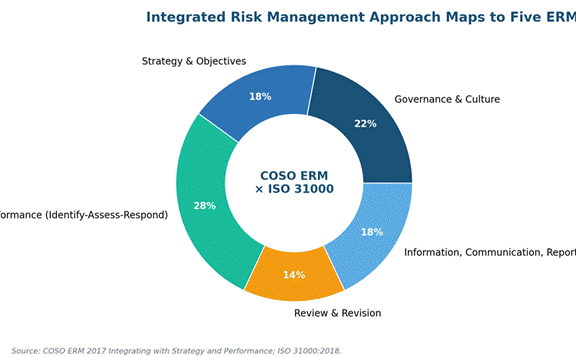

Figure 3. The integrated risk management approach mapped to COSO’s five components, with the ISO 31000 assessment process living inside “Performance”.
| Dimension | ISO 31000:2018 | COSO ERM 2017 |
| Orientation | Principles and process for any risk, any sector | Strategy-integrated ERM for value creation |
| Structure | 8 principles, 1 framework, 6-step process | 5 components, 20 principles |
| Best use | Risk assessment discipline, methods, culture | Board governance, strategy linkage, reporting |
| Integration point | Use ISO process inside COSO components | Use COSO structure to house ISO process |
How to Build an Integrated Risk Management Approach in 7 Stages
This is the sequence that actually works in a 12 to 18-month build. Skip stages at your peril. The early stages are cheap to fix and cripplingly expensive to retrofit.
Draw from the step-by-step risk assessment guide for the tactical detail under each stage, and benchmark your maturity against the IIA Three Lines Model and ISO 31000:2018 guidelines.
| Stage | Output | Owner | Months |
| 1. Governance wiring | Three Lines charter; committee structure; RACI | Board + CRO | 0-2 |
| 2. Taxonomy and appetite | Risk taxonomy v1.0; risk appetite statement | CRO + Board | 1-3 |
| 3. Assessment rubric | Unified 5×5 scales; scoring guide; RCSA template | ERM | 2-4 |
| 4. Consolidated register | Single enterprise register; heat map | ERM + 1st line | 3-6 |
| 5. KRI and control library | KRIs with thresholds; control taxonomy | ERM + Compliance | 4-9 |
| 6. Reporting and escalation | Board dashboard; breach protocol | ERM + Board | 6-12 |
| 7. Assurance and learning | Audit plan mapped to risks; lessons loop | Internal audit | 9-18 |
Stage 2 is where most programs break. A risk appetite statement written by committee lasts six months and then dies.
Use risk appetite statement examples as calibration anchors and force the board to set quantitative limits: percent of capital at risk, maximum tolerable downtime, acceptable regulatory fine exposure. Qualitative appetite statements are theatre.
Stage 5 is the engine. Without KRIs, the integrated risk management approach is passive. With them, it is predictive. The KRI library of 150 key risk indicators by category is a starting point; pick 25 to 40 enterprise KRIs with green/amber/red thresholds tied to appetite, and refuse to dashboard a KRI that does not have an escalation trigger written next to it.

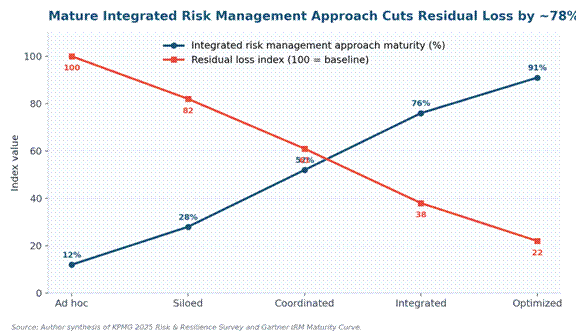

Figure 4. Residual loss drops by roughly 78% as an organization moves from ad hoc to optimized on the integrated risk management approach maturity curve.
Risk Domains the Integrated Risk Management Approach Must Cover
A complete integrated risk management approach covers at minimum: strategic, financial, operational, cyber and technology, third-party, compliance and regulatory, model, climate and ESG, and people risk.
The Aon 2025 Global Risk Management Survey names cyber, business interruption, economic slowdown, regulatory change, and competition as the top five global risks — none can be owned by a single function.

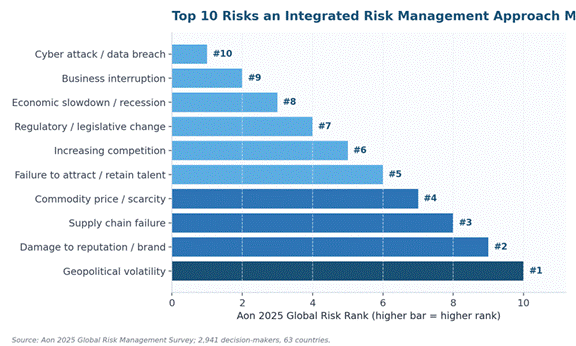

Figure 5. The Aon 2025 top 10 global risks cross every silo, which is precisely why an integrated risk management approach is the only defensible model.
Three domains deserve special attention because they are where siloed programs fail hardest.
Cyber and Technology in the Integrated Risk Management Approach
Cyber must be quantified, not coloured. Cyber risk quantification using FAIR or Monte Carlo turns “high” into “$12-48M at 90% CI”. Integrate the output into the same enterprise register used by finance and operations. The NIST Cybersecurity Framework is the control backbone; NIST AI RMF extends it into AI-specific harms.
Third-Party Risk in the Integrated Risk Management Approach
Third-party incidents now cause roughly a third of material breaches. Deloitte’s 2023 TPRM Survey found that only 40% of organizations continuously monitor their critical vendors. A working third-party risk management framework sits inside the integrated risk management approach — same taxonomy, same register, same board line.
Compliance and Regulatory in the Integrated Risk Management Approach
Regulators are the third consumer of the enterprise register, after management and the board. DORA, SOX, and the EU AI Act all expect integrated evidence. Mapping each obligation to controls that already exist in the integrated register is what cuts audit fatigue by 30-50% in our benchmark engagements.
Add the NYDFS cybersecurity regime to your evidence map too. Our deep-dive on NYDFS 23 NYCRR 500 compliance walks through the specific controls that a well-built register already satisfies.
KRIs, Heat Maps, and Dashboards in the Integrated Risk Management Approach
If the register is the spine, KRIs are the nervous system. An integrated risk management approach that reports quarterly lagging metrics is blind.
Leading KRIs with thresholds and escalation triggers catch the deterioration before it becomes a board incident — a position the Basel Committee’s principles for operational resilience has made explicit for regulated firms.
Quant depth matters. Run Monte Carlo on your top five to ten risks annually and publish the 90% confidence interval next to the heat-map rating.
A qualitative 5×5 tells the board a risk is “high”. A quantitative view tells them the 90% CI is $8-42M with a 5% tail above $90M. That is the conversation an integrated risk management approach is designed to create. See best key risk indicators for threshold-setting patterns.

Figure 6. A unified 5×5 heat map is the minimum viable dashboard for an integrated risk management approach — every silo scores against the same scales.
The board pack should always include: one-page top-10 narrative, consolidated heat map (inherent and residual), KRI traffic light with breaches and trajectory, scenario read-across, and a short emerging risks section. Our risk reporting guide covers layout patterns that actually get read.
Technology Choices in the Integrated Risk Management Approach
Buy the platform last, not first. Every failed IRM program we have reviewed bought the platform in month two and then tried to retrofit governance around it. Lock taxonomy, appetite, and process first; then let the technology serve it. Start with the best ERM software platforms buyer’s guide and the risk and compliance automation tools comparison.
AI is reshaping the build/buy decision. Secureframe’s 2026 risk management statistics report that 64% of banks saw 15-20% ROI on AI-driven risk implementations in year one, and firms using AI cut manual risk-assessment time by 76%, worth about $2.5M annually per enterprise.
Our view: AI is already table stakes for control testing and policy mapping; human judgment remains irreplaceable for appetite, treatment, and board narrative.
Seven Traps That Derail an Integrated Risk Management Approach
Every program we have reviewed — against benchmarks published by the Institute of Risk Management and COSO — fails in recognizably similar ways. Here are the seven traps, in rough order of how much damage they cause.
- Platform before governance. Tech cannot fix an undefined appetite or an unwired committee.
- A qualitative-only register. Boards need quantified top risks; 5×5 heat maps are a communication layer, not an analysis.
- Risk appetite written once and never breached. If you have no breach events, your thresholds are wrong.
- Compliance owning the register. Compliance is a customer of the register, not the owner; ownership belongs to the first line, challenged by the second.
- KRIs without escalation. A dashboard without a triggered response is a vanity project.
- Third-party risk outside the register. If a vendor outage would take you down, it belongs on the same list as your own risks.
- No lessons-learned loop. Every material incident must close with an update to appetite, KRIs, or controls; otherwise the integrated risk management approach calcifies.
The Next Wave: Where the Integrated Risk Management Approach Is Heading
Three shifts will define the next 24 months for anyone running an integrated risk management approach. Ignoring any of them is a governance failure you will have to explain to regulators within a board cycle.
AI risk is collapsing into enterprise risk. The NIST AI Risk Management Framework and the EU AI Act are forcing boards to treat AI exposures — model bias, data leakage, third-party model risk, automation failures — as first-class risks. Expect the CRO, CISO, and Chief Data Officer roles to merge at the top of the risk stack within three years.
Operational resilience is eating BCM. DORA in the EU, the PRA’s operational resilience rules in the UK, and APRA’s CPS 230 in Australia all force firms to publish impact tolerances and prove they can recover inside them. The integrated risk management approach that does not include a living business impact analysis and tested playbooks is already obsolete.
Climate and nature risk are moving from ESG to core risk. The SEC climate disclosure rule, the TNFD nature-related disclosure framework, and climate transition risk assessment practice are making climate a balance-sheet issue, not a communications one. Programs that still file climate under “sustainability” are behind.
Frequently Asked Questions About the Integrated Risk Management Approach
What is an integrated risk management approach in simple terms?
An integrated risk management approach is a single operating model for identifying, assessing, and managing every category of risk under one taxonomy, one appetite, and one register.
Gartner defines it as a set of practices and processes that provide a risk-aware culture and integrated technology view. In plain language: cyber, compliance, operational, and strategic risk stop running in isolation; the integrated risk management approach forces shared rubrics, shared KRIs, and shared reporting to the board.
How does an integrated risk management approach differ from ERM?
Enterprise risk management is the discipline. The integrated risk management approach is the execution pattern — the day-to-day wiring that turns ERM principles into a working operating model. COSO ERM 2017 and ISO 31000:2018 are the standards; the integrated risk management approach is how they live in the business.
What are the main benefits of an integrated risk management approach?
The integrated risk management approach lowers breach exposure (27% vs 46% for siloed organizations per Secureframe 2026), cuts audit fatigue by 30-50%, shortens board cycles, and reveals correlated risks earlier. It also defends the organization against regulatory expectations in DORA, the SEC climate rule, and the EU AI Act.
Which frameworks support an integrated risk management approach?
ISO 31000:2018 provides the principles and process; COSO ERM 2017 provides the strategy-integrated structure; the IIA Three Lines Model provides the governance wiring. A credible integrated risk management approach uses all three together, not one in isolation.
How long does it take to implement an integrated risk management approach?
Twelve to eighteen months for a mid-sized organization to reach “defined” maturity on the integrated risk management approach curve, and three to five years to reach “optimized”. Accelerators: strong CRO, existing KRI culture, unified risk taxonomy. Blockers: committee sprawl and platform-first procurement.
What KRIs should an integrated risk management approach monitor?
Pick 25-40 enterprise KRIs across cyber (mean time to detect, patch latency), operational (downtime, near-miss rate), compliance (issue aging, regulatory findings), financial (liquidity coverage, covenant headroom), and third-party (vendor concentration, breach notifications). Every KRI in an integrated risk management approach must have green/amber/red thresholds tied to appetite, or it is not a KRI.
Is an integrated risk management approach the same as GRC software?
No. Governance, risk, and compliance (GRC) software can support an integrated risk management approach, but the approach is the governance and process discipline. Organizations that buy GRC platforms without doing the governance work end up with expensive filing cabinets.
The Bottom Line on the Integrated Risk Management Approach
The integrated risk management approach is no longer a competitive advantage. It is the baseline that regulators, boards, and investors assume you already run.
The OECD Principles of Corporate Governance and the FSB operational resilience toolkit both make integration an explicit governance expectation. Organizations that stay siloed are paying an unwritten tax: higher breach rates, slower board decisions, lost audit productivity, and regulatory findings that would not survive an integrated evidence trail.
The playbook is not secret. Wire the governance first. Set quantitative appetite. Build one taxonomy and one register. Deploy KRIs with thresholds.
Report to the board with quant and qual together. Close the lessons loop. Everything else — the platform, the AI tools, the consultant deck — is support. Start the next board cycle by asking which of the seven stages in this guide your organization has actually completed. That is the first honest conversation.
