Two assessors evaluate the same operational risk in the same workshop. One scores Likelihood in Risk Assessment as 3 (Possible).
The other scores 4 (Likely). Neither can articulate why.
The risk register accepts both scores. The heat map loses its meaning before it reaches the board pack. That is the gap between an undefined scale and the calibrated probability ranges every US regulator now expects.
| The Likelihood in Risk Assessment Cheat Sheet |
| Likelihood is the probability or frequency that a risk event occurs within a defined time period. ISO 31000:2018 Clause 6.4.3 requires it to be determined alongside consequences for every identified risk, after accounting for existing controls. |
| A documented 5-point scale with probability ranges, frequency equivalents, and anchor examples is the single biggest driver of consistent scoring. Without it, two assessors will score the same risk differently and the heat map loses meaning. |
| Likelihood and impact are independent axes. Conflating them (scoring a risk high because consequences are severe, even when probability is low) is the most common scoring error in practice. |
| Three estimation methods: qualitative (expert judgment on a defined scale), semi-quantitative (FMEA, bow-tie, fault tree), and quantitative (statistical analysis, Monte Carlo, actuarial). Most US programs run qualitative across the register and quantitative on the top 10-15 risks. |
| Preventive controls reduce probability and lower the likelihood score. Detective controls do not reduce likelihood; they reduce impact duration. The register must show inherent and residual likelihood for every risk. |
| A 90-day roadmap takes a US program from undefined likelihood scoring to a calibrated, documented scale wired into the risk register and the workshop agenda. |
| Velocity (speed of onset) is emerging as a third axis alongside likelihood and impact, recognized in IEC/ISO 31010 commentary and in leading US GRC platforms in 2026. |
Likelihood is one half of every risk score. Impact is the other half.
Multiply them and you get the rating that drives treatment, resource allocation, and board reporting. Impact scales tend to be well-defined.
A $1M loss is clearly different from a $10M loss. Likelihood scales, by contrast, are often vague.
‘Possible’ versus ‘Likely’ versus ‘Almost Certain’ without probability ranges, frequency benchmarks, or calibration examples is not analysis. It is opinion.
The relevant standards are clear. ISO 31000:2018 Clause 6.4.3 (Risk Analysis) requires organizations to determine the likelihood and consequences of each identified risk, considering existing controls.
IEC 31010:2019 (Risk Assessment Techniques) lists more than 30 techniques for estimating likelihood, from qualitative scales to Monte Carlo simulation. COSO ERM Principle 11 (Assesses Severity of Risk) requires both axes to prioritize against risk appetite.
ISO 22301:2019 (Business Continuity Management) carries the parallel discipline for continuity-side risks, and the FFIEC IT Examination Handbook sets the equivalent expectation for US financial institutions. The frameworks converge on one rule: a likelihood score without a documented basis is a guess wearing a number.

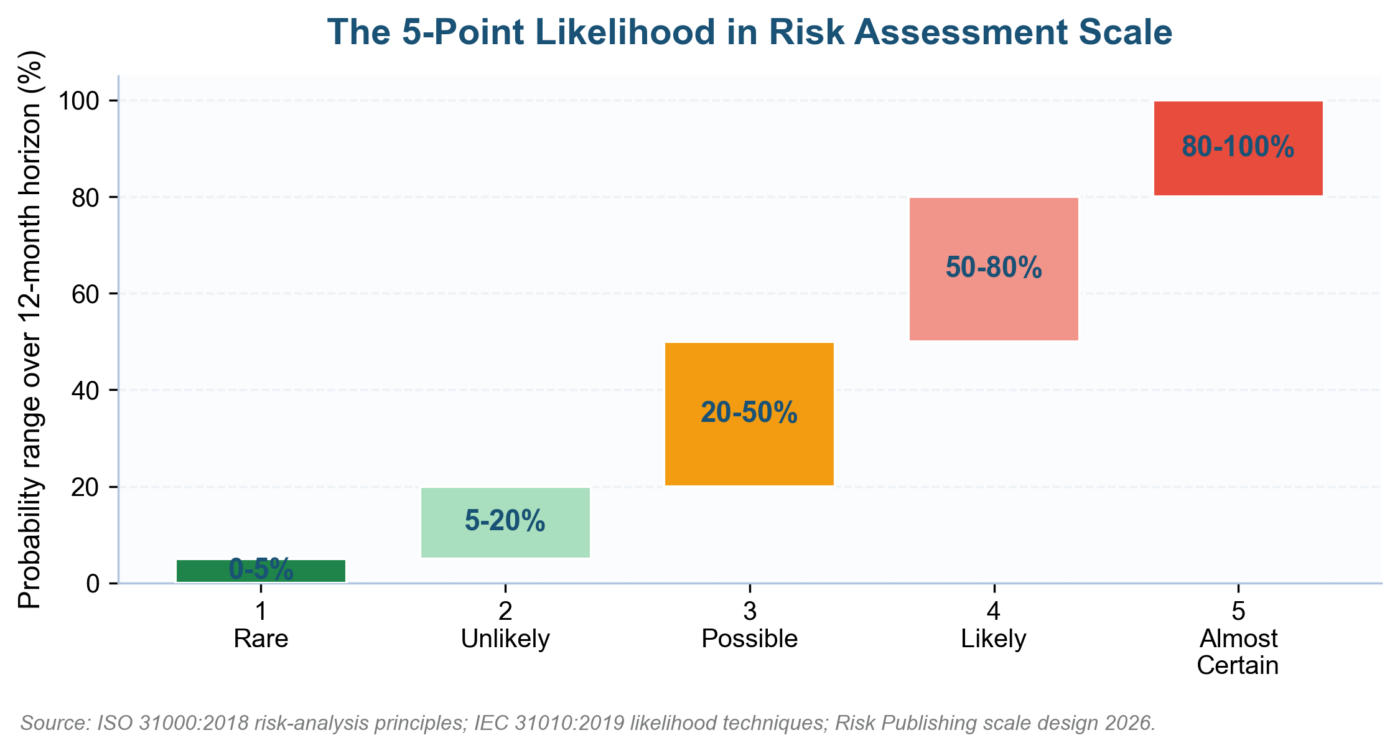

Figure 1. The 5-point Likelihood in Risk Assessment scale with probability ranges.
Defining Likelihood in Risk Assessment: Probability, Frequency, Plausibility
Likelihood in Risk Assessment can be expressed in three ways. Probability is a percentage chance over a defined time period. Frequency is the expected number of events per period.
Plausibility is a qualitative judgment of whether the event could reasonably occur. Strong US programs use all three across the register, matching the expression to the data available for each risk.
The Three Expressions of Likelihood in Risk Assessment
| Expression | Definition | When to use | Worked example |
| Probability (%) | Percentage chance the event occurs in a defined time period (typically 12 months) | Quantitative analyses; risks with sufficient historical data; actuarial work | 15% probability of a ransomware attack in the next 12 months |
| Frequency | Expected number of occurrences per defined time period | Operational risks with recurring events; compliance violation rates; IT outage counts | 3 data-quality errors per quarter requiring customer notification |
| Plausibility | Qualitative judgment of whether the event could reasonably occur given current conditions | Emerging risks; strategic risks; black-swan events; risks with no organizational precedent | Coordinated nation-state attack on US payment infrastructure |
The 5-Point Likelihood in Risk Assessment Scale
The 5-point scale is the workhorse for Likelihood in Risk Assessment in US enterprise programs. It has enough granularity to separate Rare from Unlikely and Likely from Almost Certain without forcing every score into a 3-point Low / Medium / High default. The scale below ties each level to an explicit probability range, a frequency equivalent, and an anchor example that assessors reference during workshops.
The 5-Point Likelihood in Risk Assessment Scale With Anchor Examples
| Score | Label | Probability | Frequency | Anchor example |
| 1 | Rare | < 5% | Less than once in 20 years | Magnitude 7.0 earthquake at HQ in a seismically inactive zone; simultaneous failure of three independent power feeds |
| 2 | Unlikely | 5-20% | Once in 5-20 years | Key supplier bankruptcy; regulatory regime change eliminating a major product line |
| 3 | Possible | 20-50% | Once in 2-5 years | Targeted phishing succeeds against an employee; a key employee resigns from a critical role |
| 4 | Likely | 50-80% | Once in 1-2 years | Customer complaint escalates to a regulatory inquiry; a minor data-quality error causes incorrect billing |
| 5 | Almost Certain | > 80% | More than once per year | Attempted unauthorized access to the network; a project milestone slips due to resource constraints |
Usage rule: every assessor references both the probability range and the anchor example when scoring. A claim that a risk is Likely (4) needs a stated rationale in the 50-80% probability band or in the once-in-1-to-2-years frequency band.
Workshop facilitators challenge any score that lacks a rationale. That challenge is what turns a vague qualitative scale into a calibrated one.
Likelihood in Risk Assessment in the Risk Matrix
The Likelihood in Risk Assessment scale forms one axis of the risk matrix. Combined with impact, it produces the score that drives prioritization, treatment, and reporting. The standard 5×5 matrix below shows where each score band sits in the green / amber / orange / red treatment zones used by most US enterprise programs.

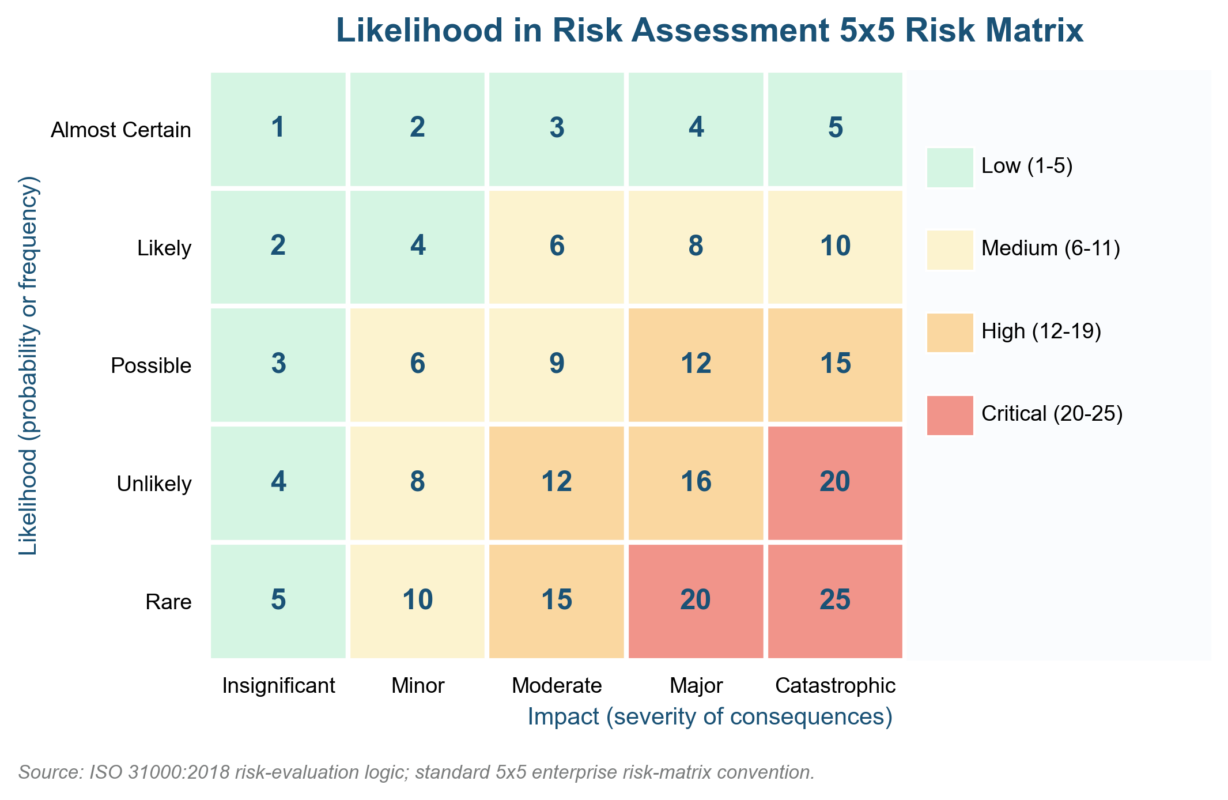

Figure 2. The 5×5 risk matrix combining Likelihood in Risk Assessment with impact.
Risk Score Bands and Treatment Actions
| Score range | Risk level | Treatment action | Board reporting |
| 20-25 | Critical (Red) | Mandatory treatment. Risk exceeds appetite. Escalate to executive risk committee. Treatment plan within 14 days. | Reported individually to the board with root cause and target residual score |
| 12-19 | High (Orange) | Treatment required. Risk approaches or exceeds appetite. Treatment plan within 30 days. Owner accountability enforced. | Top-risks section of the quarterly board risk report |
| 6-11 | Medium (Amber) | Monitor and reduce where cost-effective. Risk within or near appetite. Accept if treatment cost exceeds benefit. | Aggregate in the quarterly risk report; detail if trending upward |
| 1-5 | Low (Green) | Accept and monitor. Risk well within appetite. No treatment unless conditions change. | Annual comprehensive risk assessment only |
The matrix illustrates why Likelihood in Risk Assessment calibration matters. A risk scored Possible (3) times Major (4) lands at 12 (High) and triggers a 30-day treatment plan. The same risk scored Likely (4) times Major (4) lands at 16 (still High but approaching Critical) and triggers escalation.
A one-point difference in likelihood changes the organizational response. If assessors cannot consistently distinguish Possible from Likely, the matrix produces unreliable prioritization.
Three Methods for Estimating Likelihood in Risk Assessment
Three methods estimate Likelihood in Risk Assessment, and each fits a different risk profile. Qualitative assessment relies on expert judgment mapped to a defined scale.
Semi-quantitative methods (FMEA, bow-tie, fault tree, event tree) produce numerical scores from structured qualitative inputs. Quantitative methods (statistical analysis of historical data, Monte Carlo, actuarial models) produce probability distributions with confidence intervals.
Comparing Likelihood in Risk Assessment Methods
| Method | How it works | Data needed | Best fit |
| Qualitative | Assessors assign 1-5 score using expert judgment, anchor examples, and facilitated discussion | Expert knowledge; industry experience; calibration anchors | All risks at first pass; programs early in ERM maturity; risks with limited data |
| Semi-quantitative | Structured techniques produce numerical scores from qualitative inputs (FMEA, bow-tie, FTA, ETA) | Expert judgment structured by the technique; control-effectiveness assessments; partial historical data | Engineering and operational risks; risks with mappable causal chains; risks needing control-effectiveness analysis |
| Quantitative | Statistical analysis, Monte Carlo, Bayesian inference; output is a probability distribution with confidence interval | Historical incident data; financial loss data; modeling expertise; simulation software | Top 10-15 priority risks; financial risks; insurance / actuarial; capital allocation; regulatory stress testing |
Most US programs use qualitative for the full register (50+ risks in a typical enterprise) and quantitative on the top 10-15 risks where the financial exposure justifies the analytical investment. Deloitte’s risk-management insights track the same split across US Fortune 500 programs.
The Federal Reserve SR 11-7 model risk guidance sets the bar for the quantitative tier in financial services. The OCC operational risk guidance reinforces it for US banks.
Calibrating Likelihood in Risk Assessment Scores: Four Techniques
Calibration is what makes Likelihood in Risk Assessment scores comparable across assessors, business units, and time. Without calibration, the same risk gets different scores from different assessors, and the heat map turns into a Rorschach test. Four techniques work in combination: anchor examples, historical benchmarking, probability training, and cross-assessment review.

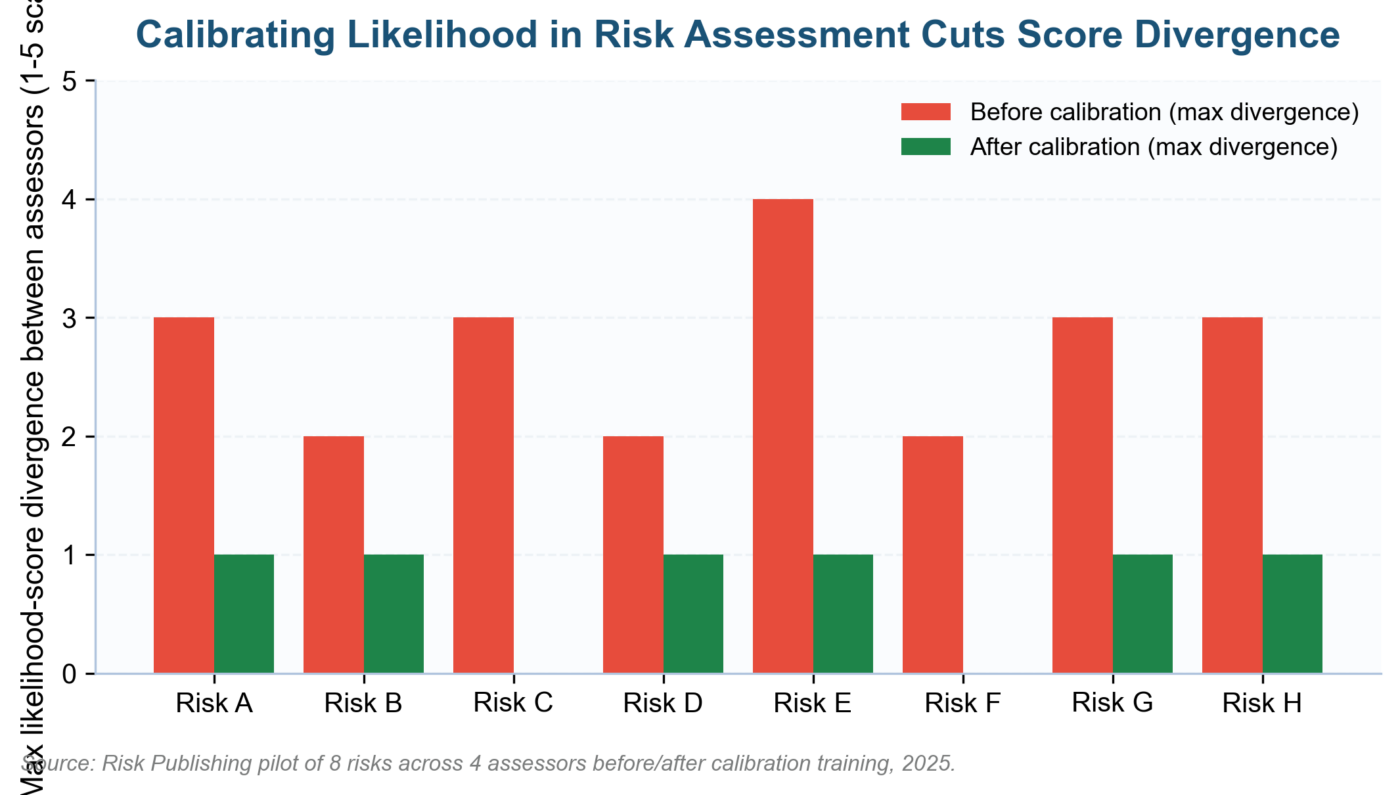

Figure 3. Calibration training cuts Likelihood in Risk Assessment divergence between assessors.
Four Calibration Techniques for Likelihood in Risk Assessment
| Technique | How it works | When to use |
| Anchor examples | Provide 2-3 concrete scenarios for each likelihood level that assessors reference when scoring | Always; include in scale documentation; refresh annually after major incidents |
| Historical benchmarking | Map historical incident data to scale levels; count how many times each risk category materialized over the past 5-10 years | Programs with 5+ years of incident data; operational risk categories with measurable event frequencies |
| Probability training | Train assessors to distinguish probability bands using calibration exercises (probability wheel, known-event estimation) | Before the first workshop with new assessors; annually as a refresher; whenever scoring divergence is identified |
| Cross-assessment review | Compare scores from different assessors for the same risk; facilitate discussion where divergence exceeds 1 point | After every workshop; during the annual register refresh; when aggregating scores from multiple business units |
Document the calibration discussion and the rationale for the final agreed score. The audit trail demonstrates that scoring was deliberate and challenged, which is what regulators and the IIA Three Lines Model expect from a mature second-line function. KPMG’s 2025 Risk and Resilience Survey puts calibrated likelihood scoring among the practices that separate top-quartile US programs from the rest.
How Controls Modify Likelihood in Risk Assessment
Preventive controls reduce the probability of the risk event and therefore lower the Likelihood in Risk Assessment score. Detective controls do not reduce likelihood. They identify the event faster and reduce the duration of impact.
Both belong on the register, but only preventive controls move the residual likelihood score down. Confusing the two is the recurring cause of inflated residual scoring.

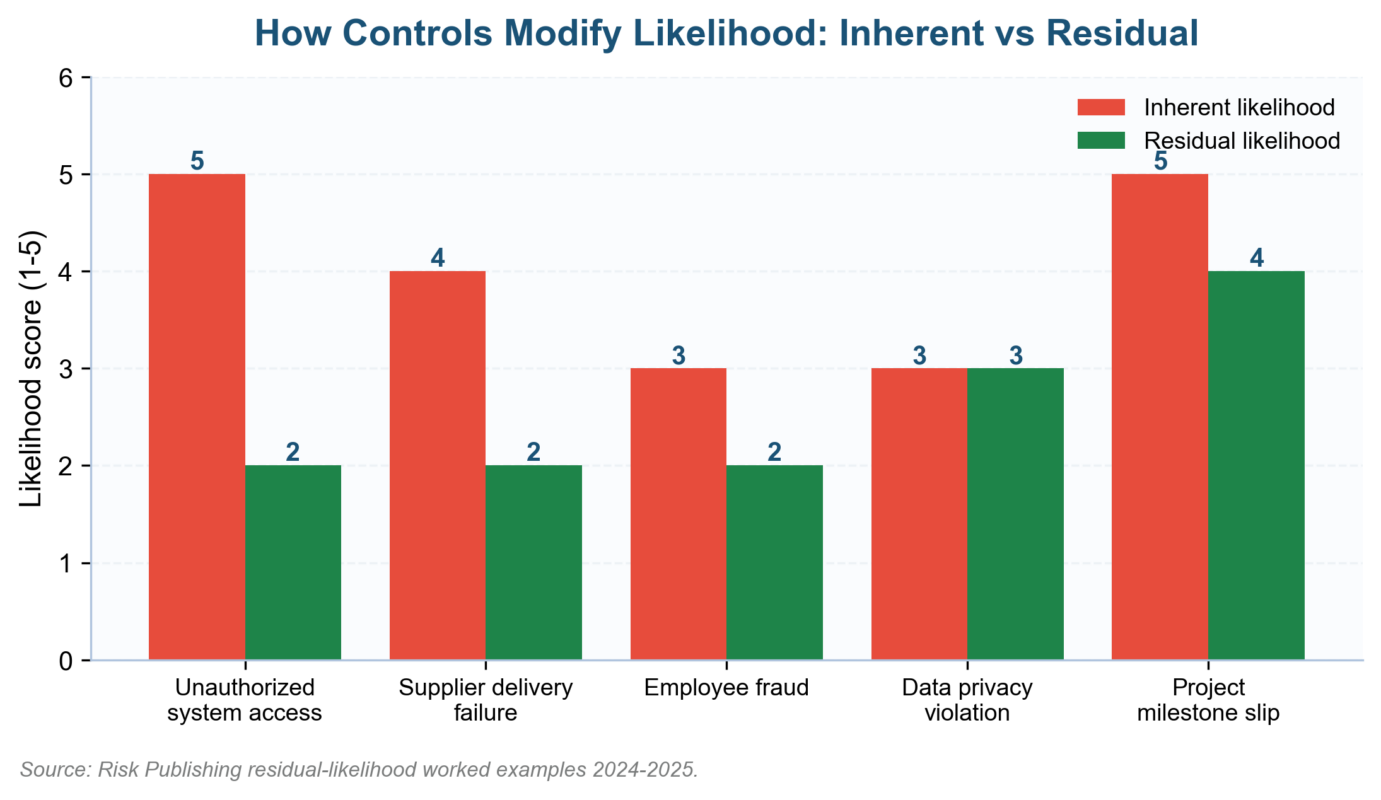

Figure 4. How preventive controls move Likelihood in Risk Assessment from inherent to residual.
Worked Inherent vs Residual Likelihood in Risk Assessment Examples
| Risk | Inherent | Key preventive controls (effectiveness) | Residual | Reduction |
| Unauthorized system access | 5 | MFA + RBAC + PAM + awareness training (strong; 99.7% blocked) | 2 | 3 levels |
| Supplier delivery failure | 4 | Dual sourcing + 8-week safety stock + KRI monitoring (moderate) | 2 | 2 levels |
| Employee fraud | 3 | Segregation of duties + screening + transaction monitoring + whistleblower hotline (moderate-strong) | 2 | 1 level |
| Data privacy violation | 3 | DPO + PIA + data-subject rights + training + audit (moderate; cyber controls separate) | 3 | 0 levels |
| Project milestone slip | 5 | Critical-path schedule + weekly steerco + dependency-buffer (weak-moderate) | 4 | 1 level |
The privacy violation row illustrates a critical distinction. Privacy controls do not change the likelihood of a data breach (cyber controls do that).
Privacy controls change the regulatory penalty severity by demonstrating due diligence. When scoring residual Likelihood in Risk Assessment, identify which controls actually affect the probability of the event.
Controls that exist in the general vicinity of the risk are not the same as controls that affect the probability. The ISO 31000 risk management lifecycle gives the framework discipline.
The inherent versus residual risk approach gives the scoring discipline. The NIST Risk Management Framework gives the federal-aligned reference for cyber risks.
Common Likelihood in Risk Assessment Scoring Errors
Most stalled US Likelihood in Risk Assessment programs fail in predictable ways. The errors below come up most often during workshop reviews and second-line challenge sessions. Use the table as a self-audit before the next risk-committee meeting, not after the next regulator finding.

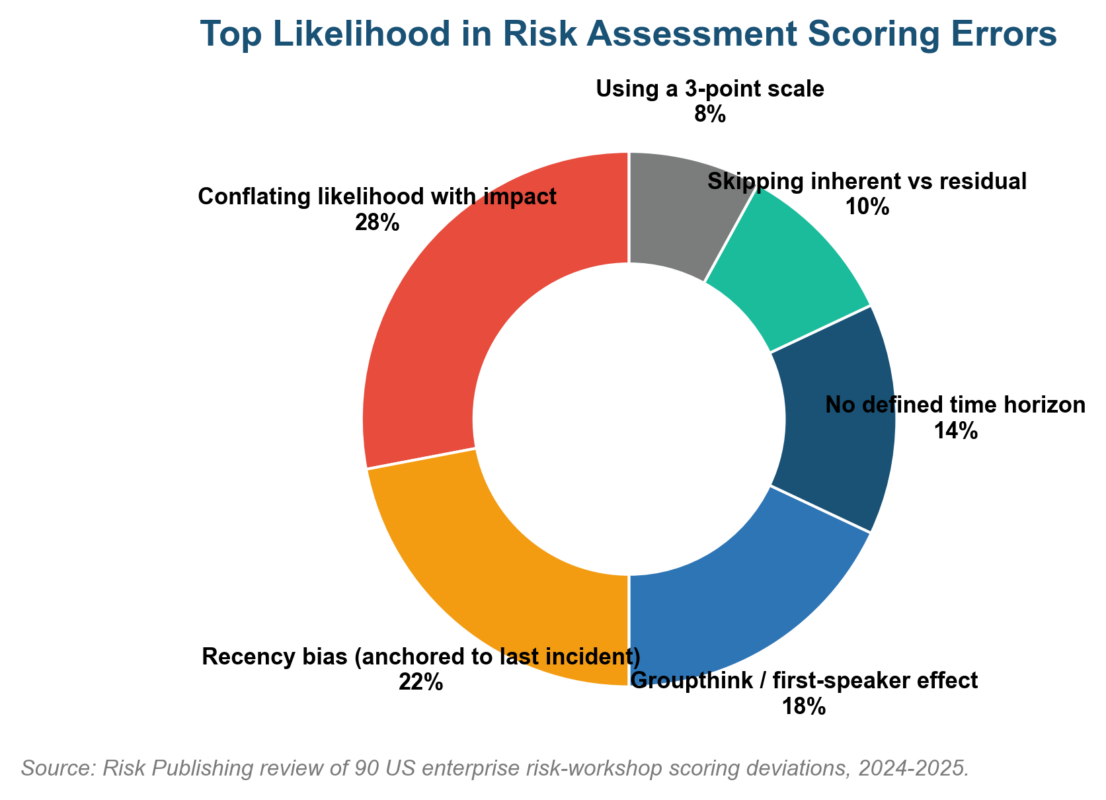

Figure 5. Top Likelihood in Risk Assessment scoring errors and their relative frequency.
Common Likelihood in Risk Assessment Errors and Corrections
| Error | Why it happens | How to correct |
| Conflating likelihood with impact | Severe consequences bias the probability estimate upward (catastrophe-feels-likely) | Score likelihood and impact separately. Complete all likelihood scores before discussing impact. |
| Recency bias | An event last month gets scored 5; assessors anchor to the most recent occurrence | Use historical benchmarking. Ask: how many times has this happened over the past 10 years, not when it last happened. |
| Groupthink in workshops | First or most senior speaker sets the score; others align to avoid conflict | Silent individual scoring before group discussion. Facilitator displays the range; discussion focuses on divergent scores. |
| No defined time horizon | Assessors score without specifying 12 months, 5 years, or project duration | Define the horizon in the scale header. Standard enterprise: 12 months. Project: project duration. State at workshop start. |
| Skipping inherent vs residual | Assessors jump to residual without evaluating control effectiveness | Mandatory four-column scoring: inherent likelihood, key controls, control effectiveness, residual likelihood. Residual must be evidence-justified. |
| Using a 3-point scale | Forces clustering at Medium; no discrimination between adjacent risks | Use a 5-point scale at minimum. Granularity drives differentiation; differentiation drives prioritization. |
| Ignoring velocity | Two risks with the same likelihood and impact can have radically different speeds of onset | Add velocity as a third axis on Tier-1 risks; flag fast-onset risks for accelerated treatment cycles |
A 90-Day Likelihood in Risk Assessment Implementation Roadmap
A working Likelihood in Risk Assessment program does not need a 12-month consulting engagement. Ninety days is enough to take a US enterprise from undefined scoring to a calibrated, documented scale wired into the risk register and the workshop agenda.
90-Day Roadmap for Likelihood in Risk Assessment
| Phase | Actions | Deliverables | Success metrics |
| Days 1-30: Define | Adopt or customize the 5-point scale with probability ranges, frequency equivalents, and anchor examples; develop org-specific anchors using historical incident data; document in risk procedures; distribute to all assessors | Documented 5-point scale; org-specific anchor examples; updated risk procedures | Scale approved by CRO; anchors reviewed by business-unit champions; procedures accessible to assessors |
| Days 31-60: Calibrate and train | Run probability training (calibration exercises, probability wheel); pilot scale in one business unit; compare pilot scores against historical data; refine anchors based on feedback | Training records; pilot risk-assessment results; calibration validation report; refined anchor examples | 80%+ assessors trained; pilot completed with calibrated scores; no likelihood score differs by more than 1 point between assessors for the same risk |
| Days 61-90: Deploy and integrate | Roll calibrated scale to all business units in the annual cycle; update register template to four-column likelihood model; produce first heat map with calibrated scores; present to risk committee | Enterprise risk assessment using calibrated scale; updated register; first calibrated heat map; risk-committee presentation | All business units use the scale; register shows inherent and residual likelihood for 100% of risks; risk committee acknowledges the rigor improvement |
Frequently Asked Questions About Likelihood in Risk Assessment
What is Likelihood in Risk Assessment in plain language?
Likelihood in Risk Assessment is the probability or frequency that a risk event occurs within a defined time period, typically 12 months. It is one of the two axes of every risk matrix; impact is the other.
ISO 31000:2018 Clause 6.4.3 requires both to be assessed for every identified risk, after considering existing controls. Quantified scoring makes it defensible. Anchor examples make it consistent.
How is Likelihood in Risk Assessment different from impact?
Likelihood asks how often or how probably the event happens. Impact asks how bad it would be if it does. The two axes are independent.
A high-impact risk can have low likelihood (asteroid strike) and a low-impact risk can have high likelihood (minor billing errors). Multiplying the two gives the risk score that drives prioritization. Conflating the two axes is the most common scoring error in US enterprise risk workshops.
What scale should I use for Likelihood in Risk Assessment?
A 5-point scale is the standard for enterprise programs. Each level needs an explicit probability range (Rare under 5%, Unlikely 5-20%, Possible 20-50%, Likely 50-80%, Almost Certain over 80%), a frequency equivalent, and 2-3 anchor examples.
A 3-point scale forces every score to Medium and produces a heat map with no discrimination. A 7-point scale adds noise without adding decision value. Five is the answer.
How do I calibrate Likelihood in Risk Assessment across a workshop?
Use four techniques in combination: anchor examples in the scale documentation, historical benchmarking against the organization’s incident data, probability training before the first workshop, and cross-assessment review where scores diverge by more than one point. Document the discussion and the rationale for each final score.
The audit trail is what regulators and the IIA Three Lines Model expect from a mature second-line function. Preventive controls reduce the probability of the risk event occurring and therefore reduce the Likelihood in Risk Assessment score from inherent to residual.
How do controls change the Likelihood in Risk Assessment score?
Detective controls do not change likelihood; they identify the event faster and reduce the duration of impact. The register should show four columns: inherent likelihood, key preventive controls, control effectiveness, residual likelihood. Skipping any one of the four turns the residual score into a guess.
What time horizon should Likelihood in Risk Assessment use?
State the time horizon explicitly in the scale header and at the start of every workshop. The standard for enterprise risk assessments is 12 months.
Project risk assessments use the project duration. Strategic and emerging-risk assessments may use 3-5 years. A risk that scores Unlikely in 12 months may score Almost Certain over 10 years; the horizon must be fixed before any score is recorded.
How does Likelihood in Risk Assessment fit into ISO 31000 and COSO ERM?
ISO 31000:2018 Clause 6.4.3 (Risk Analysis) requires likelihood and consequences to be determined for every identified risk, considering existing controls. IEC 31010:2019 lists more than 30 techniques for estimating likelihood.
COSO ERM Principle 11 (Assesses Severity of Risk) requires both axes for prioritization against risk appetite. The 5-point scale operationalizes those framework requirements in a workshop-ready format.
Where does Likelihood in Risk Assessment fall short?
Qualitative likelihood scoring depends on assessor calibration. Without it, the scale produces inconsistent scores.
Even calibrated qualitative scores have wider error bars than quantitative analysis. For Tier-1 risks with sufficient historical data, complement the qualitative assessment with Monte Carlo simulation, statistical incident-rate analysis, or actuarial modeling.
The Forrester State of Enterprise Risk Management 2025 finds that top-quartile US programs always layer quantitative analysis on top of the qualitative scale. McKinsey risk insights report a similar pattern across S&P 500 risk functions.
Where Likelihood in Risk Assessment Is Heading: 2026-2028
The Likelihood in Risk Assessment discipline is mid-shift. Three shifts will shape the next 24 months for US programs: AI-assisted likelihood estimation, dynamic continuous scoring driven by KRI feeds, and the formal addition of velocity as a third axis alongside likelihood and impact.
AI-assisted likelihood estimation is starting to supplement expert judgment. Models trained on industry incident databases, regulatory enforcement data, and the organization’s own loss history generate probability estimates that assessors use as starting points. The estimates do not replace human judgment.
They reduce the calibration burden and give assessors an objective baseline to test their subjective scores against. Anchored to the NIST AI Risk Management Framework governance posture, AI-assisted likelihood has moved from research into US enterprise pilots.
Dynamic likelihood scoring is replacing static annual workshops. Traditional risk assessments score likelihood once a year. Leading US programs now update scores continuously from KRI feeds.
When a KRI threshold is breached (for example, phishing attempts double in a quarter), the likelihood score for the associated risk auto-flags for re-evaluation. The shift from annual to continuous reassessment means the register reflects current conditions, not last year’s judgment.
Velocity (speed of onset) is emerging as a third axis. Two risks may share the same likelihood and impact, but one materializes over months and the other materializes in hours. The first leaves a response window.
The second leaves none. IEC 31010 commentary and several US GRC platforms now support velocity scoring alongside likelihood and impact. CISA’s risk-management guidance and ENISA’s risk-management framework both treat velocity as a first-class consideration for cyber and infrastructure risks.
