In November 2024, a Fortune 200 US retailer attempted a single-weekend cutover from an on-premise ERP to a hyperscaler tenant. The data migration risk assessment template the program team signed off in March rated the cutover risk as “moderate.”

By Sunday afternoon, 18 stores could not process card payments, the SEC 10-Q draft had to be paused, and the post-mortem put the real cost at $42 million. The template existed. It just did not score what mattered.

The gap between “we have a data migration risk assessment template” and “ours would have caught that” is what this guide closes.

We walk through the eight components a modern US data migration risk assessment template must include, a defensible scoring matrix, the workflow that survives SEC Item 1.05 disclosure, and the three regulatory shifts that are reshaping the work right now.

What every US risk owner needs to know about the data migration risk assessment template
Eighty-three percent of US data migration projects either fail outright or exceed budget and timeline. A data migration risk assessment template that does not score cutover, rollback, and reconciliation is the single biggest reason that figure persists year over year.
The 2025 DevOps Migration Index pegs the average migration loss at $315,000 per project, with 57 percent of IT leaders spending more than $1 million on a single platform move. Your data migration risk assessment template must price both direct overrun and operational drag.
Migration downtime now costs US large enterprises between $300,000 and $540,000 per hour. The data migration risk assessment template needs an availability score that maps cutover windows to real dollars, not a generic five-point scale.
Nearly 90 percent of US cloud migration breaches trace to misconfigured storage, weak identity controls, or incomplete encryption. The data migration risk assessment template must score each of those discrete root causes, not lump them into a single security row.
SEC Item 1.05 of Form 8-K and the amended Regulation S-P now make material data loss during migration a four-business-day disclosure event. The data migration risk assessment template must contain a materiality trigger, not just a likelihood-impact matrix.
Migrations that stretch past twelve months see cost overruns climb from 18 percent to 30 percent or higher. A data migration risk assessment template that does not include duration as an explicit risk dimension will under-rate the most expensive failure mode.

The audience is specific: chief information officers, data platform owners, GRC leads, and risk managers running US enterprise migrations to cloud, ERP, EHR, or core-banking targets.

For the broader enterprise risk management view that sits above the data migration risk assessment template, our framework piece maps migration controls to a firm-wide taxonomy boards and audit committees will recognize immediately.

Why Every Data Migration Risk Assessment Template Needs a 2026 Refresh

Three regulatory shifts have rendered the 2022-era data migration risk assessment template obsolete in the United States.

The first is SEC Item 1.05 of Form 8-K, in force since December 2023, which forces public registrants to disclose material cybersecurity and data-loss incidents within four business days of materiality determination.

If your current template lacks a materiality determination workflow at cutover, it cannot defend the timeline the SEC will reconstruct after the fact.

A second shift came from the SEC’s own staff. In May 2024, Director Erik Gerding clarified that Item 1.05 was designed for material incidents only, and that voluntary disclosures should live in Item 8.01.

The guidance has practical implications for the data migration risk assessment template. It makes the materiality threshold a scoring output, not a binary judgment call by counsel during a live cutover when nobody has time to argue.

A third shift is the NIST post-quantum cryptography migration mapping published in September 2025. NCCoE’s white paper CSWP 48 maps PQC migration capabilities to NIST CSF 2.0 controls.

Any data migration risk assessment template built before that mapping silently under-scores cryptographic risk during multi-year platform moves, the exact moves the SEC and OCC now expect boards to oversee in writing.

Data Migration Risk Assessment Template: The 2026 US Practitioner's Guide
Data Migration Risk Assessment Template: The 2026 US Practitioner's Guide

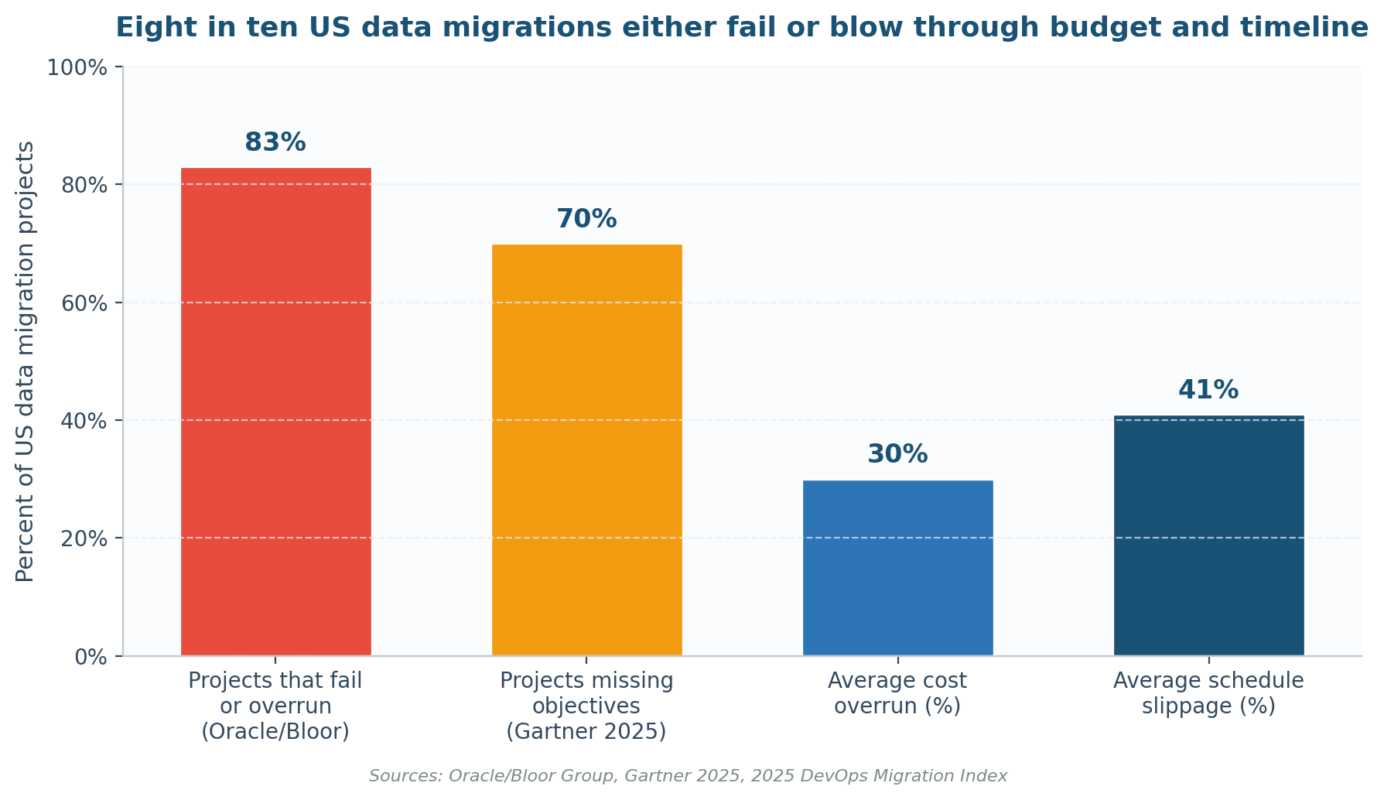

Figure 1: Eight in ten US data migrations fail or overrun budget and timeline, with average cost overrun near 30 percent.

The economic case for refreshing the template matches the regulatory case. Oracle’s analysis of Bloor Group data found that 83 percent of US data migration projects either fail outright or significantly exceed budget and schedule, with average cost overrun near 30 percent and schedule slippage averaging 41 percent.

A data migration risk assessment template that does not price duration risk is, in practice, ignoring the largest predictive driver of overrun the data identifies.

The Eight Components Your Data Migration Risk Assessment Template Must Include

Most data migration risk assessment template failures trace back to a missing component, not a flawed methodology.

eight components below come from cross-walking the NIST SP 800-30 risk assessment guide against NIST SP 800-53 Rev. 5, ISO 27001:2022, and the SEC and OCC migration expectations. Build the template around these eight once and you will not have to rebuild it when the next federal rule lands.

Our risk register template and guide applies the same one-parent-per-risk discipline. Firms that skip the taxonomy step end up with overlapping rows, double-counted controls, and a board pack the audit committee cannot interpret. ,

The data migration risk assessment template is where that taxonomy discipline pays off most visibly. Every line traces back to one of the eight components.

#Template componentWhat it capturesPrimary US regulatory or framework anchor
1Data asset inventoryEvery source system, target tenant, staging zone, and reconciliation table touched by the migrationNIST CSF 2.0 ID.AM; NIST SP 800-53 CM-8
2Threat scenario catalogCutover failure, partial load, encryption-in-transit failure, IAM misconfiguration, vendor breach, rollback failure, latency spikeNIST SP 800-30 Appendix E; Verizon DBIR threat taxonomy
3Vulnerability and control mappingEach scenario mapped to current controls (encryption, IAM, change management, observability) with effectiveness ratingNIST CSF 2.0 PR/DE; ISO 27001 Annex A; PCI DSS 4.0
4Likelihood-impact scoringFive-by-five matrix scored at cutover and steady-state, with availability and confidentiality on separate axesNIST SP 800-30 Tables H-2, H-3, I-2
5Cutover and rollback playbookSequence, decision gates, abort criteria, parallel-run window, data reconciliation sign-off, comms treeOCC IT Operations Booklet; FFIEC Operations chapter
6Materiality determination logicQuantitative and qualitative triggers that drive SEC Item 1.05, Reg S-P, and state AG notice during or post-migrationSEC Item 1.05; Reg S-P amended (2024); state breach statutes
7Vendor and tooling riskHyperscaler, migration vendor, ETL vendor, and managed service shared-responsibility deltas during the moveNIST SP 800-161; OCC Third-Party Risk Bulletin 2023-17
8Continuous monitoring and refreshPre-go-live tabletop, daily cutover stand-ups, 30/60/90-day post-move reassessment, board readout cadenceNIST SP 800-30 §3.2; SEC Form 10-K Item 1C

The eight-component structure is not academic. It maps to the evidence bundles a HIPAA Security Rule auditor, SEC examiner, or FTC investigator will ask for in writing after a failed cutover.

Audit cycles compress materially when the firm can present a single eight-bucket data migration risk assessment template that ties to the program plan, the change record, and the post-incident report.

For an information-security-specific cross-walk, our ISO 27001 risk assessment template maps Annex A controls to the migration scenarios above and is the cleanest companion artifact when an SOC 2 or ISO 27001 auditor inspects the cutover evidence.

Pair it with the data migration risk assessment template rather than treating the two as separate workstreams. The same eight components govern both artifacts in any defensible setup.

Mapping the Threat Landscape: Where Data Migration Risk Assessment Template Scoring Begins

Threat selection is the first place a data migration risk assessment template earns or loses credibility.

The Cloud Security Alliance post-mortem of the 2024 Snowflake incidents found that nearly 90 percent of US cloud migration breaches in 2024 traced to three root causes: misconfigured storage, weak identity and access management, and incomplete encryption in transit. Score those as separate scenarios, not a single security row.

Data Migration Risk Assessment Template: The 2026 US Practitioner's Guide
Data Migration Risk Assessment Template: The 2026 US Practitioner's Guide

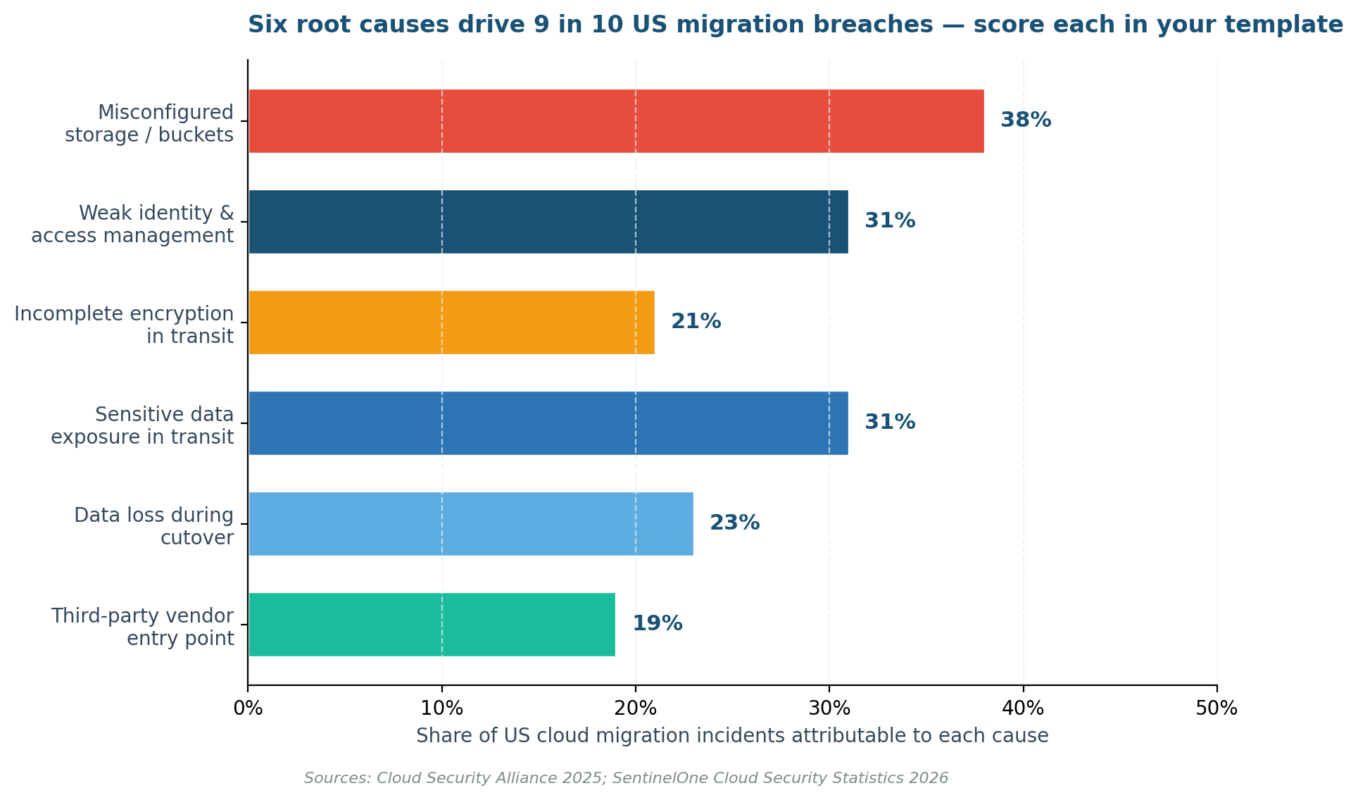

Figure 2: Six root causes drive nine in ten US migration breaches. The template must score each one discretely.

Cutover risk is the scenario most templates treat the worst. The cutover window is when source and target are both partially authoritative, when rollback is materially constrained, and when Verizon Data Breach Investigations Report telemetry shows credential abuse spikes.

A data migration risk assessment template that does not score the cutover window separately from steady-state will systematically under-rate the period when the firm carries the most exposure.

Vendor risk during migration is the second under-scored scenario. The migration vendor, the hyperscaler, the ETL tool, and any managed reconciliation service all hold elevated privileges during the move.

Our third-party risk management guide treats those vendors as a temporary tier-one risk during the cutover window, a discipline most data migration risk assessment template designs still miss in 2026.

Latency and reconciliation are the quiet third category. A clean cutover that leaves a 0.3 percent record-count delta will not page anyone at 2 a.m., but it will surface six weeks later in a quarter-end close as a material weakness.

The data migration risk assessment template should score reconciliation drift with the same rigor it applies to encryption, because regulators eventually look at both.

Building the Data Migration Risk Assessment Template Scoring Matrix

A defensible data migration risk assessment template uses a five-by-five likelihood-impact matrix with US-calibrated bands. The NIST SP 800-30 reference tables give the structure.

The calibration must reflect US-specific consequences: SEC disclosure thresholds, OCC and FFIEC supervisory thresholds, and the downtime economics your CFO will recognize on a 10-Q footnote. Generic global scales fail audit defense because they cannot answer the materiality question.

Data Migration Risk Assessment Template: The 2026 US Practitioner's Guide
Data Migration Risk Assessment Template: The 2026 US Practitioner's Guide

Figure 3: The data migration risk assessment template scoring matrix, with five US severity bands calibrated to SEC, OCC, and CFO thresholds.

Impact scoring needs three sub-axes, not one. Confidentiality (was regulated data exposed), availability (how long was the service down), and integrity (did the reconciliation tie).

A data migration risk assessment template that collapses these into a single impact number will mis-rate scenarios that are catastrophic on one axis and trivial on the others. That is the exact pattern that produced the 2024 Change Healthcare and Snowflake fallout.

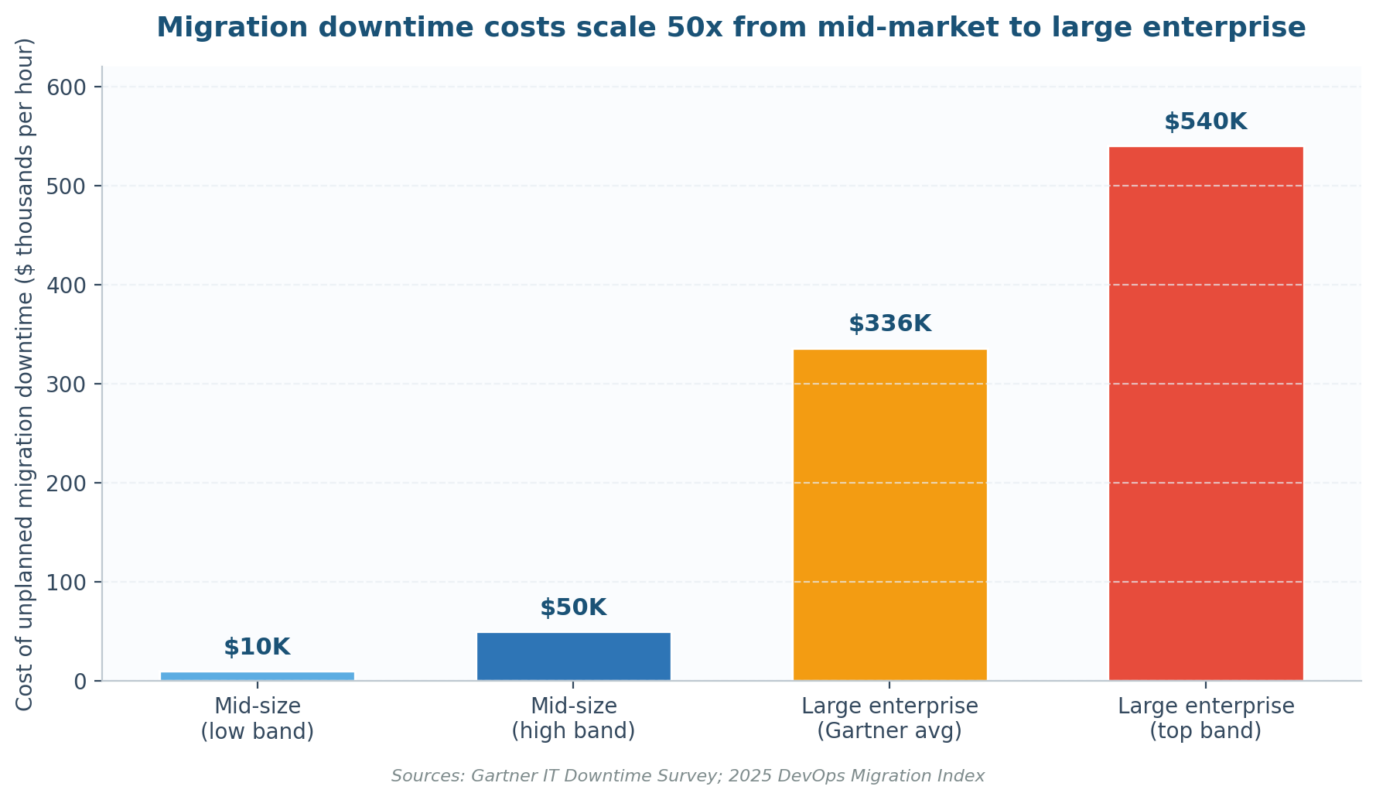

Figure 4: Migration downtime costs scale 50x from mid-market to large enterprise. Calibrate availability scoring to your real numbers.

Likelihood scoring should distinguish cutover-window likelihood from steady-state likelihood. The same scenario, IAM misconfiguration for example, can be near-certain during a poorly rehearsed cutover and rare in steady-state.

Score both. The data migration risk assessment template’s likelihood column is where the difference between “tabletop-tested” and “theoretical” programs becomes visible to anyone reviewing the artifact six months later.

The complete guide to the risk assessment process walks through the supporting scoring discipline in more depth. A common shortcut, using a three-by-three matrix instead of five-by-five, saves an afternoon of calibration work and costs the program its audit defense.

Five-by-five is the floor for any data migration risk assessment template that needs to defend a board-level disclosure.

The Eight-Step Workflow That Turns Your Data Migration Risk Assessment Template Into Action

A data migration risk assessment template that lives in SharePoint and surfaces only at steering-committee time has been reduced to documentation.

The eight steps below convert the template into a working control with checkpoints, owners, and clean handoffs.

They map to the NIST Cybersecurity Framework 2.0 Govern, Identify, Protect, Detect, and Respond functions without re-engineering the artifact.

StepActivityOwnerOutput / evidence artifact
1Scope and asset baselineProgram manager + data architectAsset inventory, source/target diagram, data classification
2Threat scenario workshopRisk lead + cybersecurity leadPopulated threat catalog with rationale per scenario
3Control mapping and gap logSecurity architect + control ownersControl-to-scenario matrix, residual gap log
4Likelihood-impact scoringRisk lead with cross-functional panelScored 5×5 matrix, top-10 risk list, materiality flags
5Cutover and rollback rehearsalMigration lead + ops + GRCTabletop evidence, abort-criteria sign-off, rollback timing
6Pre-go-live attestationCIO, CISO, CRO, CFO (or delegate)Signed risk acceptance, board readout, SEC disclosure draft on standby
7Cutover monitoring and incident responseMigration command centerHourly status, materiality determination log, 8-K decision trail
830/60/90 post-move reassessmentRisk lead + internal auditRefreshed template, lessons learned, residual risk re-baselined

Step 6 is where most US programs underinvest. A pre-go-live attestation requires the four-letter executives to commit personally to the residual risk profile. The risk management report sample shows the format that survives an audit committee challenge.

A data migration risk assessment template without this signed artifact gives the board no defensible answer when the post-mortem asks who knew what, and when they knew it.

Data Migration Risk Assessment Template: The 2026 US Practitioner's Guide
Data Migration Risk Assessment Template: The 2026 US Practitioner's Guide

Figure 5: Every quarter past the 12-month mark adds 4-6 points to your data migration cost overrun. Score duration explicitly.

Duration risk deserves a dedicated workflow checkpoint. The 2025 DevOps Migration Index reporting from CIO Dive found that migrations stretching past 12 months see overruns climb from 18 percent to 30 percent or higher.

A data migration risk assessment template that does not include duration as an explicit re-scoring trigger at month nine will miss the most predictable overrun on the program.

Where Data Migration Risk Assessment Template Programs Stall, and How to Unstick Them

Programs stall in predictable places. Scope creep masquerading as risk mitigation is the most common: additional reconciliation tables, parallel-run windows, and validation passes that quietly extend the cutover by three months.

A disciplined data migration risk assessment template forces a re-score every time scope changes materially. Without that, the change record fills with low-scrutiny additions until the program quietly slips past the 12-month threshold that drives 30 percent overrun.

Single-owner risk is the second trap. When the data migration risk assessment template has one author and one reviewer, it scores what that pair knows and misses what they do not.

Building the template through a cross-functional panel of security, ops, GRC, legal, and business owners is the cheapest hedge against blind spots. Our risk assessment policy guide prescribes the panel composition we have seen survive audit review most consistently.

Materiality is the third gap. Programs assume materiality is a legal call. Under SEC Item 1.05, the data migration risk assessment template must encode the quantitative and qualitative triggers in advance, so that counsel is confirming a pre-agreed threshold during the four-business-day clock rather than improvising one.

Programs that skip this step routinely miss the 8-K window and add an enforcement question to an already painful cutover post-mortem.

Post-go-live amnesia is the fourth trap. The data migration risk assessment template gets archived the week after cutover and never refreshed.

The 30/60/90 reassessment cadence is what catches reconciliation drift, latency degradation, and IAM hygiene erosion before they show up in the next quarter-end. Programs that skip the reassessment step typically discover the gap when the external auditor surfaces it on their behalf.

What’s Next for the Data Migration Risk Assessment Template: 2026-2028

Three shifts will rewrite the data migration risk assessment template playbook over the next twenty-four months. Post-quantum cryptography is the first. NIST CSWP 48 maps PQC migration capabilities to CSF 2.0 controls.

Any data migration risk assessment template built before late 2025 will under-score cryptographic agility risk, and PQC migration is itself a multi-year data migration the SEC and OCC now expect boards to oversee in writing.

AI-assisted migration tooling is the second shift. Our AI risk assessment framework tracks how generative tools have entered ETL design, schema mapping, and reconciliation.

The data migration risk assessment template needs a discrete AI-assistance scenario: hallucinated mappings, prompt-injection in vendor consoles, and shadow-AI usage by the migration vendor are all plausible threat paths the 2022-era templates do not contemplate.

Enforcement velocity is the third shift. The SEC has filed enforcement actions referencing 8-K disclosure failures within months of incident, the OCC is increasing on-site supervisory presence, and the ENISA risk management portal shows EU regulators converging on similar four-day timelines.

A data migration risk assessment template without a working materiality trigger by Q4 2026 becomes a liability rather than a control.

Bank examiners are also evolving. The OCC cybersecurity supervisory program now treats core-banking and ledger migrations as high-risk events that require board-level oversight.

For regulated financial institutions, the data migration risk assessment template is increasingly the artifact the examiner requests on day one, before any working document teams might produce later under challenge. Build it that way from the start.

Frequently Asked Questions About the Data Migration Risk Assessment Template

How often should the data migration risk assessment template be reviewed?

Refresh the data migration risk assessment template before each program phase gate, again at cutover go/no-go, and at 30, 60, and 90 days post-move.

Trigger an ad-hoc refresh whenever scope, vendor, target architecture, or timeline shifts by more than 10 percent. Those are the changes that historically reset the risk profile far more than the calendar suggests.

What standards should anchor the data migration risk assessment template?

Anchor the data migration risk assessment template to NIST SP 800-30 for methodology, NIST CSF 2.0 for control mapping, and ISO 27001 Annex A for the information-security cross-walk.

Regulated US firms layer in HIPAA Security Rule §164.308 and PCI DSS 4.0 for data-handling scenarios. Financial institutions add the OCC and FFIEC IT examination handbooks; healthcare adds the OCR Security Rule risk-analysis guidance most examiners now expect to see referenced explicitly.

How does the data migration risk assessment template handle materiality for SEC reporting?

The data migration risk assessment template must encode pre-agreed quantitative thresholds (record counts, downtime hours, customer impact, dollar exposure) and qualitative triggers (regulated data classes, named system criticality).

During cutover, the template’s materiality column becomes the input to the Item 1.05 four-business-day clock, not a separate legal exercise to improvise on the day.

Who should own the data migration risk assessment template?

The risk function should own the data migration risk assessment template, while the migration program manager acts as the primary contributor.

Security architecture, data architecture, operations, internal audit, and legal should review and sign. Our GRC framework maps these owners to the standard three-lines-of-defense model most US firms operate under in 2026, with the CRO holding final accountability on the artifact.

What metrics belong on the data migration risk assessment template dashboard?

Track residual risk score, materiality flags, control effectiveness rating, cutover window readiness, and reconciliation drift. Our key risk indicators for data security article lists the leading-indicator metrics we have seen survive board scrutiny.

Credential abuse signals, IAM hygiene scores, encryption coverage percent, and reconciliation tie-out rate top that list during active migration windows.

Does the data migration risk assessment template apply to AI and analytics platform moves?

Yes. Any move that changes where regulated data lives, who can read it, or how it is reconciled triggers the template.

Our AI risk assessment framework explains the AI-specific scenarios (model lineage breaks, training data leakage, vector store mis-classification) that should be added to the data migration risk assessment template threat catalog for AI platform migrations.

How does the data migration risk assessment template fit with the broader risk register?

Treat the data migration risk assessment template as a program-level deep-dive that rolls up to the firm’s enterprise risk register.

The eight components map to standard register fields (risk owner, inherent score, control effectiveness, residual score, mitigation plan) so the rollup is mechanical, not interpretive, when the audit committee asks.

The Practitioner’s Cheat Sheet for Your Data Migration Risk Assessment Template

A data migration risk assessment template earns its keep on the worst day of the program, not the best. The eight components, the five-by-five scoring matrix, and the eight-step workflow give US risk owners a defensible artifact the SEC, OCC, OCR, and FTC will recognize.

The risk assessment templates library on riskpublishing.com hosts the companion artifacts most teams pair with the data migration risk assessment template, including cyber, third-party, and ERM.

The single most important habit is re-scoring. A static data migration risk assessment template is a fossil. A template that gets re-scored at every phase gate, at cutover, and at 30/60/90 days post-move is a control.

Our services page outlines how we help US firms operationalize that cadence. If you want the workshop format that produced the example template above, our contact page is the fastest path to it.

If you remember nothing else: score cutover risk separately from steady-state, score vendor risk during the migration window as tier-one, encode the materiality trigger in advance, and re-score every time the program changes by 10 percent on duration, scope, or vendor.

That cheat sheet, applied through a disciplined data migration risk assessment template, will keep your firm out of the 83 percent overrun statistic.

For practitioners maintaining the broader portfolio, our what is a risk assessment primer and the NIST CSF 2.0 implementation guide are the two background pieces that pair best with this article.

Together they give a new risk owner a 60-minute on-ramp to running a credible data migration risk assessment template program from day one.
