Risk Score: What It Is and How to Enable It

Photo of author
Written By Chris Ekai

A cybersecurity team at a regional bank discovered a critical vulnerability in their online banking platform on a Friday afternoon. The CISO flagged it to the risk committee, describing it as “a serious cyber risk.” The committee asked the obvious question: How serious? The CISO had no risk score — no likelihood estimate, no dollar-denominated impact, no comparison against the bank’s risk appetite.

The vulnerability sat in the remediation queue behind 47 other items, all described with the same vague severity. Three weeks later, the vulnerability was exploited. The breach cost $4.2 million in direct losses, a regulatory enforcement action, and a 12% drop in customer trust scores.

That story is not unusual. Organizations that cannot translate risks into scores cannot prioritize. And organizations that cannot prioritize treat every risk as equally urgent — which means, in practice, none of them get treated urgently.

A PwC Global Risk Survey found that organizations with mature risk scoring practices resolve high-priority risks 60% faster than those relying on qualitative labels alone. Risk scoring is not an academic exercise — it is the mechanism that converts risk awareness into risk action.

This guide explains what a risk score is, how it is calculated, the methods available (qualitative through AI-augmented), and how to enable scoring across your organization — all anchored to ISO 31000:2018 and the COSO ERM framework. Whether you are building a scoring system from scratch or upgrading from a spreadsheet-based register, the 90-day roadmap at the end gives you a concrete implementation path.

Key Takeaways
A risk score is the product of likelihood and impact, expressed on a defined scale (typically 1–25 on a 5×5 matrix). The score drives treatment priority, resource allocation, and board reporting.
Three scoring methodologies exist on a precision spectrum: qualitative (High/Medium/Low), semi-quantitative (ordinal scales), and quantitative (probability-based). Hybrid approaches that combine qualitative screening with quantitative deep-dives deliver the best balance of speed and rigor.
Risk scores must be anchored to calibrated scales. Without explicit definitions for each likelihood and impact level, assessors interpret the same risk differently and scores lose reliability.
Internal risk factors (human error, process failures, governance gaps) and external risk factors (cyberattacks, regulatory change, economic shifts) both feed into the composite risk score.
Enabling risk scoring requires five components: a defined scoring methodology, calibrated scales, a risk register infrastructure, alert thresholds tied to risk appetite, and a review cadence that keeps scores current.
The shift toward AI-augmented and continuous risk scoring is accelerating. Organizations still relying on annual, qualitative-only scoring are falling behind industry benchmarks.

What Is a Risk Score?

A risk score is a numerical value that represents the severity of an identified risk, calculated by combining the likelihood of the risk event occurring with the impact (or consequence) on organizational objectives.

ISO 31000:2018 frames risk as “the effect of uncertainty on objectives,” and the risk score is how we measure that effect in comparable, prioritizable terms.

The fundamental equation is straightforward:

Risk Score: What It Is and How to Enable It
Risk Score: What It Is and How to Enable It

Figure 1: The risk scoring equation — Likelihood × Impact = Risk Score

On a standard 5×5 matrix, likelihood ranges from 1 (Rare) to 5 (Almost Certain) and impact from 1 (Insignificant) to 5 (Catastrophic). The product yields scores from 1 to 25. Risk scores populate the risk register, feed into risk assessment matrices, and drive treatment priority across the risk management process.

Score TypeWhat It MeasuresInputsUse CaseLimitation
Inherent risk scoreRisk level before any controls are appliedRaw likelihood × raw impactUnderstand worst-case exposure; justify control investmentHypothetical; rarely reflects operating reality
Residual risk scoreRisk level after existing controls are operatingControlled likelihood × controlled impactBoard reporting; tolerance comparison; treatment prioritizationDepends on accurate control effectiveness assessment
Target risk scoreDesired risk level after planned treatments are implementedProjected likelihood × projected impact after treatmentGap analysis; budget justification; roadmap planningForward-looking estimate; subject to execution risk

The 5×5 Risk Scoring Matrix

The 5×5 matrix is the most widely adopted scoring tool because it balances granularity with usability. Each cell represents a unique likelihood-impact combination, and the resulting score maps to an action zone that aligns with the organization’s risk appetite statement.

Risk Score: What It Is and How to Enable It
Risk Score: What It Is and How to Enable It

Figure 2: Calibrated 5×5 risk scoring matrix with action zones

Calibrating the Scales

An uncalibrated matrix is worse than no matrix at all, because it creates the illusion of precision. Calibration means anchoring each likelihood and impact level to specific, measurable criteria that assessors can apply consistently.

LevelLikelihood DefinitionImpact — FinancialImpact — Operational
1: Rare< 5% probability in 12 months; has never occurred in the organization< $50K loss< 4 hours disruption; no customer impact
2: Unlikely5–20% probability; has occurred once in 5+ years$50K–$250K loss4–24 hours disruption; minor customer impact
3: Possible20–50% probability; has occurred in past 3 years$250K–$1M loss1–3 days disruption; moderate customer impact
4: Likely50–80% probability; occurs annually or more frequently$1M–$5M loss3–10 days disruption; significant customer impact
5: Almost Certain> 80% probability; expected to occur within the assessment period> $5M loss> 10 days disruption; severe / widespread customer impact

Replicate this calibration across multiple impact dimensions: financial, operational, regulatory (severity of sanction), reputational (media exposure, customer trust), and safety (injury severity). Use the highest-scoring dimension as the overall impact rating — a practice called maximum-impact scoring. Detailed calibration guidance is available in the risk assessment process guide.

Risk Scoring Methods: From Qualitative to AI-Augmented

Organizations sit on a spectrum of scoring maturity. The chart below compares adoption rates against scoring precision:

Risk Score: What It Is and How to Enable It
Risk Score: What It Is and How to Enable It

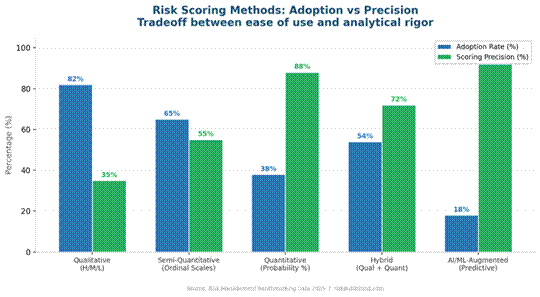

Figure 3: Risk scoring methods — adoption rate vs scoring precision tradeoff

MethodHow It WorksPrecisionSpeedBest For
QualitativeDescriptive labels (High/Medium/Low) assigned by expert judgment in workshops or surveysLow — subjective, inconsistent across assessorsFast — hoursInitial screening; organizations new to risk management; risks that resist quantification
Semi-quantitativeOrdinal scales (1–5) with defined criteria; scores calculated as likelihood × impactModerate — structured but still judgment-basedMedium — daysMost enterprise risk registers; 5×5 matrix approach; balanced effort-to-value
QuantitativeProbability distributions, Monte Carlo simulation, expected monetary value (EMV)High — data-driven, reproducible, defensibleSlow — weeksCapital allocation; insurance placement; board-level risk quantification
HybridQualitative screening for all risks; quantitative deep-dive on top-tier risksHigh — best of both worldsMediumMature ERM programs; ISO 31000 + IEC 31010 aligned
AI/ML-augmentedMachine learning models trained on incident data, KRIs, and external signals to predict risk scoresVery high — continuous, adaptiveReal-timeCybersecurity; fraud detection; operational risk in high-volume environments

The hybrid approach is where most mature organizations land. Screen all risks qualitatively using a risk assessment matrix, then apply Monte Carlo simulation, scenario analysis, or three-point estimation to the top 10–20 risks that require dollar-denominated exposure for board reporting or risk quantification.

Internal and External Risk Factors

A comprehensive risk score accounts for both internal and external factors. Internal factors originate from within the organization (processes, people, systems, governance).

External factors arise from the operating environment (regulatory, economic, technological, geopolitical). Both feed into the composite score that drives treatment decisions.

Risk Score: What It Is and How to Enable It
Risk Score: What It Is and How to Enable It

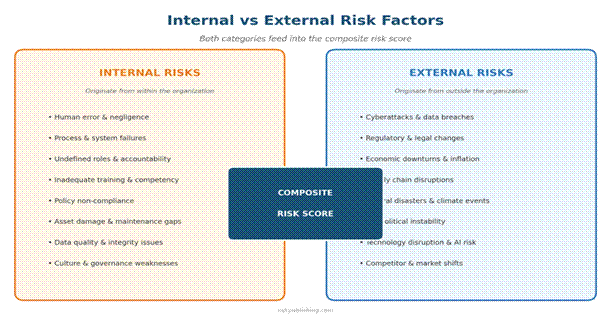

Figure 4: Internal and external risk factors that feed the composite risk score

DimensionInternal Risk FactorsExternal Risk Factors
SourceWithin the organization’s direct controlOutside the organization’s direct control
ExamplesHuman error, process failures, system outages, policy gaps, cultural weaknesses, data integrity issuesCyberattacks, regulatory changes, economic shifts, supply chain disruptions, climate events, geopolitical instability
Scoring inputControl environment maturity; incident frequency; audit findings; KRI breach ratesThreat intelligence feeds; regulatory horizon scanning; macroeconomic indicators; industry benchmarks
Mitigation leverageHigh — organization can directly improve controls, training, processesModerate — organization can build resilience (insurance, BCP, diversification) but cannot eliminate the threat
Monitoring approachRCSA workshops; internal audit; KRI dashboards; control self-testingEnvironmental scanning; regulatory watch; third-party risk monitoring; scenario analysis

The COSO ERM framework emphasizes that risk scoring must consider the organization’s full context — internal environment, strategic objectives, and external landscape.

Organizations that score only internal risks miss the threats that are most likely to cause existential damage. Conversely, focusing only on external risks ignores the vulnerabilities that make those threats exploitable.

How to Enable Risk Scoring in Your Organization

Enabling risk scoring is not simply installing software. It requires five interconnected components, each of which must be in place for the system to function:

#ComponentWhat It InvolvesCommon Failure ModeSuccess Indicator
1Scoring methodologySelect qualitative, semi-quantitative, quantitative, or hybrid; document the chosen approach in a risk management policyNo documented methodology; each department invents its ownSingle, board-approved methodology applied consistently across the register
2Calibrated scalesDefine explicit criteria for each likelihood and impact level, anchored to financial, operational, regulatory, and reputational thresholdsScales exist but are generic (“High = significant loss”); no dollar thresholdsAssessors across different workshops produce scores within 1 level of each other for the same risk
3Risk register infrastructureDeploy a register (Excel, GRC platform, or dedicated tool) with columns for inherent score, residual score, risk owner, KRIs, and review datesRegister is a static document; no workflow for updates or approvalsLiving register with automated reminders, approval workflows, and version history
4Alert thresholds and escalationMap risk score zones to required actions (accept / monitor / treat / escalate); configure threshold-based alerts in dashboards or GRC toolsThresholds exist on paper but are not enforced; amber and red breaches go unescalatedEvery KRI breach above tolerance triggers a documented escalation within 24 hours
5Review cadenceSchedule regular scoring reviews (monthly operational, quarterly board) with clear governance for score changesScores assigned once and never updated; “risk register rot”Scores updated at least quarterly; material changes trigger ad-hoc re-scoring

Project-Level Risk Scoring

Project risk scoring follows the same principles but operates at a narrower scope. Project managers define project impact thresholds (schedule delay in days, budget overrun in dollars, scope reduction in deliverables) and score risks against those thresholds.

The risk management lifecycle for projects is compressed: identify at project kickoff, score in the planning phase, monitor through execution, and close in post-implementation review.

Aggregate project-level scores into a program risk profile that gives portfolio managers visibility across all active projects. Risks that appear in multiple projects may indicate a systemic organizational weakness that warrants enterprise-level treatment.

Risk Score Distribution Analysis

Once your register is scored, analyze the distribution. A healthy register typically shows a bell-curve pattern with most risks in the Medium zone, fewer in Low and High zones, and a small tail in Critical.

An unhealthy distribution — everything clustered at High or everything at Low — signals calibration problems.

Risk Score: What It Is and How to Enable It
Risk Score: What It Is and How to Enable It

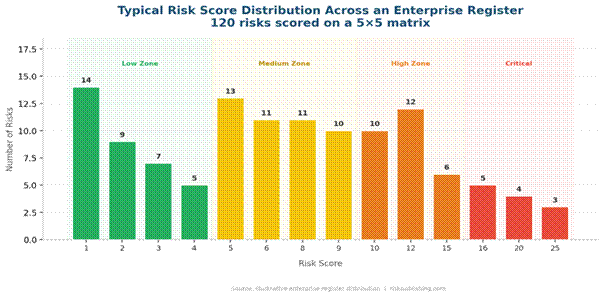

Figure 5: Typical risk score distribution across an enterprise register of 120 risks

Making Score-Based Decisions

The value of risk scoring is realized when scores drive decisions, not when they sit in a register. Three decision frameworks connect scores to action:

Decision FrameworkHow Scores Feed InOutputGovernance Owner
Treatment prioritizationRank risks by residual score; treat the highest-scoring risks firstPrioritized treatment plan with budgets, owners, and timelinesCRO / Risk Committee
Resource allocationMap aggregate risk exposure by business unit or project; allocate control budgets proportionallyResource allocation matrix showing investment per risk zoneCFO / Executive Committee
Risk appetite complianceCompare residual scores against published appetite thresholds; flag breachesCompliance status report with breach count and remediation timelineBoard Risk Committee
Insurance and transfer decisionsUse quantified risk scores to determine insurable vs retainable exposureInsurance placement strategy; self-insured retention levelsCFO / Treasury

Board-level reporting should present scores in three layers: a heatmap overview showing score distribution, a top-5 risk detail table with scores, trends, and treatment status, and a decision ask section requesting specific approvals (budget, resource, policy change).

The KRI dashboard supplements the score view with leading-indicator trends that predict where scores are heading.

Implementation Program

PhaseActionsDeliverablesSuccess Metrics
Days 1–30: DesignSelect scoring methodology; calibrate 5×5 scales with financial/operational/regulatory thresholds; publish scoring guide; map score zones to appetite; configure register templateBoard-approved scoring methodology; calibrated scale definitions; register template with inherent/residual/target score columns; scoring guide (2-pager)Methodology signed off; scales tested in pilot workshop with < 1-level variance; template deployed
Days 31–60: ScoreScore top-50 risks in cross-functional workshops; quantify top-10 risks with three-point estimation or Monte Carlo; assign KRIs to each scored risk; configure dashboard alert thresholdsScored risk register (inherent + residual); heatmap; quantified risk profile for top-10; KRI-to-risk mapping; dashboard with live thresholds100% of top-50 risks scored; top-10 have quantified exposure; KRIs assigned to all High/Critical risks
Days 61–90: OperationalizeRun first monthly scoring review cycle; deliver first board risk report with scores; train all risk owners on scoring methodology; schedule quarterly calibration workshop; benchmark score distributionMonthly review report; board risk pack; training completion records; calibration workshop schedule; distribution analysis baselineZero High/Critical risks without active treatment plan; board report delivered; training > 90%; distribution follows expected curve

Common Challenges and How to Avoid Them

PitfallRoot CauseRemedy
Score inflation (“everything is Critical”)Risk owners over-score to attract management attention and budgetEnforce calibration with worked examples; require evidence for scores > 15; peer-review in workshops
Score deflation (“everything is Low”)Cultural reluctance to escalate; fear of appearing incompetentReward accurate scoring, not low scoring; normalize red zones as healthy risk management
Stale scoresScores assigned once and never updatedMandate quarterly re-scoring minimum; automate reminders; tie score currency to performance reviews
Inconsistent scoring across business unitsNo shared methodology or calibration; siloed workshopsPublish organization-wide scoring guide; run calibration exercises annually; use the same facilitator across units
Scoring without actionScores populate the register but do not drive treatment or reportingConnect every score zone to a required action (accept/monitor/treat/escalate); CRO tracks action completion
Ignoring velocity and interdependencyScore considers only likelihood and impact, missing how fast a risk can escalate or trigger other risksAdd velocity and interdependency columns to the register; adjust priority rankings accordingly
Over-reliance on a single matrix5×5 matrix used as the only scoring tool for all risk typesComplement the matrix with scenario analysis, Monte Carlo, and bow-tie for complex or high-value risks

Looking Ahead: The Future of Risk Scoring (2025–2027)

Continuous, real-time scoring. The annual or quarterly scoring cycle is being replaced by continuous scoring engines that ingest KRI data feeds, incident reports, and external threat intelligence to update risk scores in near-real-time.

GRC platforms are building this capability natively, and organizations at the leading edge are integrating AI risk assessment frameworks to automate score recalculation.

Multi-dimensional scoring. Beyond likelihood × impact, advanced scoring models are incorporating velocity (how fast a risk can materialize), interconnectedness (how many other risks it triggers), and controllability (how much the organization can reduce the score through action).

These additional dimensions produce a richer risk profile that supports more nuanced treatment decisions.

Quantification as the board standard. Boards are moving past traffic-light heatmaps and demanding dollar-denominated risk exposure.

Risk quantification for board reporting — expressed as Value-at-Risk, expected loss, or scenario-based P&L impact — will become the default language of risk reporting by 2027. The Three Lines Model will require first-line owners to defend their scores with evidence, not just judgment.

Regulatory scrutiny of scoring quality. Regulators are examining not just whether organizations have risk registers, but whether the scores in those registers are calibrated, evidence-based, and consistently applied.

Organizations that invest in scoring rigor now will be ahead when examination standards tighten across sectors from financial services to healthcare to critical infrastructure.

Ready to enable risk scoring in your organization? Explore scoring templates, risk register frameworks, and consulting services at riskpublishing.com/services. Need a tailored scoring methodology? Get in touch — we build risk scoring systems that boards trust and auditors validate.

References

1. ISO 31000:2018 — Risk Management Guidelines — International Organization for Standardization

2. COSO Enterprise Risk Management — Integrating with Strategy and Performance (2017) — Committee of Sponsoring Organizations

3. IEC 31010:2019 — Risk Assessment Techniques — International Electrotechnical Commission

4. PwC Global Risk Survey 2024 — PricewaterhouseCoopers

5. Beyond Probability-Impact Matrices in Project Risk Management — Nature Humanities and Social Sciences Communications (2024)

6. NIST Risk Management Framework — National Institute of Standards and Technology

7. IIA Three Lines Model (2020) — Institute of Internal Auditors

8. The Risk Matrix Approach — PMC/NIH — National Library of Medicine (2022)

9. Deloitte Global Risk Management Survey — Deloitte

10. Risk Assessment Matrix: Calculations and Guide — Vector Solutions

11. Qualitative Risk Assessment — PMI — Project Management Institute

12. Risk Management Framework 2025 — Neotas 13. Secureframe Risk Management Statistics 2026 — Securef

Index
