Cyber Risk Assessment: A Step-by-Step Framework

Photo of author
Written By Chris Ekai
Key Takeaways
A cyber risk assessment is the structured process of identifying cyber threats and vulnerabilities, analyzing their likelihood and impact, and prioritizing treatment actions based on the organization’s risk appetite. NIST CSF 2.0 is the primary framework used by 54% of U.S. companies (2025 survey data).
The average cost of a data breach reached $4.88 million globally in 2024 (IBM). Organizations extensively using security AI and automation identified and contained breaches nearly 100 days faster than those without. A rigorous cyber risk assessment is the foundation that makes these protections possible.
NIST CSF 2.0 provides the “what” (six core functions: Govern, Identify, Protect, Detect, Respond, Recover) while NIST SP 800-30 provides the “how” (four-step risk assessment methodology: Prepare, Conduct, Communicate, Maintain). Together they form a complete cyber risk assessment program.
This guide provides a seven-step cyber risk assessment process with a threat-vulnerability catalogue, a quantitative scoring model, a control gap analysis template, and a KRI dashboard structure you can implement immediately.
Cyber risk must integrate with enterprise risk management. NIST IR 8286 (revised December 2025) explicitly bridges cybersecurity risk and ERM, ensuring that cyber risk is reported alongside financial, operational, and strategic risks at the board level.
The top cyber threats in 2025-2026 are ransomware, supply chain compromise, cloud misconfiguration, AI-enabled attacks, and insider threats. Nearly 75% of enterprises experienced at least one critical risk event in the past year (Forrester, 2025).
A 90-day roadmap takes your organization from ad hoc cybersecurity to a structured, NIST-aligned cyber risk assessment program with continuous monitoring and board-level reporting.

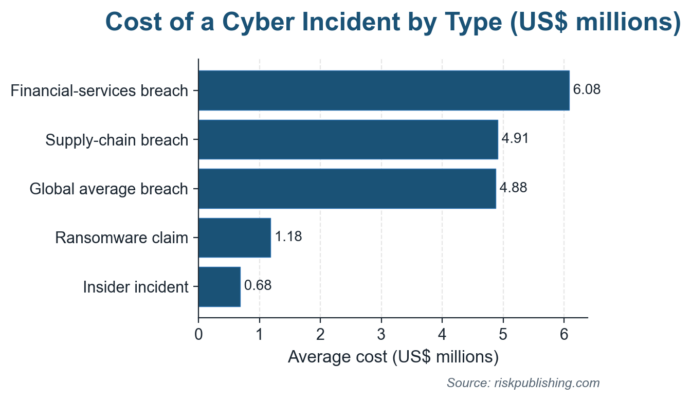

The average cost of a data breach reached $4.88 million globally in 2024, according to IBM’s Cost of a Data Breach Report. The financial services sector fared worse at $6.08 million, 22% above the global average.

These are not theoretical losses. They represent real incidents that a structured cyber risk assessment could have prevented or significantly reduced.

Organizations using security AI and automation identified and contained breaches nearly 100 days faster than those without, directly because their risk assessments enabled them to deploy the right controls in the right places before the attack occurred.

A 2025 survey found that NIST CSF is the primary cybersecurity risk framework used by 54% of U.S. companies. The framework’s adoption increased to 68% in technology and financial services.

NIST itself updated three publications (IR 8286r1, 8286Ar1, 8286Cr1) in December 2025 specifically to strengthen the connection between cybersecurity risk and enterprise risk management.

The message is clear: cyber risk is not an IT problem. Cyber risk is an enterprise risk that belongs on the same register and the same board report as financial, operational, and strategic risk.

Cyber Risk Assessment

This guide provides a complete cyber risk assessment framework: seven steps aligned to NIST CSF 2.0, NIST SP 800-30, ISO 27001, and ISO 31000. Each section includes practitioner-ready tables with threat catalogues, scoring models, control gap templates, and KRI dashboards you can deploy immediately.

What Is a Cyber Risk Assessment?

A cyber risk assessment is the structured process of identifying threats to and vulnerabilities within an organization’s information systems, analyzing the likelihood and potential impact of exploitation, and prioritizing treatment based on the organization’s risk appetite.

NIST SP 800-30 defines risk assessment as “the process of identifying, estimating, and prioritizing information security risks” that requires analyzing threats, vulnerabilities, likelihood, and impact to determine the level of risk to organizational operations, assets, and individuals.

Activity What to Measure How This Differs from Risk Assessment
Vulnerability Scan Technical vulnerabilities in systems, applications, and configurations. Output: list of CVEs with CVSS scores. Identifies vulnerabilities only. Does not assess threat likelihood, business impact, or treatment priority. A vulnerability scan is an input to risk assessment, not a substitute.
Penetration Test Exploitability of vulnerabilities under realistic attack conditions. Output: proof of exploitation, attack paths, remediation recommendations. Tests whether vulnerabilities can be exploited but does not prioritize based on business risk. A critical vulnerability on a test server has different risk than the same vulnerability on a payment system.
Compliance Audit Conformity to a specific standard (ISO 27001, PCI-DSS, HIPAA). Output: conformity report with findings and gaps. Checks whether controls exist and operate per the standard. Does not assess whether the controls are sufficient for the actual threat landscape the organization faces.
Cyber Risk Assessment Threats, vulnerabilities, likelihood, impact, and residual risk across the entire information asset landscape. Output: prioritized risk register with treatment plans. Integrates all inputs (vulnerability scans, pen tests, threat intelligence, business impact data) into a unified risk picture that drives resource allocation and board-level decisions.

The distinction matters because many organizations conflate vulnerability scanning or compliance auditing with risk assessment. Running a monthly Nessus scan does not constitute a risk assessment.

A risk assessment uses the scan results as one data input, combines the scan results with threat intelligence, business impact analysis, and control effectiveness evaluation, and produces a prioritized treatment plan that links to the organization’s strategic objectives.

The Cyber Threat Landscape: 2025-2026

A cyber risk assessment starts with understanding what threats the organization faces. The threat catalogue below consolidates findings from Forrester’s 2025 ERM research, Verizon’s 2025 DBIR, and IBM’s breach data into a practitioner-ready reference.

Cyber Threat Catalogue for Risk Assessment

Threat Category Description Primary Attack Vector Likelihood (2025-2026) Typical Impact Trend
Ransomware Encryption of systems/data with ransom demand. Double/triple extortion now includes data theft and DDoS threats. Phishing email, exploited vulnerability, compromised RDP High $1.18M average ransom claim (2025). Operational shutdown. Regulatory reporting obligations. Increasing: 17% rise in average claim value year-over-year
Supply Chain Compromise Attack through a trusted third party: software update, vendor access, or shared service provider. Compromised vendor software update, third-party credentials, SaaS platform breach High 30% of breaches now involve a third party (Verizon DBIR 2025). Average breach cost $4.91M when supply chain is involved. Increasing: doubled from 15% to 30% in one year
Cloud Misconfiguration Insecure default settings, overly permissive access, or public exposure of cloud resources. Misconfigured S3 buckets, overprivileged IAM roles, unencrypted databases High 47% of cloud data is sensitive; only 10% of enterprises have encrypted 80%+ (Thales 2024). Stable-High: persistent gap between cloud adoption and cloud security maturity
Business Email Compromise (BEC) Impersonation of executive or trusted contact to redirect payments or extract credentials. Spoofed email, compromised email account, social engineering Medium-High $2.7B in reported U.S. losses annually (FBI IC3). Individual incidents range $25K-$75M. Increasing: AI-generated deepfake audio/video enhancing impersonation quality
AI-Enabled Attacks Use of generative AI to create sophisticated phishing, deepfakes, and automated vulnerability exploitation. AI-generated phishing at scale, deepfake voice/video, automated reconnaissance Medium (emerging rapidly) Accelerated attack speed. Lower barrier to entry for attackers. Detection evasion through AI-generated content. Rapidly Increasing: new threat category with limited historical data
Insider Threat Malicious or negligent actions by employees, contractors, or partners with authorized access. Privileged credential misuse, data exfiltration, accidental exposure Medium $676,517 average cost per incident. 13.5 incidents per organization per year (Ponemon 2025). Stable: persistent human risk factor amplified by remote work

This threat catalogue should be customized to your organization’s industry, geography, and technology stack.

A healthcare organization adds HIPAA-specific threats (medical device vulnerabilities, patient data exposure). A financial institution adds wire fraud, ATM jackpotting, and SWIFT network compromise.

The catalogue feeds directly into Step 3 of the assessment process below. Cybersecurity KRIs should track the leading indicators for each threat category on the monthly dashboard.

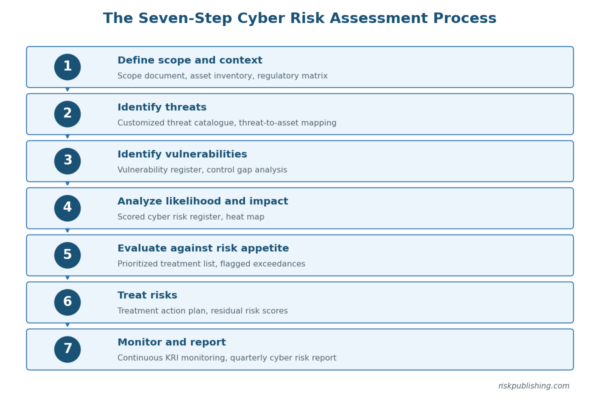

Seven-Step Cyber Risk Assessment Process

The process below synthesizes NIST SP 800-30 (risk assessment methodology), NIST CSF 2.0 (control framework), ISO 27005 (information security risk management), and ISO 31000 (enterprise risk management) into a single practitioner workflow.

Cyber Risk Assessment: A Step-by-Step Framework

Step Objective Key Activities Tools / Standards Output
1 Define scope and context Identify information assets, business processes, regulatory requirements, and organizational risk appetite. Define assessment boundaries (enterprise-wide, system-specific, or third-party focused). NIST CSF 2.0 Govern function. ISO 27001 Clause 4 (Context). Risk appetite statement. Scope document. Asset inventory. Regulatory applicability matrix.
2 Identify threats Build or customize the threat catalogue for the organization. Map threats to asset categories. Incorporate threat intelligence from ISACs, vendor feeds, and open-source intelligence. MITRE ATT&CK framework. Threat intelligence platforms. Industry-specific ISACs. NIST SP 800-30 Appendix D (Threat Sources). Customized threat catalogue. Threat-to-asset mapping matrix.
3 Identify vulnerabilities Scan systems for technical vulnerabilities. Assess process and policy weaknesses through control gap analysis. Review recent audit findings and incident reports. Vulnerability scanners (Nessus, Qualys). NIST SP 800-53 control assessment. Penetration test results. Audit finding register. Vulnerability register with CVSS scores. Control gap analysis. Pen test findings.
4 Analyze likelihood and impact Score each threat-vulnerability pair using a quantitative or semi-quantitative model. Estimate likelihood based on threat capability, intent, and targeting. Estimate impact across confidentiality, integrity, availability, financial, regulatory, and reputational dimensions. 5×5 risk matrix. FAIR (Factor Analysis of Information Risk) for quantitative scoring. NIST SP 800-30 Appendix H (risk model). Scored cyber risk register. Heat map showing inherent risk distribution.
5 Evaluate against risk appetite Compare scored risks against the organization’s risk appetite thresholds. Flag risks exceeding appetite for mandatory treatment. Prioritize treatment based on composite risk score and strategic importance. Risk appetite overlay. Board-approved risk tolerance thresholds. Prioritized treatment list. Risks above appetite flagged for CISO/CRO decision.
6 Treat risks Select treatment: avoid, reduce (implement controls), transfer (cyber insurance), accept (within appetite). Assign owners, budgets, and timelines. Map controls to NIST CSF subcategories. NIST CSF 2.0 Protect/Detect/Respond functions. ISO 27001 Annex A controls. CIS Controls v8. Treatment action plan. Control implementation schedule. Updated residual risk scores.
7 Monitor and report Track KRIs continuously. Re-assess when the threat landscape changes, after incidents, or at scheduled intervals (quarterly minimum). Report cyber risk alongside enterprise risk to the board. SIEM/SOAR platforms. KRI dashboard. NIST IR 8286 (cybersecurity-ERM integration). Monthly/quarterly risk reports. Continuous KRI monitoring. Quarterly cyber risk report. Annual full reassessment.

Steps 1-5 align to NIST SP 800-30’s “Conduct” phase. Step 6 bridges to risk treatment. Step 7 aligns to NIST SP 800-30’s “Maintain” phase and the CSF 2.0 Govern function’s emphasis on continuous improvement.

The entire process should be repeated at least annually, with targeted reassessments triggered by significant changes (new systems, acquisitions, major incidents, or emerging threats).

Cyber Risk Scoring: From Qualitative to Quantitative

Most organizations start with a qualitative 5×5 matrix and aspire to quantitative methods like FAIR (Factor Analysis of Information Risk).

The table below provides both approaches so you can start where your maturity allows and grow toward financial quantification over time.

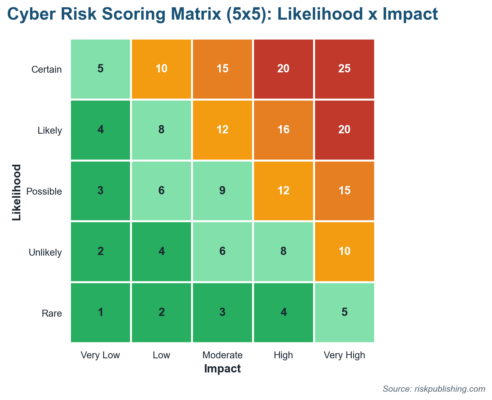

Qualitative Cyber Risk Scoring Matrix (5×5)

Likelihood / Impact 1 – Negligible 2 – Minor 3 – Moderate 4 – Major 5 – Catastrophic
5 – Almost Certain 5 (Medium) 10 (High) 15 (High) 20 (Critical) 25 (Critical)
4 – Likely 4 (Low) 8 (Medium) 12 (High) 16 (Critical) 20 (Critical)
3 – Possible 3 (Low) 6 (Medium) 9 (Medium) 12 (High) 15 (High)
2 – Unlikely 2 (Low) 4 (Low) 6 (Medium) 8 (Medium) 10 (High)
1 – Rare 1 (Low) 2 (Low) 3 (Low) 4 (Low) 5 (Medium)

Impact Scale Definition (Cyber-Specific)

Score Financial Operational Regulatory Reputational Data Impact
1 – Negligible < $10K < 1 hour downtime No regulatory interest No media coverage No data exposed
2 – Minor $10K-$100K 1-8 hours downtime Regulatory inquiry; no fine Local media; limited reach < 100 records; non-sensitive
3 – Moderate $100K-$1M 8-48 hours downtime Regulatory investigation; potential fine < $500K National media; moderate coverage 100-10K records; may include PII
4 – Major $1M-$10M 2-7 days downtime Fine $500K-$5M; consent order Sustained national coverage; customer attrition 10K-1M records; includes sensitive PII/PHI
5 – Catastrophic > $10M > 7 days; business-critical failure Fine > $5M; license risk; criminal referral International coverage; executive accountability > 1M records; classified/regulated data

The risk assessment matrix provides the qualitative starting point. Organizations seeking board-level financial quantification should adopt FAIR methodology, which replaces ordinal scores (1-5) with probability distributions of annual loss exposure in dollar terms. FAIR produces outputs like: “

Cyber Risk Assessment: A Step-by-Step Framework

There is a 10% chance that a ransomware attack will cost this organization more than $8M in the next 12 months.” That statement drives investment decisions in ways that a heatmap color cannot. Risk quantification for boards provides guidance on making this transition.

NIST CSF 2.0 Control Gap Analysis

NIST CSF 2.0 organizes cybersecurity outcomes into six functions. A control gap analysis compares your current implementation against the CSF subcategories to identify where the organization is strong and where gaps create risk. The table below provides a sample gap analysis structure for the first three functions.

Sample CSF 2.0 Gap Analysis (Partial)

Function Category Subcategory Example Current State Target State Gap / Action Required
Govern (GV) GV.OC: Organizational Context GV.OC-01: The organizational mission is understood and informs cybersecurity risk management Tier 2: Risk Informed Tier 3: Repeatable Document how cyber risk aligns to strategic objectives. Present to board quarterly.
Govern (GV) GV.RM: Risk Management Strategy GV.RM-01: Objectives for cybersecurity risk management are established and communicated Tier 1: Partial Tier 3: Repeatable Develop formal cyber risk appetite statement. Communicate to all business units.
Identify (ID) ID.AM: Asset Management ID.AM-01: Inventories of hardware managed by the organization are maintained Tier 2: Risk Informed Tier 3: Repeatable Deploy automated asset discovery. Achieve 95% inventory coverage within 90 days.
Identify (ID) ID.RA: Risk Assessment ID.RA-01: Vulnerabilities in assets are identified, validated, and recorded Tier 2: Risk Informed Tier 4: Adaptive Move from quarterly vulnerability scanning to continuous scanning with CVSS-based prioritization.
Protect (PR) PR.AA: Identity Management and Access Control PR.AA-01: Identities and credentials for authorized users are managed Tier 2: Risk Informed Tier 3: Repeatable Enforce MFA on all accounts. Complete IAM policy review. Implement privileged access management.
Protect (PR) PR.DS: Data Security PR.DS-01: The confidentiality, integrity, and availability of data-at-rest is protected Tier 1: Partial Tier 3: Repeatable Classify all data by sensitivity. Encrypt sensitive data at rest. Implement DLP for outbound traffic.

The gap analysis drives the treatment plan in Step 6 of the assessment process. Each gap becomes a treatment action with an owner, budget, and deadline.

The Tier ratings (1-4) provide a maturity dimension that the board can track over time: “We moved from Tier 1 to Tier 2 across 85% of CSF subcategories this year.” The NIST CSF 2.0 implementation guide provides detailed subcategory-level guidance for all six functions.

Cyber Risk KRI Dashboard

Continuous monitoring closes the loop between the annual risk assessment and daily operations. The KRI dashboard below tracks the leading indicators that signal changes in cyber risk exposure before they become incidents.

KRI Data Source Green Amber Red
Mean time to detect (MTTD) intrusion SIEM / SOC metrics < 24 hours 24-72 hours > 72 hours
Mean time to remediate (MTTR) critical vulnerabilities Vulnerability management platform < 15 days 15-30 days > 30 days
Phishing simulation click-through rate Security awareness platform < 3% 3-8% > 8%
Critical/high CVEs unpatched beyond SLA Patch management dashboard 0 1-5 > 5
Privileged accounts without MFA IAM platform 0 1-3 > 3
Third-party vendors without current security assessment Vendor risk management platform 0 1-3 > 3
Security incidents per quarter (trending) Incident management system Decreasing Stable Increasing
Backup recovery test success rate DR testing log > 95% 85-95% < 85%

Each KRI should be linked to a specific risk on the cyber risk register. When a KRI breaches its amber threshold, the linked risk is flagged for review. When a KRI goes red, the linked risk triggers the pre-defined treatment escalation.

This automated feedback loop converts the annual risk assessment into a continuous risk management capability. Leading vs. lagging KRIs provides deeper guidance on selecting indicators that predict incidents rather than merely confirming them after the fact.

Integrating Cyber Risk into Enterprise Risk Management

NIST IR 8286 (revised December 2025) explicitly bridges cybersecurity risk and enterprise risk management.

The publication series shows how to express cyber risk in business terms (financial impact, operational disruption, reputational damage) and report cyber risk alongside all other enterprise risk categories on a single board dashboard. The table below maps the integration points.

ERM Integration Point What Cyber Risk Assessment Contributes ISO 31000 / COSO ERM Alignment
Enterprise risk register Cyber risks scored using the same likelihood x impact scales as operational and financial risks. Cyber risks appear on the same register, not a separate IT document. ISO 31000 Clause 6.4. COSO ERM Performance component.
Risk appetite statement Cyber risk appetite expressed in business terms: maximum acceptable downtime (hours), maximum data records exposed, maximum financial loss from cyber incident. ISO 31000 Clause 5.4. COSO ERM Strategy & Objective-Setting.
Board risk report Cyber risk section included in the quarterly board risk pack. KRI dashboard, top 5 cyber risks, treatment progress, and incident summary. ISO 31000 Clause 6.7. COSO ERM Information, Communication & Reporting.
Business continuity planning Cyber incident scenarios (ransomware, data breach, cloud outage) included in BCP exercises and disaster recovery testing. ISO 22301 Clause 8.5. COSO ERM Review & Revision.
Third-party risk management Vendor cyber risk assessments feed into the enterprise TPRM program. Vendor cyber KRIs monitored alongside financial and operational vendor risks. ISO 31000 Clause 6.4. COSO ERM Performance (third-party risk).
Three lines model 1st line: business units own cyber risk in their operations. 2nd line: CISO/security team provides framework, tools, and oversight. 3rd line: internal audit assesses cyber risk management effectiveness. IIA Three Lines Model. ISO 31000 Clause 5.4.

The three lines model is essential for cyber risk governance. The CISO is a second-line function: the CISO provides the framework, tools, and standards, but business units (first line) own their cyber risks and must take responsibility for following security policies, reporting incidents, and implementing controls within their systems.

Internal audit (third line) periodically assesses whether the cyber risk assessment process is effective and whether controls operate as designed.

Implementation Roadmap

Phase Actions Deliverables Success Metrics
Days 1-30: Scope and Discover Define assessment scope (enterprise-wide or critical systems first). Inventory information assets and classify by sensitivity. Build customized threat catalogue. Review existing vulnerability scan and audit findings. Identify applicable frameworks (NIST CSF, ISO 27001, PCI-DSS, HIPAA). Scope document. Asset inventory (classified). Customized threat catalogue. Regulatory applicability matrix. Existing findings compilation. Asset inventory covers 90%+ of critical systems. Threat catalogue customized to organization’s industry and geography. Scope approved by CISO.
Days 31-60: Assess and Score Conduct vulnerability scans on all in-scope systems. Run NIST CSF 2.0 control gap analysis. Score all threat-vulnerability pairs using the 5×5 matrix. Identify the top 20 cyber risks by composite score. Map risks to NIST CSF functions and subcategories. Vulnerability scan report with CVSS scores. CSF gap analysis (all 6 functions). Scored cyber risk register (top 20 risks). Risk heat map. CSF-to-risk mapping. Gap analysis completed across all CSF functions. Top 20 risks have assigned owners. Risk register reviewed by CISO and CRO.
Days 61-90: Treat, Monitor, Report Develop treatment plans for all risks scoring High or Critical. Deploy priority controls (MFA enforcement, encryption, patch acceleration). Launch KRI dashboard with 8 indicators. Present first cyber risk report to the risk committee. Integrate top cyber risks into the enterprise risk register. Treatment action plan (High/Critical risks). MFA enforcement status. KRI dashboard (operational). First cyber risk report. Updated enterprise risk register with cyber risks. Treatment plans funded and owned for all Critical risks. MFA enabled on 100% of privileged accounts. KRI dashboard generating weekly reports. Board-level cyber risk report delivered.

Common Pitfalls and How to Avoid Them

Pitfall Root Cause Remedy
Confusing vulnerability scanning with risk assessment The security team runs weekly Nessus scans and considers the output a “risk assessment” without analyzing threat context, business impact, or treatment priority Use vulnerability scans as one input. Combine with threat intelligence, business impact analysis, and control effectiveness review to produce a true risk assessment.
Cyber risk assessed in isolation from enterprise risk The CISO produces a security risk report that the CRO never sees. The board gets two separate risk presentations that do not connect. Integrate cyber risks into the enterprise risk register. Use NIST IR 8286 as the bridge document. Report cyber risk on the same dashboard as financial and operational risk.
Risk register with 500 technical vulnerabilities and no business context The register lists every CVE but does not explain which business processes are affected, what the financial impact would be, or who owns the treatment. Translate technical risks into business language. “CVE-2025-XXXX on server X” becomes “Unpatched vulnerability on payment processing system with $2M exposure if exploited.”
Annual assessment with no continuous monitoring The team produces a comprehensive assessment in Q1, then does not revisit the risk register until next Q1, missing new threats, new systems, and control degradation. Implement continuous KRI monitoring. Trigger reassessment when KRIs breach thresholds. Conduct quarterly targeted reviews of the top 10 risks.
Treatment plans without budgets or deadlines Risks are identified and scored, but treatment actions remain as aspirational “recommendations” with no funded plan, no owner, and no due date. Require every treatment action to have a named owner, approved budget, and deadline. Track treatment completion as a KPI reported to the risk committee monthly.
Overreliance on compliance as a proxy for security The organization passes its ISO 27001 audit and assumes cyber risk is managed. Compliance confirms controls exist; risk assessment confirms controls are sufficient. Conduct the compliance audit and the risk assessment as complementary activities. Compliance asks “do we have the control?” Risk assessment asks “is the control reducing the risk we face?”

FAQ Section: Cyber Risk Assessment

What is a cyber risk assessment?

A cyber risk assessment is the structured process of identifying cyber threats and vulnerabilities, analyzing their likelihood and impact, and prioritizing treatment against your organization’s risk appetite.

Following NIST SP 800-30, it moves beyond a technical scan to rank risks in business terms and feed a treatment plan. The output is a scored cyber risk register, a heat map, and board-ready reporting.

What are the seven steps of a cyber risk assessment?

A cyber risk assessment runs in seven steps: define scope and context, identify threats, identify vulnerabilities, analyze likelihood and impact, evaluate against risk appetite, treat risks, and monitor and report. NIST CSF 2.0 supplies the “what” through its six functions, while NIST SP 800-30 supplies the “how.” Each step produces an artifact, from the asset inventory to the quarterly cyber risk report.

How is a cyber risk assessment different from a vulnerability scan or penetration test?

A vulnerability scan lists technical flaws, and a penetration test proves which ones are exploitable, but neither ranks risk by business impact.

A cyber risk assessment integrates threats, vulnerabilities, likelihood, impact, and residual risk into a prioritized treatment plan. A compliance audit confirms a control exists without testing whether it is sufficient against real threats, a gap CISA guidance repeatedly flags. Run scans and tests as inputs, not substitutes.

How often should a cyber risk assessment be performed?

Annual is the floor, but a cyber risk assessment should be continuous in practice. Refresh it whenever a major system changes, after a security incident, when entering a new market, or when threat intelligence shifts, and monitor key risk indicators between full cycles. NIST CSF 2.0 frames risk management as an ongoing function. A breach threshold or failed KRI should trigger immediate reassessment.

What frameworks are used for cyber risk assessment?

Most US programs anchor a cyber risk assessment on NIST CSF 2.0 for governance and NIST SP 800-30 for method, with 54% of companies naming CSF their primary framework. ISO/IEC 27001 supports certification-driven programs, while FAIR adds quantitative, dollar-based loss modeling. MITRE ATT&CK supplies the threat catalogue. Pick one backbone and borrow from the others rather than running all of them at once.

How do you score cyber risk in a cyber risk assessment?

Qualitative scoring multiplies likelihood (1-5) by impact (1-5) on a 5×5 matrix, producing a 1-to-25 score that bands risk from low to critical. Quantitative scoring, using a model like FAIR, expresses the same exposure in dollars and probability ranges. A mature cyber risk assessment starts qualitative for speed, then quantifies the top risks so leadership can compare cyber against financial and operational risk.

Why does a cyber risk assessment matter, and what does a breach cost?

The financial case is direct. The average data breach reached $4.88 million globally in 2024, rising to $6.08 million in financial services, and 30% of breaches now involve a third party.

A cyber risk assessment turns those abstract threats into ranked, budgeted decisions before an incident forces them. It also satisfies regulators and insurers who demand evidence that cyber risk is measured, owned, and reported.

What are the most common cyber risk assessment mistakes?

Five recur. Treating a vulnerability scan as a finished assessment. Keeping cyber risk in an isolated CISO report instead of mapping it to the enterprise register via NIST IR 8286.

Listing 500 CVEs with no business context. Assessing once a year with no continuous monitoring. Writing treatment plans with no owner, budget, or deadline. Each one turns a cyber risk assessment into shelfware.

Looking Ahead: Cyber Risk Assessment Trends 2025-2027

NIST’s December 2025 update to the IR 8286 series strengthens the integration of cybersecurity risk with enterprise risk management, providing specific guidance on how to express cyber risk in financial terms and incorporate cyber risk into strategic planning.

Organizations that have not yet adopted this integration should prioritize the update as part of their 2026 risk management improvement plan.

AI-driven cyber risk assessment tools are automating threat identification, vulnerability correlation, and risk scoring at speeds that manual processes cannot match.

Security AI and automation reduced breach identification and containment time by nearly 100 days (IBM, 2024).

AI risk assessment frameworks are emerging as a necessity because AI itself introduces new risk categories (model poisoning, adversarial inputs, bias in security decisions) that must be assessed alongside traditional cyber risks.

Supply chain cyber risk continues to escalate. Verizon’s 2025 DBIR found that third-party involvement in breaches doubled to 30%. Third-party risk management must now include continuous cyber monitoring of critical vendors, not just annual questionnaires. The most effective programs combine vendor security ratings with contractual SLAs and real-time threat intelligence feeds.

The organizations that assess cyber risk most effectively share one trait: they treat the assessment as a continuous business process, not an annual IT project.

Continuous threat monitoring feeds into quarterly risk reassessments, which feed into board-level reporting, which drives investment decisions, which fund the controls that reduce the next quarter’s risk.

That continuous cycle, anchored by NIST CSF 2.0 and integrated into enterprise risk management, is the standard that separates organizations that manage cyber risk from those that merely document the risk they wish they had managed.

Ready to conduct a cyber risk assessment? Visit riskpublishing.com to access cybersecurity KRI guides, risk register templates, and NIST CSF 2.0 implementation resources. Need a tailored cyber risk assessment? Contact our consulting team to design a program aligned to your threat landscape and regulatory requirements.
