In 2008, California voters approved a high-speed rail line from Los Angeles to San Francisco for $33 billion.

By its 2026 draft business plan, the California High-Speed Rail Authority pegged Phase 1 alone near $126 billion, and 597 change orders had added $2.3 billion by November 2025.

That blown budget is the strongest argument going for project controls manager jobs.

Project controls is the discipline that keeps cost, schedule, and risk from drifting, and the project controls manager owns it.

When a program runs 600% over its original number, the failure is almost always a project-controls failure. This guide covers what the role does, what it pays in 2026, the certifications that win offers, and how to break in.

Key Takeaways
Project controls manager jobs center on holding a project’s schedule, cost, and risk under control, the discipline megaprojects like California High-Speed Rail famously lost.
U.S. project controls managers average $116,000 to $134,000, with senior roles on large programs clearing $167,000.
Oxford research finds nine in ten megaprojects run over budget, and a $1.2 trillion U.S. infrastructure pipeline keeps demand high.
An engineering or construction degree plus an AACE (CCP, PSP, EVP) or PMP certification and Primavera P6 skills is the standard entry path.
The role is risk management applied to cost and schedule, so risk literacy separates the strongest candidates.

Project Controls Manager Jobs: The 2026 Role, Salary, and Career Guide

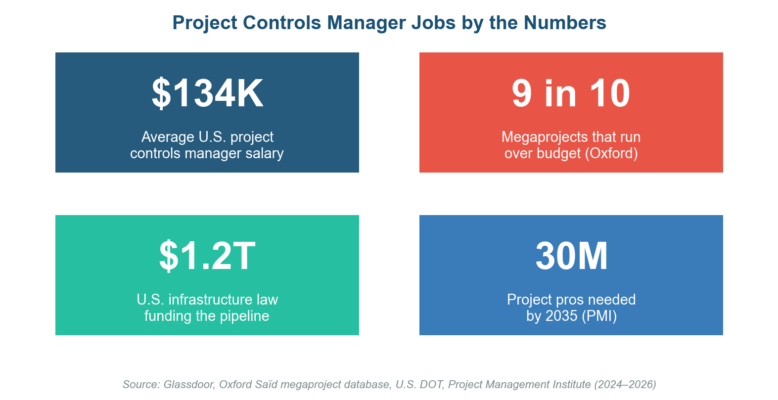

Figure 1. The demand and pay that define project controls manager jobs in 2026.

Why Project Controls Manager Jobs Are in Demand in 2026

The case for project controls manager jobs is written in blown budgets.

Oxford’s Bent Flyvbjerg, who built a database of more than 16,000 projects, found that nine in ten megaprojects run over budget, over schedule, or both.Every one of those overruns is work for someone who can hold cost and time in line.

Project Controls Manager Jobs: The 2026 Role, Salary, and Career Guide

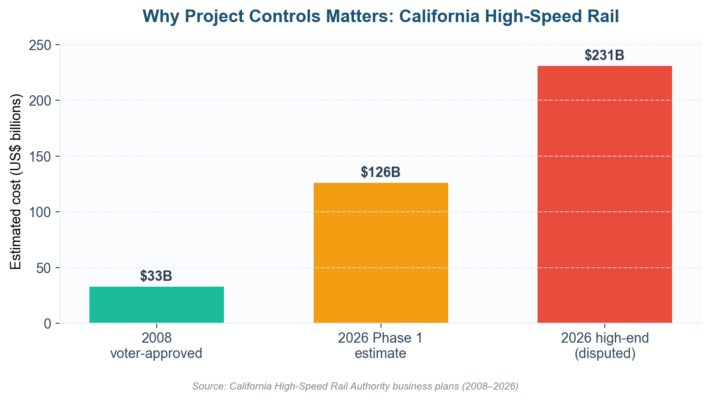

Figure 2. California High-Speedcan hold cost and time in line. Rail: the cost-control failure project controls manager jobs exist to prevent.

The work is funded, not theoretical.

The 2021 Bipartisan Infrastructure Law put $1.2 trillion into U.S. roads, rail, water, and grid projects, and the Project Management Institute projects a 30 million-person shortfall of project professionals by 2035.

Project controls managers sit at the center of spending that money without repeating California’s mistakes.

Demand spans industries. Construction firms, energy and utilities, aerospace, transportation agencies, and oil and gas all hire project controls managers, and contractors such as Bechtel, Fluor, and Kiewit compete for the same scarce talent.

The bigger and more regulated the capital program, the more a project controls manager earns their seat at the table.

The economics are blunt. On a billion-dollar program, a 10% overrun is $100 million, which dwarfs any project controls manager salary, so employers treat the role as cheap insurance.

That math is why funded megaprojects now post project controls manager jobs before they break ground rather than after the budget already slips.

What a Project Controls Manager Actually Does

Strip away the job-board language and a project controls manager has one job: keep a project’s cost, schedule, and risk from drifting.

They build the baseline schedule and budget, track actuals against it, forecast where the program is heading, and flag deviations early enough to fix. The role is the early-warning system for a capital project.

Responsibility What it involves
Schedule control Build and maintain the baseline schedule; track progress against it
Cost control Estimate, monitor, and forecast the budget; analyze variances
Earned value management Tie cost and schedule into one performance metric
Risk management Maintain the risk register; escalate threats and mitigation actions
Reporting Produce cost-and-schedule reports for management and clients
Change control Track change orders and their effect on cost and end date

The core duties that define project controls manager jobs.

The work is analytical and relentless.

A project controls manager runs earned value analysis, maintains the risk register, updates cash-flow forecasts, and produces the reports senior management and clients rely on.

When the numbers move, the manager explains why and what it means for the budget and the end date.

Schedule, Cost, and Risk: The Project Controls Manager Toolkit

Project controls rests on three pillars, and a project controls manager has to be fluent in all of them.

Schedule control plans and tracks the timeline; cost control estimates and monitors the budget; risk control identifies and mitigates what could derail either. Earned value management ties the three into a single health metric the board can read.

Project Controls Manager Jobs: The 2026 Role, Salary, and Career Guide

Figure 3. The schedule, cost, and risk pillars every project controls manager job is built on.

The tools are specific. Most project controls managers live in Oracle Primavera P6 for scheduling, build cost models in Excel or specialist software, and report through dashboards.

Mastery of those tools, paired with a structured risk management lifecycle, is what the best-paid project controls manager jobs screen for, alongside familiarity with standards like ISO 21502 that define good practice.

Earned value management deserves its own mention.

By comparing the budgeted cost of work performed against actual cost and planned value, a project controls manager turns the question “are we on track” into two numbers: the cost performance index and the schedule performance index.

Those indices are the language clients, lenders, and auditors expect in every status report.

Project Controls Manager Salary: What the Role Pays

Pay reflects the stakes. ZipRecruiter puts the average U.S. project controls manager salary near $116,000 in 2026, while Glassdoor reports $134,000, with most roles between $85,000 and $167,000.

Senior project controls managers on large capital programs clear $167,500 at the 90th percentile, well above most general project-management roles.

Project Controls Manager Jobs: The 2026 Role, Salary, and Career Guide

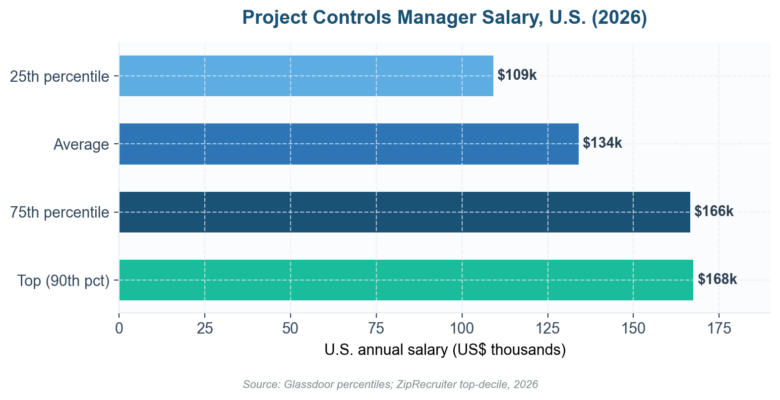

Figure 4. Project controls manager salary climbs steeply from the 25th percentile to the top decile.

Industry and project size move the number more than tenure.

Oil and gas, power, and large infrastructure pay above construction-wide medians because a single overrun dwarfs any salary, and the U.S.

Bureau of Labor Statistics reports a 2024 median of $106,980 for construction managers and about $77,000 for cost estimators as baselines, with project management specialists at a $100,750 median.

Project controls managers on billion-dollar programs earn well beyond all three.

Qualifications and Skills for Project Controls Manager Jobs

Qualifications set the floor. Most project controls manager jobs ask for a bachelor’s degree in engineering, construction management, or a related field, plus several years on capital projects.

From there, certifications and tool fluency decide who advances, and the strongest candidates pair technical depth with the judgment to read a program’s health at a glance.

Technical Skills for Project Controls Manager Jobs

Technical skill is the price of entry. A project controls manager has to build and maintain schedules, run earned value and variance analysis, model costs, and interpret key risk indicators.

Fluency in Primavera P6 and cost-control software, plus the ability to turn raw data into a credible forecast, separates a controls manager from an analyst.

Certifications That Win Project Controls Manager Jobs

Certifications signal credibility. AACE International offers the field’s specialist credentials, including the Certified Cost Professional, Planning and Scheduling Professional, and Earned Value Professional, while the PMP and PMI Scheduling Professional round out a strong profile.

Our guide to the best risk management certifications maps adjacent options, and the PMBOK Guide anchors the project management exams.

Certification Body Focus
CCP (Certified Cost Professional) AACE International Total cost management across the project
PSP (Planning & Scheduling Professional) AACE International Schedule development and control
EVP (Earned Value Professional) AACE International Earned value management
PMP PMI Broad project management
PMI-SP PMI Project scheduling
Primavera P6 certification Oracle Scheduling-tool proficiency

Certifications that strengthen applications for project controls manager jobs.

Soft Skills in Project Controls Manager Jobs

Soft skills decide the senior roles. A project controls manager has to deliver hard news to a client, align cross-functional teams, and explain a cost variance to a board without losing them.

Clear communication and steady judgment under deadline pressure matter as much as the modeling, because the data only helps when people act on it.

The career path is well-mapped. Project controls analysts move into controls manager roles after three to five years, then into senior controls manager and director of project controls on the largest programs.

Each step widens the span from a single project to a portfolio, and pay follows responsibility, which is why early certification and domain focus pay off.

The Risk Management Core of Project Controls Manager Jobs

Underneath the schedules and cost models, project controls is risk management applied to budget and time.

A project controls manager spends the day asking what could push the cost or the end date and what to do about it. That makes a recognizable operational risk management process the spine of the role, not an add-on.

The strongest practitioners borrow straight from enterprise risk. They rank threats with scenario-based risk assessment, track them against a defined risk appetite, and map the work to the five steps of the risk management process.

That discipline keeps a sprawling, multi-contractor program coherent instead of reactive, even when a dozen subcontractors push the schedule and budget in different directions at once.

Two domains dominate the risk register. Subcontractor and vendor failures expose programs to third-party risk, and long-lead procurement adds supply chain risk that a single delay can turn into a schedule slip.

Knowing how to mitigate risk before it lands is the difference between a forecast and a surprise.

Disputes make this concrete. When a program slips, the contract fight is usually about which party owns the delay, and a project controls manager’s records become the evidence: the baseline, the change log, and the risk register.

Disciplined controls are what turn a $2.3 billion change-order pile like California’s into something defensible rather than a black box.

Where Project Controls Manager Jobs Are Heading: 2026-2027

The role is getting more data-driven. AI-assisted forecasting, real-time cost dashboards, and analytics on historical project data are moving project controls from monthly reporting toward continuous prediction.

The project controls managers who pair classic earned value discipline with these tools will command the strongest roles through the decade.

Funded work keeps the pipeline full. Infrastructure spending, grid modernization, data-center construction, and energy-transition projects all need cost and schedule control, and oversight bodies like the GAO keep scrutinizing overruns.

That scrutiny turns disciplined project controls from a nice-to-have into a contract requirement on federal and large private programs alike.

Risk is moving to the center. As boards and regulators demand proof that capital programs can absorb disruption, enterprise risk frameworks and resilience thinking are bleeding into project controls.

The next decade rewards managers who treat cost, schedule, and risk as one connected problem rather than three separate reports filed after the fact, which is increasingly how lenders and auditors judge a program.

Common Project Controls Manager Career Mistakes

Capable people still stall on predictable errors. The most common is staying a tool operator, fluent in Primavera P6 but unable to tell a director what the schedule actually means.

A close second is treating the risk register as paperwork until an unmanaged threat becomes a change order nobody saw coming.

  • Mastering the software but not the story: building flawless schedules you cannot explain to a client.
  • Letting the risk register go stale until a missed threat becomes a costly change order.
  • Reporting lagging actuals instead of forecasting where cost and schedule are heading.
  • Skipping certification while AACE- or PMP-credentialed peers advance faster.
  • Staying a generalist when energy, infrastructure, and data-center programs pay for domain depth.

The fix is to grow past the tools. Pair Primavera fluency with a real grasp of how to conduct a risk assessment, earn a specialist certification, and learn to translate data into decisions.

Project controls managers who treat the role as risk-led rather than report-led are the ones who reach director.

Project Controls Manager Jobs: Your Questions Answered

What does a project controls manager do?

A project controls manager keeps a project’s cost, schedule, and risk under control.

They build the baseline schedule and budget, track actuals, run earned value analysis, maintain the risk register, and forecast where the program is heading.

They produce the cost-and-schedule reports management and clients use to make decisions, and they flag deviations early enough to correct them.

How much do project controls manager jobs pay?

U.S. project controls manager jobs pay an average of roughly $116,000 to $134,000 in 2026, depending on the source, with most roles between $85,000 and $167,000.

Senior managers on large oil-and-gas, power, or infrastructure programs clear $167,500 at the top decile. Industry and project size move pay more than years of experience alone.

What qualifications do project controls manager jobs require?

Most project controls manager jobs require a bachelor’s degree in engineering, construction management, or a related field, plus several years on capital projects. Employers expect fluency in Primavera P6 and earned value management.

An AACE certification (CCP, PSP, or EVP) or a PMP strengthens any application and is often what separates shortlisted candidates from the rest.

What is the difference between a project controls manager and a project manager?

A project manager owns the whole project, including scope, stakeholders, and delivery.

A project controls manager owns the cost, schedule, and risk data that tell the project manager whether the project is on track.

The controls manager is the analytical engine; the project manager makes the call. On large programs, the two roles are separate and complementary.

Which certifications help with project controls manager jobs?

AACE International credentials are the specialist standard for project controls manager jobs: the Certified Cost Professional, Planning and Scheduling Professional, and Earned Value Professional.

The PMP and PMI Scheduling Professional add broad project management credibility, and an Oracle Primavera P6 certification proves tool fluency. Most senior controls managers hold at least one specialist and one general credential.

Which industries hire project controls managers?

Construction, oil and gas, power and utilities, transportation and infrastructure, aerospace, and large manufacturing all hire project controls managers.

The common thread is capital-intensive projects where a cost or schedule overrun is expensive. Engineering and construction contractors such as Bechtel, Fluor, and Kiewit, along with public transportation agencies, are among the most active employers.

Is project controls manager a good career?

Yes, for people who like data and accountability. Pay is strong, demand tracks a $1.2 trillion infrastructure pipeline and a projected 30 million-person project-talent shortfall by 2035, and the work matters more as overruns grow more public.

The role also opens a clear path to senior project controls manager and director of project controls.

Project controls manager jobs reward the rare professional who can hold cost, schedule, and risk together while a program tries to drift in every direction.

The California High-Speed Rail story is what the role exists to prevent, and the funded pipeline behind it is why demand stays strong. Build the technical base, earn a specialist certification, and treat the work as risk management, and the path runs straight to director.
