| Key Takeaways |
| Cost risk analysis is the process of identifying, quantifying, and managing financial uncertainties that could push a project beyond its approved budget. The basic formula is Expected Monetary Value (EMV) = Probability x Cost Impact. |
| NASA’s 2025 GAO assessment found that four of 18 major projects reported over $500 million in collective annual cost overruns. NNSA construction overruns grew from $2.1 billion to $4.8 billion between 2023 and 2025. Cost risk analysis prevents these outcomes. |
| Three-point estimation (PERT) and Monte Carlo simulation are the two most powerful quantitative techniques. PERT provides quick estimates; Monte Carlo produces probability distributions that tell you the confidence level at any budget point. |
| A worked example in this guide walks through a $2.4 million IT infrastructure project, showing how to identify cost risks, calculate EMV, run a Monte Carlo simulation, and derive a contingency reserve of $182,000 (7.6% of the base estimate). |
| Sensitivity analysis using tornado charts reveals which cost variables drive the most uncertainty, focusing management attention on the two or three inputs that matter most. |
| Cost risk analysis must integrate with schedule risk analysis because time-dependent costs (labor burn rates, equipment rental, overhead) amplify every schedule delay into a budget overrun. |
| A 90-day roadmap takes your organization from deterministic single-point estimates to probabilistic cost risk analysis with Monte Carlo confidence levels and contingency reserves tied to risk appetite. |
The U.S. Government Accountability Office (GAO, 2025) reported that four of NASA’s 18 major projects experienced cost overruns totaling over $500 million in a single year.
Across the National Nuclear Security Administration, cumulative cost overruns on major construction projects grew from $2.1 billion to $4.8 billion between 2023 and 2025. These are not small organizations with unsophisticated planning capabilities.
They are among the most technically advanced project portfolios on earth, and they still get blindsided by cost uncertainty.
Cost risk analysis is the structured process that prevents this outcome, or at least quantifies it honestly.
Rather than relying on a single-point budget estimate and hoping nothing goes wrong, cost risk analysis assigns probability distributions to uncertain cost elements, simulates thousands of possible outcomes, and produces a contingency reserve that reflects the actual level of uncertainty in the project.
The result: leadership knows the probability of staying within budget at any confidence level, from P50 (50% chance) to P80 (80% chance) to P95 (near-certain).
This guide provides a complete cost risk analysis framework with worked examples you can apply immediately. Each section aligns to ISO 31000, PMI PMBOK, and COSO ERM, with techniques ranging from simple expected monetary value calculations to full Monte Carlo simulation.
What Is Cost Risk Analysis?
Cost risk analysis is a structured approach to identifying, evaluating, and managing financial uncertainties that may cause a project, program, or business operation to exceed its approved budget.
The analysis quantifies cost uncertainty rather than ignoring the uncertainty and presents decision-makers with a range of possible outcomes tied to probability levels.
Every project risk assessment should include a cost dimension. Project risk management standards like PMBOK 7th Edition and ISO 31000 both require that cost uncertainty be analyzed alongside schedule, scope, and quality risks. The table below defines the core terminology.
Cost Risk Analysis: Core Terminology
| Term | Definition |
| Base Estimate | The deterministic (single-point) cost estimate before any risk adjustment. Assumes everything goes according to plan. |
| Expected Monetary Value (EMV) | Probability of a risk occurring multiplied by the cost impact if the risk materializes. EMV = P x I. |
| Contingency Reserve | Budget set aside to cover known risks (identified in the risk register). Controlled by the project manager. |
| Management Reserve | Budget held by senior management to cover unknown risks (“unknown unknowns”). Typically 5-10% of the total estimate. |
| P50 / P80 / P95 Confidence Level | The budget amount at which there is a 50%, 80%, or 95% probability the project will complete at or under that cost. |
| Three-Point Estimate (PERT) | Estimates cost using optimistic, most likely, and pessimistic values. PERT mean = (O + 4M + P) / 6. |
| Monte Carlo Simulation | A computational technique that runs thousands of random iterations using probability distributions to produce a cumulative probability curve of total project cost. |
| Sensitivity Analysis | Identifies which cost variables contribute the most uncertainty. Often displayed as a tornado chart. |
The Cost Risk Formula: A Basic Worked Example
The simplest cost risk calculation uses Expected Monetary Value: EMV = Probability x Cost Impact.
This formula works well for individual risks but does not account for the combined effect of multiple risks occurring simultaneously. Start here, then graduate to Monte Carlo.
Worked Example: IT Infrastructure Upgrade ($2.4 Million Base Estimate)
A mid-sized company is planning a data center infrastructure upgrade with a base estimate of $2,400,000.
The project team has identified six cost risks through brainstorming, vendor consultations, and historical project review. The table below calculates the EMV of each risk.
| # | Risk Event | Probability | Cost Impact | EMV | Risk Owner | Treatment Strategy |
| 1 | Server hardware price increase due to supply chain disruption | 35% | $120,000 | $42,000 | Procurement Lead | Lock pricing in contract; identify alternate supplier |
| 2 | Scope creep: additional storage requirements discovered during migration | 50% | $80,000 | $40,000 | Project Manager | Enforce change control; budget a 10% scope buffer |
| 3 | Labor cost overrun from specialist contractor unavailability | 30% | $150,000 | $45,000 | HR / PMO | Secure fixed-rate contracts; pre-book contractors 90 days ahead |
| 4 | Regulatory compliance upgrade required mid-project | 15% | $200,000 | $30,000 | Compliance Officer | Monitor regulatory pipeline; design for compliance flexibility |
| 5 | Testing phase extends 3 weeks beyond plan | 40% | $60,000 | $24,000 | QA Lead | Automate testing; add buffer to test schedule |
| 6 | Data migration errors requiring rework | 20% | $5,000 | $1,000 | Data Engineer | Run pilot migration; validate data integrity before cutover |
Total EMV (Contingency Reserve) = $182,000 (7.6% of the $2,400,000 base estimate). This amount should be added to the base estimate as the risk-adjusted contingency. The risk-adjusted project budget is $2,582,000.
The EMV approach has a limitation: adding individual EMVs assumes risks are independent, which they rarely are.
If Risk 1 (hardware price increase) and Risk 3 (labor cost overrun) both occur simultaneously, the combined impact may exceed the sum of their individual EMVs due to cascading effects. Monte Carlo simulation solves this by modeling thousands of scenarios with correlated inputs.
Three-Point Estimation (PERT) for Cost Risk
Three-point estimation replaces single-point cost estimates with a range. Each cost element gets three values: optimistic (O), most likely (M), and pessimistic (P). The PERT weighted mean = (O + 4M + P) / 6. The standard deviation = (P – O) / 6. This technique is faster than Monte Carlo and requires no software, making the method ideal for initial estimates and smaller projects.
Three-Point Estimation Example: Same IT Project
| Cost Element | Optimistic (O) | Most Likely (M) | Pessimistic (P) | PERT Mean | Std Dev | Variance |
| Hardware and licensing | $850,000 | $950,000 | $1,200,000 | $966,667 | $58,333 | $3,402,777,889 |
| Labor (internal + contractors) | $600,000 | $750,000 | $1,050,000 | $775,000 | $75,000 | $5,625,000,000 |
| Data migration services | $180,000 | $220,000 | $340,000 | $230,000 | $26,667 | $711,128,889 |
| Testing and QA | $100,000 | $140,000 | $240,000 | $150,000 | $23,333 | $544,428,889 |
| Project management overhead | $200,000 | $250,000 | $350,000 | $258,333 | $25,000 | $625,000,000 |
| Contingency (from EMV) | $120,000 | $182,000 | $300,000 | $192,000 | $30,000 | $900,000,000 |
Total PERT Mean = $2,572,000. Total variance = sum of individual variances = $11,808,335,667.
Total standard deviation = square root of total variance = $108,674. At P80 confidence (mean + 0.84 standard deviations), the budget should be $2,572,000 + (0.84 x $108,674) = $2,663,286.
At P95 confidence (mean + 1.645 standard deviations), the budget should be $2,750,768. This gives leadership a clear choice: fund at $2.57M and accept a 50% chance of overrun, or fund at $2.66M and accept a 20% chance.
Monte Carlo Simulation for Cost Risk Analysis
Monte Carlo simulation is the gold standard for cost risk analysis on complex projects. The technique runs thousands of random iterations (typically 5,000-10,000) where each cost element is sampled from its probability distribution.
The result is a cumulative probability curve (S-curve) that shows the probability of completing the project at any given budget level.

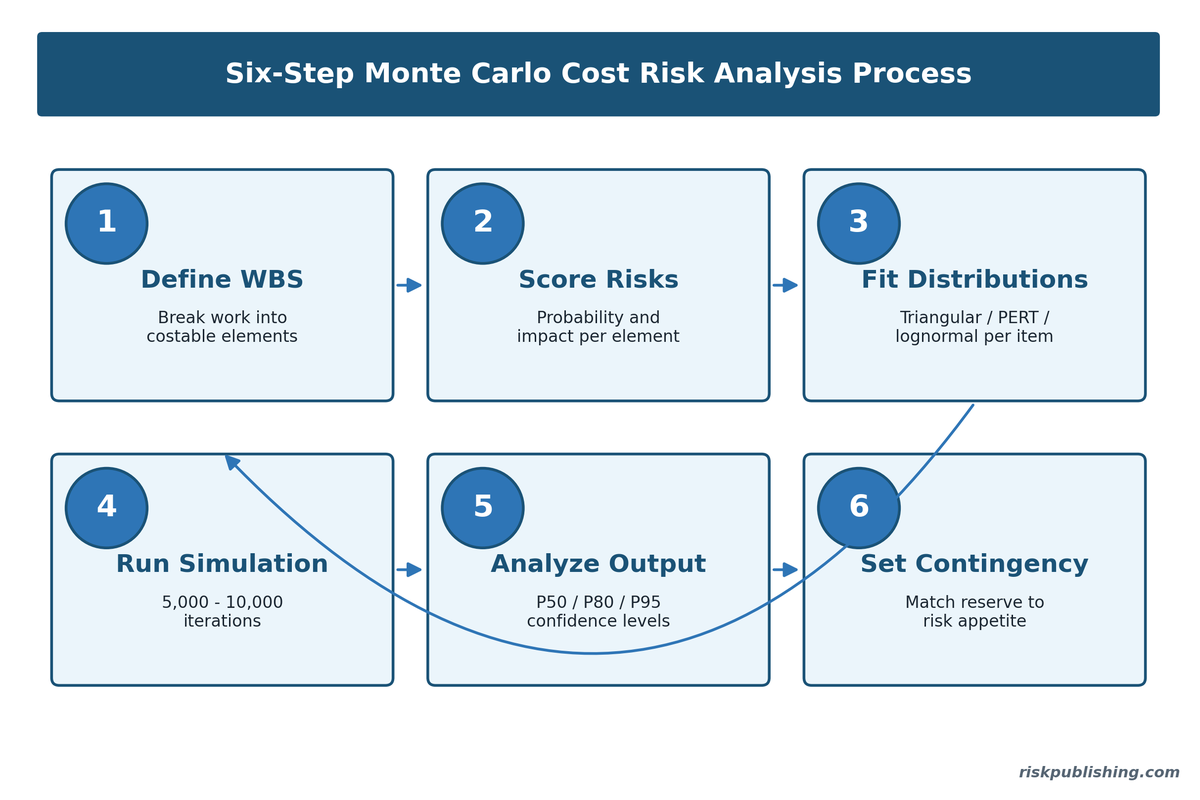

Monte Carlo Process: Step by Step
| Step | Description |
| 1 | Define cost elements using the Work Breakdown Structure (WBS). Each element gets a probability distribution (triangular, PERT, lognormal, or uniform) based on available data. |
| 2 | Identify correlations between cost elements. Labor and schedule are positively correlated (if one goes up, so does the other). Hardware and licensing may be correlated to supply chain conditions. |
| 3 | Run 5,000-10,000 iterations. Each iteration randomly samples from every distribution, applies correlations, and sums the total project cost. |
| 4 | Plot the results as a cumulative probability curve (S-curve). Read off the P50, P80, and P95 values. |
| 5 | Run a sensitivity analysis to identify which cost elements contributed the most to total cost variance. Display results as a tornado chart. |
| 6 | Calculate the contingency reserve as the difference between the P80 (or P-level aligned to risk appetite) and the base estimate. |
Tools for Monte Carlo cost analysis include @RISK (Palisade), Crystal Ball (Oracle), Primavera Risk Analysis, and open-source options like Python with NumPy/SciPy.
Even Excel with a simple VBA macro can run basic simulations for projects with fewer than 20 cost elements.
Sensitivity Analysis: Finding What Drives Cost Risk
Tornado charts are the output of sensitivity analysis and show which cost variables contribute the most to total project cost uncertainty.
The chart ranks variables from highest to lowest impact, creating a visual funnel that focuses management attention on the two or three inputs that matter most.

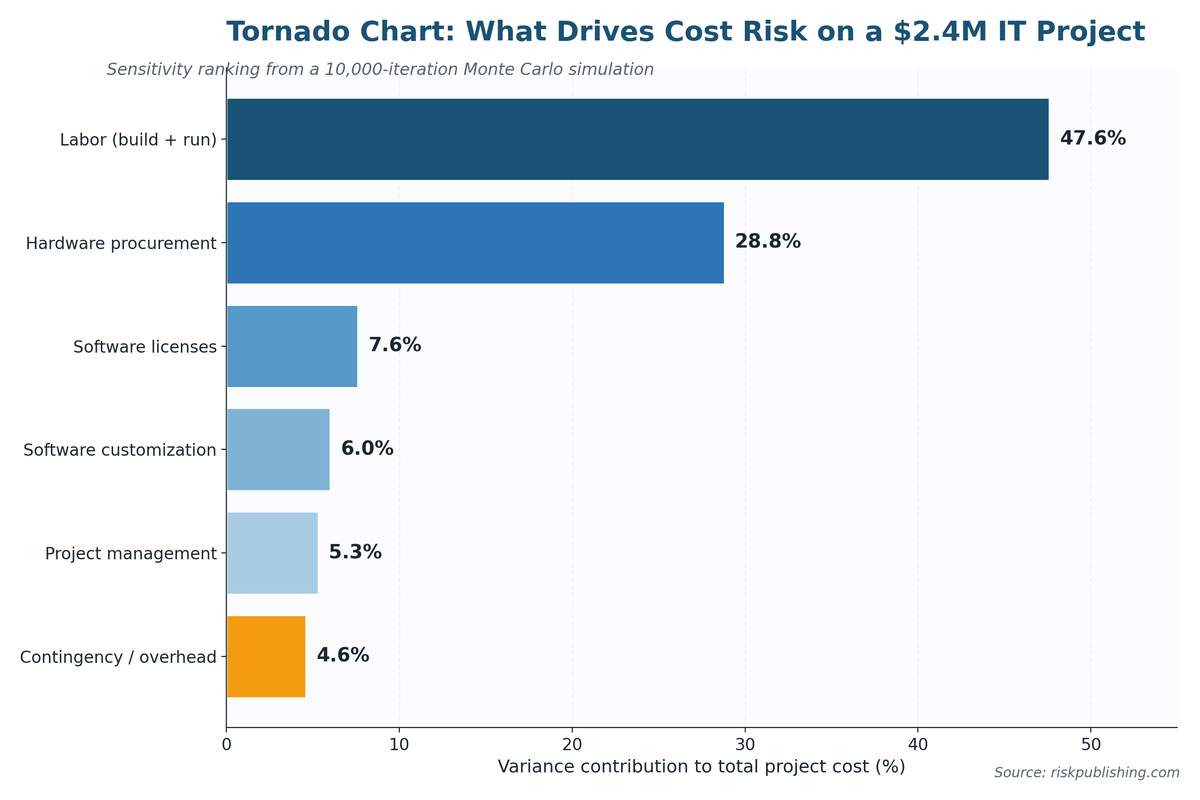

Tornado Chart Results: IT Infrastructure Example
| Cost Variable | Contribution to Total Variance | Management Action |
| Labor (internal + contractors) | 47.6% of total variance | This is the dominant cost driver. Lock contractor rates. Secure resource commitments 90 days before project start. Build schedule buffer to prevent overtime. |
| Hardware and licensing | 28.8% of total variance | Second largest driver. Negotiate fixed pricing with vendors. Maintain an approved alternate supplier list. Purchase long-lead items early. |
| Contingency (risk events) | 7.6% of total variance | Managed through the EMV-based contingency reserve. Track risk register monthly to update probability and impact estimates. |
| Testing and QA | 4.6% of total variance | Moderate contributor. Automate regression testing. Pre-define acceptance criteria to prevent rework cycles. |
| Data migration services | 6.0% of total variance | Run a pilot migration early to validate effort estimates. Build data cleansing time into the schedule. |
| Project management overhead | 5.3% of total variance | Relatively stable. Budget at the PERT mean and monitor against earned value. |
The tornado chart tells a clear story: labor and hardware account for 76% of total cost uncertainty. If the project manager can lock contractor rates and hardware pricing, the cost risk profile drops dramatically.
The remaining variables contribute relatively minor uncertainty and can be managed through standard contingency reserves.
Integrating Cost Risk with Schedule Risk
Cost and schedule risk are inseparable. Every day a project runs late, time-dependent costs accumulate: labor burns, equipment sits idle or accrues rental charges, and overhead continues.
A risk assessment that analyzes cost without schedule, or schedule without cost, will understate total project risk. PMI’s research consistently shows that integrated cost-schedule analysis produces more accurate forecasts than separate analyses.

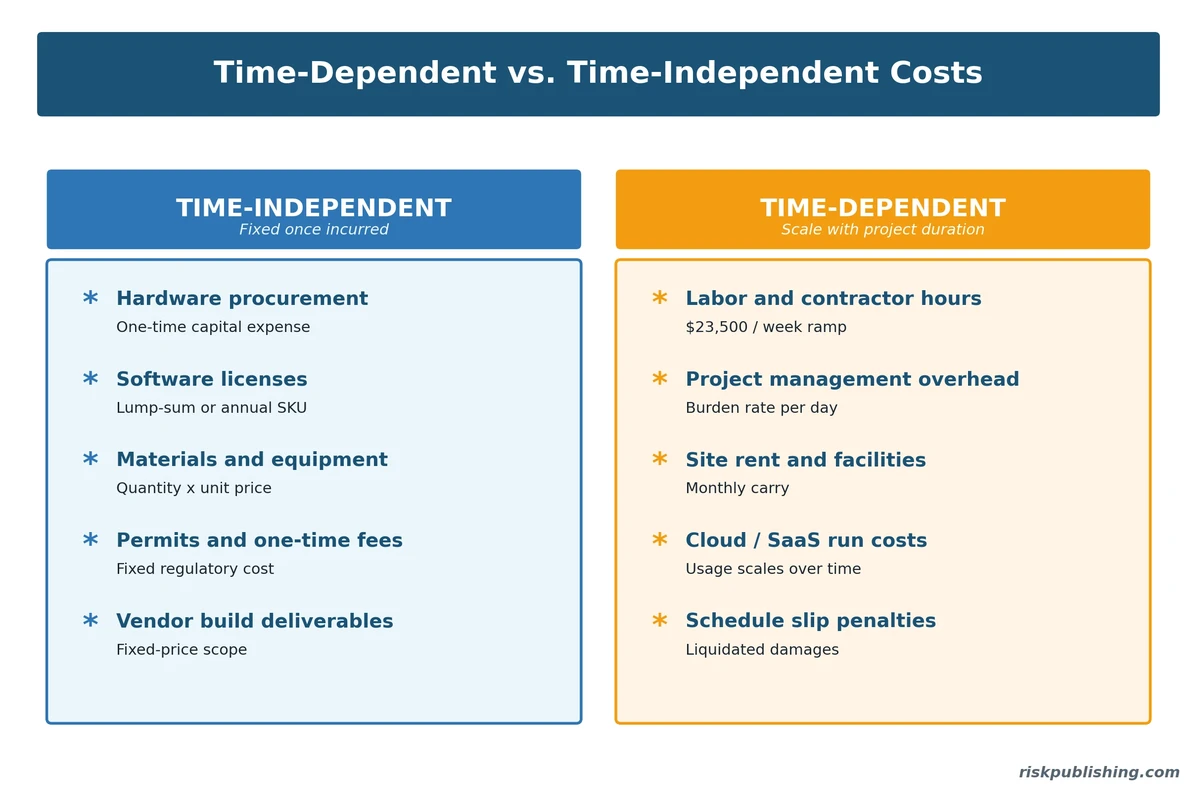

Time-Dependent vs. Time-Independent Costs
| Cost Type | Definition | Examples |
| Time-Independent | Costs that do not change based on project duration. Fixed purchases, one-time license fees, or milestone payments. | Server hardware purchase ($950K), software licenses ($200K), one-time data migration tool ($30K) |
| Time-Dependent | Costs that accumulate based on how long the project takes. Driven by daily/weekly burn rates. | Contractor labor ($15K/week), PM overhead ($5K/week), cloud hosting during migration ($2K/week), facility costs ($1.5K/week) |
The daily burn rate on our IT infrastructure example is approximately $23,500 per week in time-dependent costs.
A three-week schedule overrun adds $70,500 to the project cost, independent of any discrete risk events.
This is why the testing extension risk (#5 in our EMV table) has a $60,000 impact: the testing phase alone burns approximately $20,000 per week in labor and environment costs. Integrated analysis captures this relationship automatically.
Aligning Cost Risk Analysis to ISO 31000 and COSO ERM
Cost risk analysis sits within the broader risk management lifecycle. ISO 31000 Clause 6.4 (Risk Assessment) requires analysis of both the likelihood and consequences of identified risks.
Cost risk analysis provides the financial consequence dimension. COSO ERM requires that risk assessment inform resource allocation decisions, which is exactly what a Monte Carlo S-curve enables.
| Framework Element | What It Requires | Cost Risk Analysis Technique |
| ISO 31000 Clause 6.4.2: Risk Identification | Identify sources, events, and consequences | Cost risk identification through WBS-level analysis, vendor assessment, historical data review |
| ISO 31000 Clause 6.4.3: Risk Analysis | Determine likelihood and consequences; consider uncertainty | Three-point estimation, Monte Carlo simulation, sensitivity analysis (tornado charts) |
| ISO 31000 Clause 6.4.4: Risk Evaluation | Compare against criteria; prioritize for treatment | EMV ranking, S-curve confidence levels vs. risk appetite, tornado chart prioritization |
| ISO 31000 Clause 6.5: Risk Treatment | Select and implement treatment options | Contingency reserves, contract structures (FFP vs. cost-plus), hedging, value engineering |
| COSO ERM: Performance | Assess severity; prioritize risks; implement responses | Budget at P80 confidence; allocate contingency to highest-EMV risks; track earned value |
| COSO ERM: Review & Revision | Monitor performance; adjust as needed | Monthly cost risk re-assessment; update distributions as actuals replace estimates; variance analysis |
Implementation Roadmap
Transitioning from deterministic single-point estimates to probabilistic cost risk analysis requires new processes, tools, and skills. The roadmap below phases the transition so teams build confidence before tackling full Monte Carlo analysis.
| Phase | Actions | Deliverables | Success Metrics |
| Days 1-30: Foundation | Train project managers on three-point estimation and EMV calculation. Standardize the cost risk register template (Risk ID, Description, Probability, Impact, EMV, Owner, Treatment). Conduct a pilot EMV analysis on one active project. | Three-point estimation training completed. Standardized cost risk register template. Pilot EMV analysis with contingency recommendation. | 100% of active PMs trained. Pilot project has a risk-adjusted budget approved by the sponsor. |
| Days 31-60: Build | Introduce tornado chart sensitivity analysis on all projects above $1M. Procure or configure Monte Carlo simulation tool (commercial or Excel-based). Run the first Monte Carlo simulation on the pilot project. Define the organization’s standard confidence level (P80 recommended). | Tornado charts for all projects >$1M. Monte Carlo simulation results (S-curve) for the pilot. Standard confidence level policy document. | Tornado charts identify top 3 cost drivers per project. Monte Carlo S-curve reviewed by project sponsor. P-level policy approved by PMO. |
| Days 61-90: Operationalize | Roll out Monte Carlo analysis to all projects above $5M. Integrate cost risk analysis into the project gate review process. Publish the first quarterly cost risk portfolio report. Link contingency reserves to risk appetite thresholds. | Monte Carlo S-curves for all major projects. Updated gate review checklist requiring cost risk analysis. Quarterly portfolio cost risk report. | All major projects have P80 budgets. Gate reviews include cost risk as a mandatory approval criterion. Portfolio report shows aggregate cost exposure across all projects. |
Common Pitfalls and How to Avoid Them
| Pitfall | Root Cause | Remedy |
| Using single-point estimates and calling them “the budget” | Organizational culture treats estimates as commitments rather than predictions | Train leadership that estimates are ranges. Present every budget with a confidence level (e.g., “This budget has a 50% chance of being sufficient”). |
| Treating contingency as a slush fund | No formal link between contingency and identified risks | Tie every dollar of contingency to a specific risk in the register. Release contingency only when the triggering risk materializes or expires. |
| Running Monte Carlo without validating input distributions | Analysts use default distributions (uniform or triangular) without calibrating to project-specific data | Conduct structured risk interviews with subject matter experts. Use historical data from analogous projects to calibrate optimistic, most likely, and pessimistic values. |
| Ignoring correlation between cost elements | The simulation treats all cost elements as independent, understating tail risk | Identify and model correlations. Labor and schedule are almost always correlated. Material costs from the same supply chain are correlated. Even partial correlation (0.3-0.5) significantly affects the tails. |
| Analyzing cost risk once and never updating | The cost risk analysis is done at project initiation and forgotten | Re-run the analysis at each major gate review. Update distributions as actuals replace estimates. Compare actual cost performance to the S-curve forecast. |
| Separating cost and schedule risk analysis | Two different teams run two separate models that do not communicate | Use an integrated cost-schedule model. Feed schedule risk results (duration uncertainty) into the cost model as time-dependent cost drivers. |
Looking Ahead: Cost Risk Analysis Trends 2025-2027
AI-powered cost estimation is advancing rapidly. Predictive models trained on historical project data can generate three-point estimates automatically, reducing the subjectivity in expert elicitation.
Organizations deploying AI in risk management identify and contain issues faster, per IBM’s 2024 research. Expect AI to supplement, not replace, Monte Carlo simulation by improving the quality of input distributions.
Integrated cost-schedule-risk models are becoming the standard in capital-intensive sectors. The GAO now expects joint cost and schedule confidence levels on major government programs.
This integrated approach will spread to private sector projects as boards demand probabilistic forecasts rather than deterministic budgets. Risk quantification for boards is emerging as a core competency that links cost risk analysis to enterprise-level decision-making.
Supply chain volatility, geopolitical trade disruptions, and inflation remain persistent cost risk drivers. Organizations that embed cost risk analysis into their financial risk assessment and enterprise risk management frameworks will make better capital allocation decisions, secure more accurate funding approvals, and avoid the multi-billion dollar overruns that continue to plague even the most sophisticated project portfolios.
