On a Tuesday morning in August 2023, a 135-foot section of an under-construction parking garage in New York City collapsed without warning, killing one worker and injuring five.
The NYC Department of Buildings traced the failure to deteriorated rebar, unrepaired cracks flagged in a 2003 engineer’s report, and no active monitoring of the structure for twenty years. That is construction risk management in its failure mode: a known hazard, a written recommendation, and no system to close the loop.
| What to remember about construction risk management |
| Construction risk management is no longer a paperwork exercise. The average North American construction dispute hit USD 60.1 million in 2025, up 47% in a single year, and a mature construction risk management program is now the cheapest insurance a builder can buy. |
| Safety risk still dominates the human cost. OSHA’s Focus Four (falls, struck-by, caught-in/between, electrocutions) accounted for roughly 59% of the 1,075 construction fatalities reported by the US Bureau of Labor Statistics in 2023, which means any construction risk management plan that does not start with Focus Four controls is starting in the wrong place. |
| Cost overruns are the rule, not the exception. Flyvbjerg’s data on 16,000 megaprojects shows nuclear power overruns average 117%, Olympic games 156%, and all-construction mean 28%, so construction risk management must quantify the fat tail with Monte Carlo, not paper over it with a contingency percentage. |
| Cyber has moved into the top three construction risks. Phishing volumes aimed at construction tripled from 2021 to 2025 and ransomware almost doubled, per the ReliaQuest and Rapid7 2025 construction threat reports, which forces construction risk management to include OT, BIM, and payments security in the risk register. |
| Standards beat improvisation. A defensible construction risk management program maps cleanly to ISO 31000:2018, ISO 21500, PMI PMBOK 7, ISO 45001 for occupational health, and ISO 22301 for continuity, and uses that mapping as the spine of every board report. |
| Contractual and insurance controls carry as much weight as site controls. A construction risk management strategy that allocates risk to the party best able to manage it, through clear scope, indemnities, LDs, wrap-up insurance, and change-order discipline, prevents most disputes before they start. |
Construction risk management is the discipline that keeps that loop closed. It is the set of processes a client, main contractor, and subcontractors use to identify, quantify, treat, and monitor every risk that can delay a project, blow the budget, hurt a worker, or end in litigation.
US Bureau of Labor Statistics fatality data shows 1,075 construction fatalities in 2023, the highest sector total in any private industry. Arcadis’ 2025 Global Construction Disputes Report puts the average North American dispute at USD 60.1 million, a record.
The numbers force the question: if your construction risk management program had to pass an external audit next quarter, would it?
This guide lays out a construction risk management playbook you can actually run, grounded in ISO 31000:2018, the PMI PMBOK Guide 7th Edition, and the lessons from a decade of incidents, disputes, and overruns.
We cover the landscape, the lifecycle, the frameworks, cost and schedule quantification, contractual allocation, safety, cyber, and what is coming next. For a primer on how this connects to the wider enterprise risk picture, see our overview of the enterprise risk management framework.
The Numbers Every Construction Risk Management Leader Should Know
Construction risk management starts with honest data. Three datasets matter most: fatalities, disputes, and overruns.
Each tells a different part of the same story, which is that construction remains the most hazardous and dispute-prone large industry in the developed world.
Fatalities. The OSHA Construction Focus Four (falls, struck-by, caught-in/between, and electrocutions) explain roughly 59% of the 1,075 construction fatalities reported in the BLS 2023 Census.
Falls alone caused 395 deaths, which is 36.5% of the sector total. A construction risk management program that does not open with Focus Four controls is skipping the fire and rearranging the furniture.
Our construction safety risk management guide walks through the controls in detail.

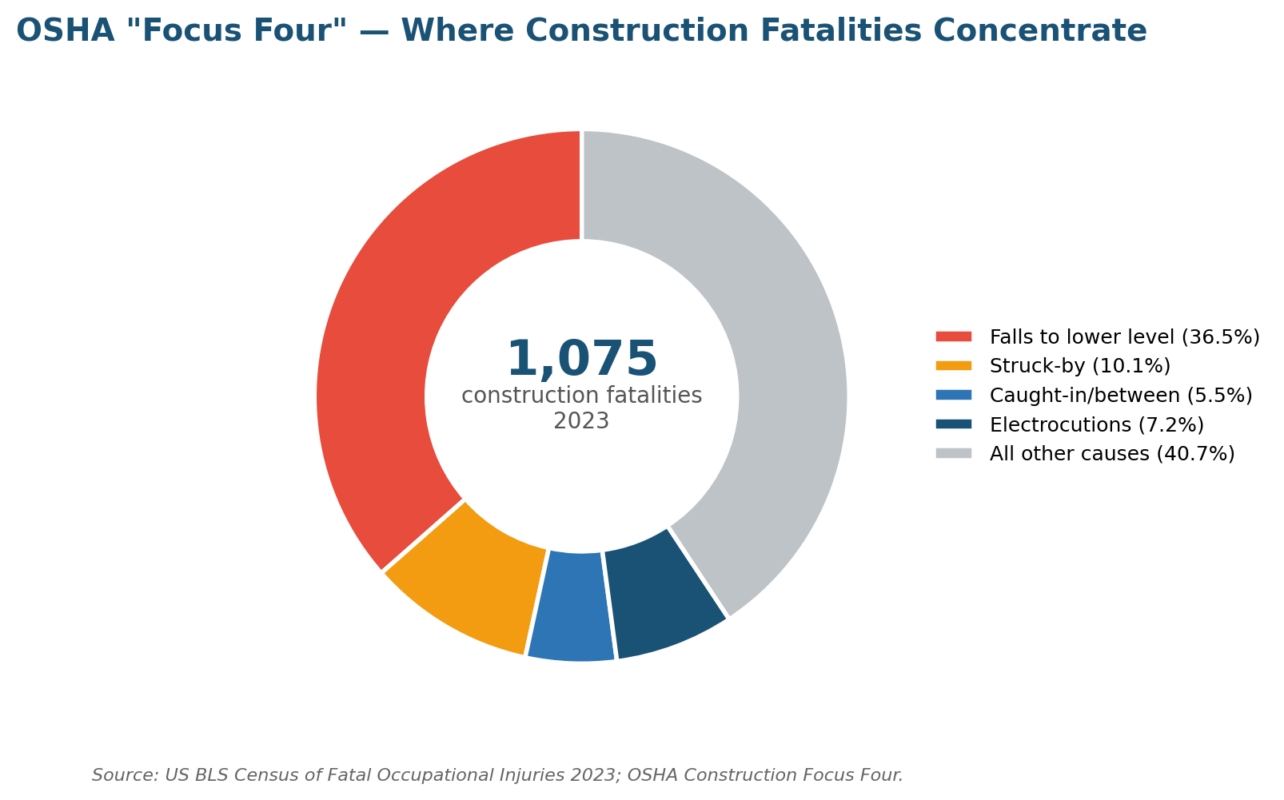

Figure 1. The OSHA Focus Four explains nearly six in ten construction fatalities — the starting point for any construction risk management program. Source: BLS CFOI 2023; OSHA.
Disputes. Arcadis tracks global construction disputes each year. North American average dispute value climbed from USD 33.8 million in 2018 to USD 60.1 million in 2025, a 78% increase over the cycle and a 47% jump in the last reporting period.
Poorly drafted contracts, change-order disputes, and late design changes are the top three root causes.
A construction risk management approach that treats contract drafting as a legal task, not a risk task, will keep feeding this statistic.
The project risk management plan should lock scope, change-order mechanics, and dispute resolution before ground is broken.

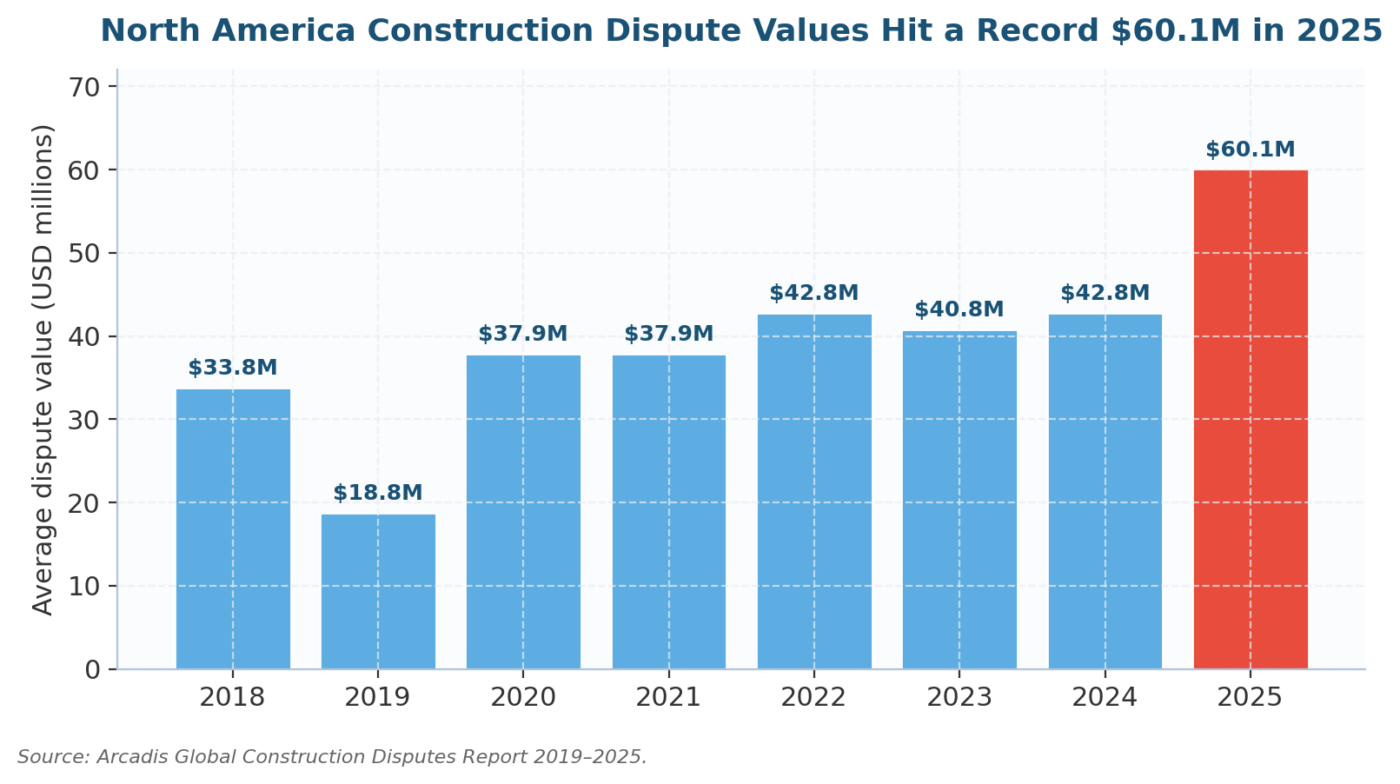

Figure 2. Average North American construction dispute value hit a record USD 60.1M in 2025, up 47% year-on-year. Source: Arcadis Global Construction Disputes Report 2019–2025.
Overruns. Bent Flyvbjerg’s research on 16,000 megaprojects, summarized in How Big Things Get Done (Harvard Business Review 2023), finds that 91.5% of megaprojects overrun cost, schedule, or both. Averages: nuclear power +117%, Olympic games +156%, rail +44.7%, all construction +28%.
The distribution has a fat right tail, which is the technical reason construction risk management cannot rely on a flat 10% contingency. It needs Monte Carlo simulation, reference-class forecasting, and scenario analysis, as explained in our risk assessment matrix guide.

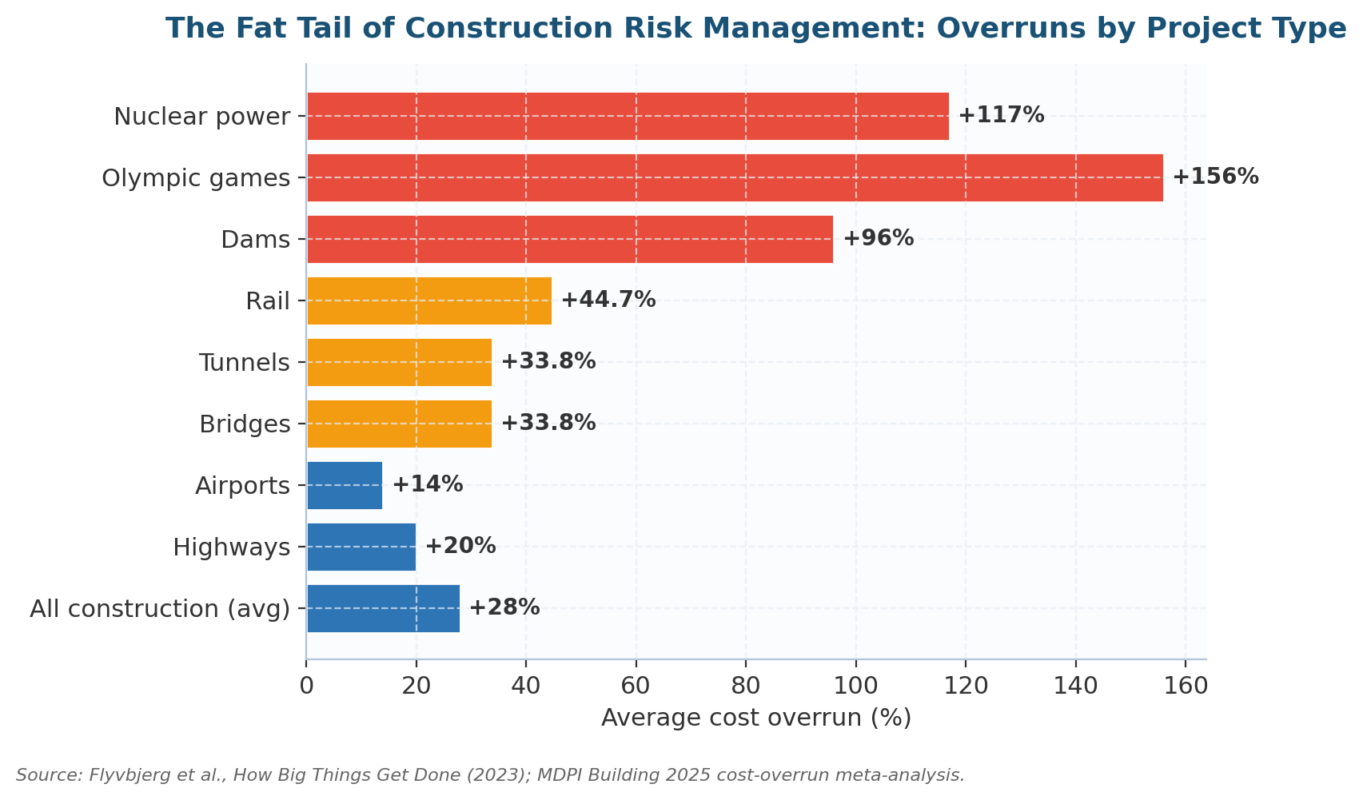

Figure 3. Construction risk management overruns by project type show a heavy right tail — nuclear, Olympic, and dam projects systemically blow through budgets. Source: Flyvbjerg et al. 2023; MDPI Building 2025 meta-analysis.
The Construction Risk Management Lifecycle: ISO 31000 Meets PMBOK
Construction risk management is not a checklist, it is a continuous loop. ISO 31000:2018 clauses 6.3 through 6.6 describe the loop in six connected activities: identify, analyze, evaluate, treat, monitor, and review.
PMI’s PMBOK Guide 7th Edition adds quantitative analysis techniques and an explicit integration with schedule and cost baselines. Used together, the two standards give construction risk management a spine that survives audit, litigation, and insurer scrutiny.

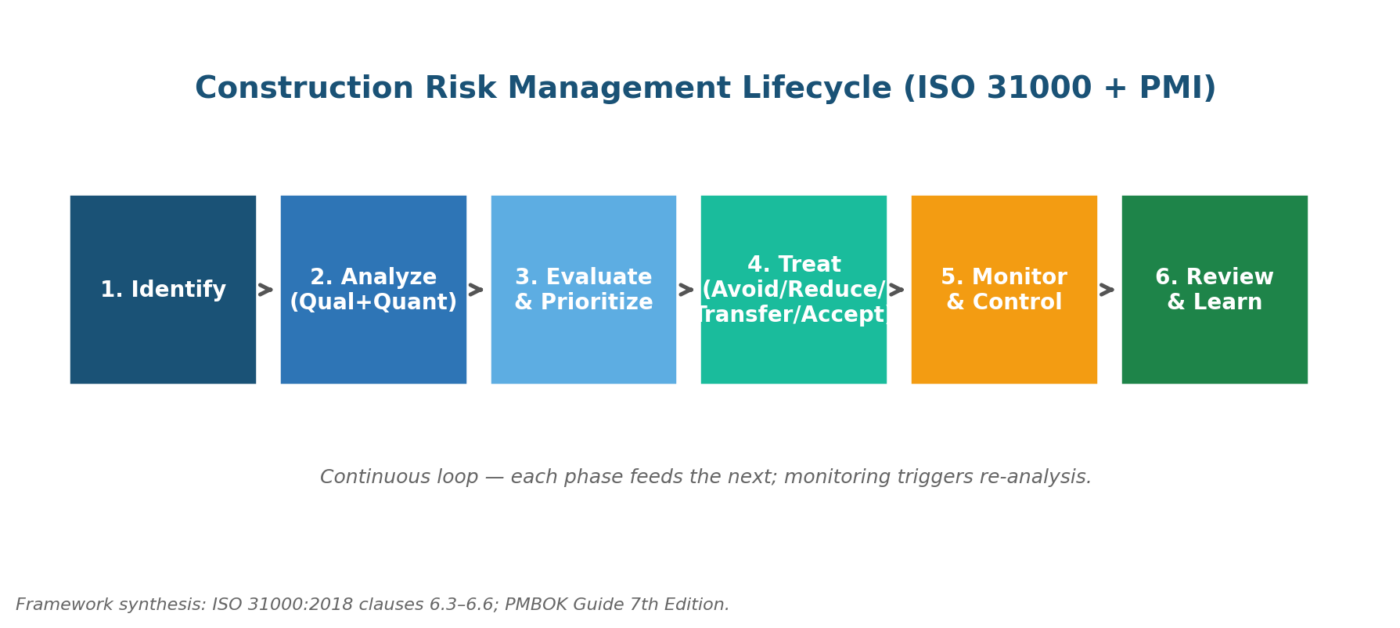

Figure 4. The construction risk management lifecycle, synthesized from ISO 31000:2018 and PMBOK 7. Every phase feeds the next — monitoring triggers re-analysis, not a filing cabinet.
Construction Risk Management Phase 1: Identification
Identification is structured, not intuitive. Run a combination of workshops with the design team, checklists anchored on historical construction risk registers, SWIFT (structured what-if technique), HAZID for complex MEP or civil interfaces, and expert interviews with the trade superintendents.
The output is a project risk register keyed to a WBS element, an owner, and a category (safety, schedule, cost, contractual, environmental, stakeholder, cyber). The risk register template gives a starting structure.
Aim for 80 to 150 risks on a mid-sized commercial build, 300+ on an infrastructure megaproject.
Construction Risk Management Phase 2: Qualitative and Quantitative Analysis
Qualitative scoring puts every risk on a likelihood by impact heat map, which is useful for triage but dangerous as a final answer.
Quantitative construction risk management sits underneath: Monte Carlo schedule simulation (e.g. Primavera Risk Analysis or Safran Risk), Monte Carlo cost simulation on WBS line items, and tornado charts that rank the top drivers of P80 cost and P80 finish.
McKinsey’s construction productivity research shows that the top 20% of risks drive 80% of cost growth, so Monte Carlo is how a construction risk management team finds that 20%.
Construction Risk Management Phase 3: Evaluation and Prioritization
Evaluation compares each risk against the program’s risk appetite (set by the client or sponsor) and tolerances (set at project level).
The output is a ranked treatment queue. Risks above tolerance must have a treatment plan, an owner, and a budget before the next stage gate.
For governance, pair the ranked list with a key risk indicators dashboard that tracks leading signals rather than just the realized loss.
Construction Risk Management Phase 4: Treatment (Avoid, Reduce, Transfer, Accept)
The four treatment options are cumulative, not alternatives. Avoid by design change, re-sequencing, or scope descoping. Reduce through engineered controls, training, and procedure.
Transfer via insurance, indemnities, bonds, and subcontract flow-downs, keeping in mind IRMI’s guidance on wrap-up construction insurance. Accept explicitly and with a monitored reserve, never by default. Our risk mitigation strategies primer goes deeper on the decision logic.
Construction Risk Management Phase 5 and 6: Monitor, Control, Review
Monitoring is the phase most programs fail. Set a cadence: weekly site safety KRIs, biweekly schedule risk updates, monthly cost risk re-simulation, quarterly deep-dive with the steering committee.
Every stage gate (design, procurement, mobilization, closeout) triggers a full re-analysis, not just a status update. Review captures lessons and feeds them into the next project’s identification phase, which is how a portfolio learns. See our risk monitoring guide for the operating rhythm.
Standards That Anchor Construction Risk Management
A construction risk management program that cannot map itself to recognized standards is unauditable, uninsurable in any serious sense, and indefensible in court. Five standards do the heavy lifting in 2026.
| Standard | What it does for construction risk management |
| ISO 31000:2018 | General risk management principles and process. The spine for every construction risk management framework. |
| ISO 21500 / 21502 | Project, programme and portfolio management guidance. Specifies how construction risk management integrates with project governance. |
| PMI PMBOK Guide 7th Ed. | Performance domains and tailoring guidance; detailed quantitative risk techniques (Monte Carlo, EMV, decision trees). |
| ISO 45001:2018 | Occupational health and safety management systems. Mandatory lens for any construction risk management safety module. |
| ISO 22301:2019 | Business continuity. Applies to critical-path subcontractors, material suppliers, and post-incident site resilience. |
| ISO 19650 (BIM) | Information management using BIM. The data backbone for digital construction risk management. |
| NIST CSF 2.0 / SP 800-82 | Cybersecurity framework and OT/ICS guidance. The cyber anchor of a modern construction risk management program. |
Cost and Schedule Quantification in Construction Risk Management
The single biggest quality gap in construction risk management practice is treating contingency as a guess rather than a calculation.
A 2025 MDPI Buildings meta-analysis of 114 cost-overrun studies finds that projects using probabilistic risk quantification had overruns 11 to 18 percentage points lower than those using deterministic contingency. That is the business case for Monte Carlo in one sentence.
Construction Risk Management Monte Carlo in Practice
Build a cost model at WBS level, assign a three-point estimate (P10, P50, P90) to every material line item with meaningful exposure (usually the top 40 to 60 items), correlate inputs that move together (steel and rebar, for instance), run 10,000 iterations, and read the P50, P80, and P95 outputs.
Do the same for the schedule with activity durations. The P80 is typically what goes to the client; the spread between P50 and P95 is what informs contingency. Practitioners who want a worked example should read our piece on quantitative risk analysis techniques.
Construction Risk Management Reference-Class Forecasting
Flyvbjerg’s reference-class forecasting corrects for optimism bias by anchoring forecasts to the actual outcome distribution of similar past projects, not the project team’s estimates.
For UK HS2, ignoring reference-class evidence produced published budgets that proved 180% low. A disciplined construction risk management team uses both bottom-up Monte Carlo and top-down reference-class forecasting, then reconciles the two.
Contractual and Insurance Controls in Construction Risk Management
About 70% of disputes trace back to three contract mechanics: ambiguous scope, poorly defined change-order procedures, and inadequate notice provisions.
A construction risk management program that ignores the contract ignores its largest single risk driver. Work with legal, but own the risk allocation conversation.
The AIA contract documents and FIDIC forms give templates; the contract risk management guide covers the negotiation playbook.
| Risk category | Primary bearer in construction risk management | Notes |
| Design errors | Designer (A/E) via professional indemnity | Client retains if owner-driven design changes |
| Unforeseen ground conditions | Typically client (site investigation) or shared via GBR | Shift to contractor only where investigation is adequate |
| Weather delays (normal) | Contractor via programme float | Exceptional weather via force majeure clause |
| Material price escalation | Shared via indexation or price-adjustment clause | Fixed-price only for short-duration work |
| Subcontractor default | Main contractor via bonds and pre-qual | Transfer via SDI insurance for critical subs |
| Site safety events | Main contractor (statutory duty) plus OCIP/CCIP wrap-up | Owner retains regulatory exposure |
| Change-order disputes | Managed contractually via notice, pricing, and adjudication | Mitigate with early warning and joint risk register |
| Cyber incident on project systems | Shared between owner’s IT and contractor’s OT | Cyber policy with construction-project endorsement |
Safety as the Heart of Construction Risk Management
Safety is not a separate program that sits beside construction risk management. It is the most consequential risk category inside it.
OSHA’s most-cited construction standards for FY2024 were again fall protection, scaffolding, ladders, and hazard communication.
A construction risk management program that wants to move the fatality curve needs four things: a job hazard analysis (JHA) discipline that actually gets done before every non-routine task, a site observation program with leading indicators, a stop-work culture backed by executive policy, and a learning loop from near-miss data.
Leading indicators beat lagging ones. Track observed unsafe behaviors per 10,000 work-hours, percent of JHAs completed within SLA, percent of corrective actions closed within 72 hours, and percent of workers with current safety training.
Feed these into the project’s risk dashboard and to the CEO. Our detailed walkthrough of construction risk assessment shows how to integrate safety KRIs with cost and schedule KRIs in one view.
Cyber Risk Is Now Core to Construction Risk Management
Construction ranked as the third most-targeted industry for ransomware in 2024, according to ReliaQuest’s 2025 Construction Threat Report, and phishing campaigns aimed at contractors more than tripled from 2021 to 2025 per Rapid7’s construction sector threat landscape analysis.
The attack surface has three new faces: BIM and common data environments, connected OT on site (cranes, telematics, HVAC), and payments-fraud via BEC against the GC’s accounts payable. Any construction risk management framework written before 2023 almost certainly underweights them.

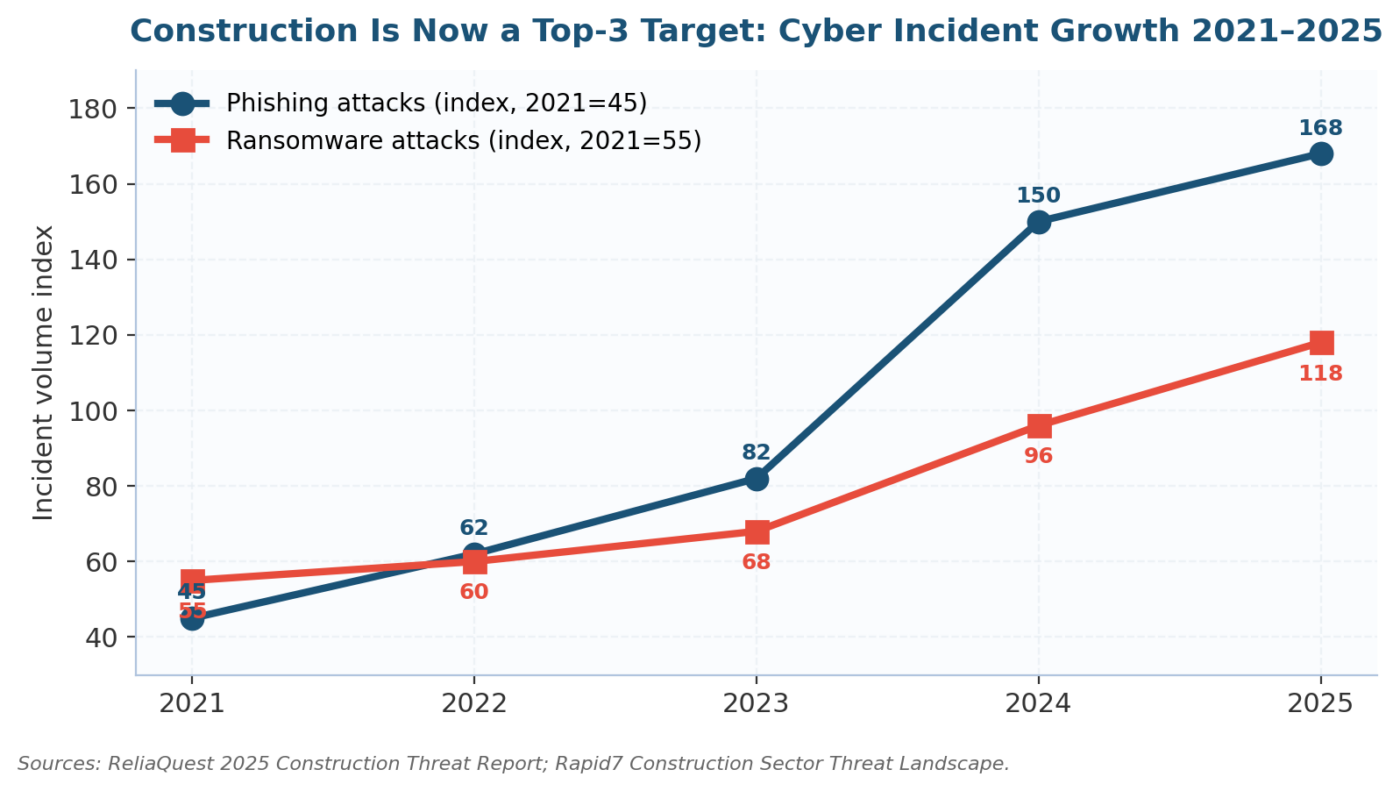

Figure 5. Construction risk management now has to cover cyber: phishing and ransomware incidents targeting the sector have tracked steeply upward since 2021. Sources: ReliaQuest 2025; Rapid7 2025.
The minimum bar: MFA across the project collaboration stack, segmented OT networks per NIST SP 800-82 Rev. 3, BEC controls on the accounts payable workflow, and a tabletop exercise with the main contractor, the owner’s IT, and the top three subcontractors at least annually. Pair it with the wider cyber risk management playbook.
Building a Construction Risk Management Operating Model That Works
A construction risk management capability needs clear roles (three lines of defense), documented procedures, a live risk register tied to project controls, and a governance rhythm that the executive team actually respects.
The IIA’s Three Lines Model translates directly to construction.
| Role | Construction risk management accountability |
| 1st line — Project team | Own risk identification, treatment, and day-to-day controls. Update register weekly. Run JHAs and stage-gate reviews. |
| 2nd line — Risk & safety function | Set methodology, standards, and KRI thresholds. Challenge project risk positions. Aggregate portfolio view to the executive. |
| 3rd line — Internal audit / IV&V | Independent assurance on construction risk management controls, sample-tested against ISO 31000 and internal policy. |
| Client / sponsor | Sets risk appetite, signs off on treatment budgets, and owns the go/no-go at each stage gate. |
| Insurer / surety | Bondability review, OCIP structure, loss-control audits. A credible construction risk management program lowers premium and raises capacity. |
Construction Risk Management: Your Questions Answered
What is construction risk management in plain language?
Construction risk management is the ongoing process of finding, sizing, and acting on anything that could delay, over-cost, injure, or legally expose a construction project.
It covers the full lifecycle from feasibility through commissioning and typically runs through a risk register linked to the project’s WBS, with owners, treatments, and KRIs. A defensible program maps to ISO 31000:2018 and PMBOK 7.
What are the main types of risk in construction risk management?
The standard construction risk management taxonomy has seven buckets: safety (OSHA Focus Four plus occupational health), schedule, cost, contractual and claims, environmental and permitting, stakeholder and community, and cyber.
Megaproject programs often add geopolitical and currency risk. Each needs its own KRIs and a named owner on the project org chart.
Who is responsible for construction risk management on a project?
Ownership is shared. The client owns risk appetite and sponsor-level decisions. The main contractor owns site-level execution risk.
Designers own design risk via professional indemnity. Subcontractors own the trade-specific risks flowed down to them. A mature construction risk management program makes these accountabilities explicit in the contract and the RACI, not assumed.
What tools and software do construction risk management teams use in 2026?
Typical stacks pair a project-controls platform (Primavera P6, Safran Project, Deltek Acumen) with a Monte Carlo engine (@Risk, Safran Risk, Primavera Risk Analysis), a BIM-centered common data environment (Autodesk Construction Cloud, Bentley ProjectWise), and a GRC or IRM layer for enterprise aggregation (Archer, LogicGate, Onspring). For a wider vendor view, see our piece on enterprise risk management technology.
How is construction risk management different from general project risk management?
Construction risk management is project risk management plus specific regulatory, safety, and physical-asset concerns that other sectors do not face at the same intensity.
Falls from height, OSHA recordables, ground conditions, weather, and wrap-up insurance structures are native to construction. The process framework is similar to ISO 31000, but the content of the register and the controls are industry-specific.
How much contingency should a construction risk management plan carry?
The honest answer is it depends on the risk profile. A disciplined construction risk management team runs a Monte Carlo simulation and sets contingency at the P80 minus the baseline estimate.
On low-complexity commercial work that might be 6 to 10%. On megaprojects, the P80 can sit 40% above the point estimate. Avoid the lazy flat 10% contingency.
What ISO standards apply to construction risk management?
ISO 31000:2018 is the anchor. ISO 21500 and 21502 cover project and programme governance. ISO 45001 is the safety management system. ISO 22301 addresses continuity. ISO 19650 handles BIM information management.
Where cyber is in scope, add NIST CSF 2.0 and NIST SP 800-82 for OT. A construction risk management audit typically samples against all six.
What are the early warning signs that a construction risk management program is failing?
Five red flags: the risk register has not changed in two months, the same top risks repeat every quarter without treatment progress, KRIs are lagging indicators only, change orders spike without a matching risk-register entry, and stage-gate decisions happen without a refreshed Monte Carlo. If three of the five are true, the program is theater.
Where Construction Risk Management Programs Go Wrong — And How to Fix Them
| Pitfall | Root cause | Remedy |
| Treating the risk register as a compliance artifact | Program was stood up for an audit or a tender, not for management. | Make the register a living weekly tool; link every entry to a WBS element, owner, and KRI. |
| Flat 10% contingency | Team cannot or will not quantify the exposure. | Run WBS-level Monte Carlo; set contingency at P80-baseline; refresh each stage gate. |
| Safety separated from construction risk management | Organizational silo between EHS and project controls. | Integrate safety KRIs in the same dashboard as cost/schedule; one governance forum. |
| Ignoring contract risk | Risk team assumes legal owns contract language. | Red-team every contract for scope, notice, change-order, indemnity, and LD language before signature. |
| Vendor and subcontractor blind spots | No pre-qual, no ongoing monitoring of critical subs. | Tier critical subs; require financial, safety, and cyber monitoring; use SDI where loss would be catastrophic. |
| Monte Carlo as a one-off | Simulation run at sanction, never refreshed. | Re-simulate cost and schedule at every stage gate and whenever a top-10 risk moves. |
| No cyber module | Construction risk management framework predates 2023 cyber escalation. | Add BIM/CDE, OT, and BEC to the register; tabletop with main contractor, owner IT, top subs. |
| No lessons-learned loop | Closeout focuses on punch list, not knowledge capture. | Mandatory lessons-learned workshop at completion; feed outputs into next project’s identification phase. |
Where Construction Risk Management Is Heading: 2026–2028
Three shifts will rewrite the construction risk management playbook over the next two years. Anticipating them now is cheaper than retrofitting later.
First, climate-driven risk is going from tail to trunk. The World Economic Forum’s Global Risks Report 2025 ranks extreme weather the number-one two-year risk globally.
For construction risk management that means physical climate modeling on every site selection, scenario-based schedule buffers for heat and storm days, and supplier continuity planning for cement, steel, and electrical components under climate stress.
Second, AI and digital twins will reshape quantification. AI-augmented risk identification (trained on your own prior project data plus public incident databases) is already pulling 20 to 30% more risks into the register in early adopters.
Digital twins tied to IoT sensors give real-time schedule and safety KRIs instead of weekly reports. The catch: AI-generated risks need the same governance as any other input. Map them to the NIST AI Risk Management Framework before they end up in a decision log.
Third, regulatory convergence is tightening the compliance floor. OSHA’s heat-injury rule, EPA’s expanded stormwater enforcement, state-level PFAS restrictions in the US, and the EU’s CSRD and CS3D obligations for construction supply chains all land inside the 2026–2027 window.
Construction risk management programs that can show mapped evidence across standards and regulations will keep bondability and insurance capacity.
Those that cannot will pay for it in premium, or lose work to those that can. See our note on the emerging regulatory risk management landscape.
