Fundamentals of Construction Risk Management

Photo of author
Written By Chris Ekai

Construction risk management is the discipline of identifying, assessing, responding to, and monitoring threats to a project’s cost, schedule, safety, and quality. Its fundamentals are five risk categories, a four-step process, quantified assessment, single-owner accountability, and scheduled review. Done well, it turns uncertainty into a priced contingency that estimators, superintendents, and owners can all see and defend.

On 28 March 2025, the 30-storey State Audit Office tower under construction in Bangkok collapsed in 15 seconds when a magnitude 7.7 earthquake struck Myanmar, more than 1,000 kilometers away. It was the only building in the city to fall. Rescue crews recovered 92 bodies over six weeks; four workers were never found.

Investigators found the failure started in the shear walls around the lift shafts and stairwells, elements that were designed and built below code. By August 2025, Thai prosecutors had charged Italian-Thai Development president Premchai Karnasuta and 14 others with negligence, substandard materials, and forged engineering signatures.

Every fundamental of the discipline failed on that 2.136-billion-baht project: design review, material verification, contractor due diligence, and independent inspection. That is the argument for treating construction risk management as a daily working discipline. The fundamentals below are where that discipline starts, and each one had a chance to stop the Bangkok failure early.

What Construction Risk Management Covers

Construction risk management covers four questions. What can hurt this project, how badly, what will we do about it, and who is watching for the change. The ISO 31000 risk management standard frames these as identification, analysis, treatment, and monitoring within a governed process.

The discipline spans the full project lifecycle, from feasibility through closeout and warranty. A pre-construction risk assessment catches siting, permitting, and design risks while they are still cheap to fix. Site-phase controls then manage execution risk, and closeout controls manage claims, defects, and handover exposure.

It also spans every party. Owners carry financing and approval risk, designers carry professional liability, and contractors carry means-and-methods risk. Our guide to understanding construction risk management maps these allocations in detail; the fundamental point is that every risk needs exactly one accountable owner.

Process step Core question Primary output
Identify What can credibly go wrong on this project? Risk register with named owners
Assess How likely is each risk, and what would it cost? Scored register, ranked by exposure
Respond Avoid, transfer, mitigate, or accept? Response plan with priced contingency
Monitor What changed since we last looked? Updated register and trigger reports

Why Projects Fail Without a Risk Discipline

The cost of skipping the discipline is measurable. The Arcadis 2025 Global Construction Disputes Report puts the average US construction dispute at $60.1 million, up from $43.0 million two report cycles earlier, with resolution averaging 12.5 months. The most common cause is parties failing to understand their contractual obligations.

Fundamentals of Construction Risk Management

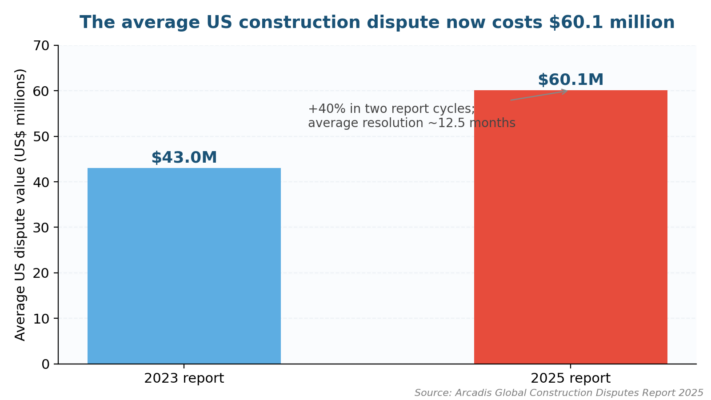

Figure 1. The average US construction dispute reached $60.1 million in the Arcadis 2025 report, a 40% jump in two cycles.

Dispute causes are stubbornly consistent. Arcadis analysts writing for CMAA name contractual ambiguity, project management failure, and unforeseen site conditions as the leading triggers. All three are identifiable in advance, which is precisely what a risk register exists to force.

Cost performance tells the same story at scale. Bent Flyvbjerg’s dataset of infrastructure megaprojects found a mean cost overrun of 62% with a fat tail of catastrophic outcomes. A 2025 review of 69 overrun studies traces the causes to the same planning and scope failures the register is built to expose.

Insolvency is the end state of unmanaged risk. UK construction logged 3,931 insolvencies in 2025, leading every sector for the fourth consecutive year. Law firm Pinsent Masons attributes the pattern to fixed-price contracts, late payment, and debt, all foreseeable exposures.

The Five Risk Categories Every Contractor Tracks

Categories keep a register honest by forcing coverage. A register with forty safety entries and no financial entries has a blind spot exactly where disputes get expensive. We group construction exposure into five families, aligned with the five essential risk management steps that structure the wider process.

Category Typical exposures Front-line controls
Safety Falls, struck-by, caught-between, electrocution, trench collapse Fall protection, permits to work, toolbox talks, stop-work authority
Schedule Weather, late design, permit delay, sequencing clashes Float mapping, lookahead planning, schedule risk analysis
Financial Material escalation, payment default, cash-flow gaps, FX Escalation clauses, payment bonds, cash-flow forecasting
Contractual Ambiguous scope, unpriced changes, claims, liquidated damages Contract review, change control, notice discipline, records
Environmental Storms, flooding, ground conditions, runoff violations Site investigation, weather triggers, stormwater controls

Safety takes first position on the evidence. The BLS Census of Fatal Occupational Injuries recorded 1,034 construction deaths in 2024, and the sector accounted for 48.8% of all fatal falls across US private industry. A safety risk management program therefore anchors the register from page one.

Fundamentals of Construction Risk Management

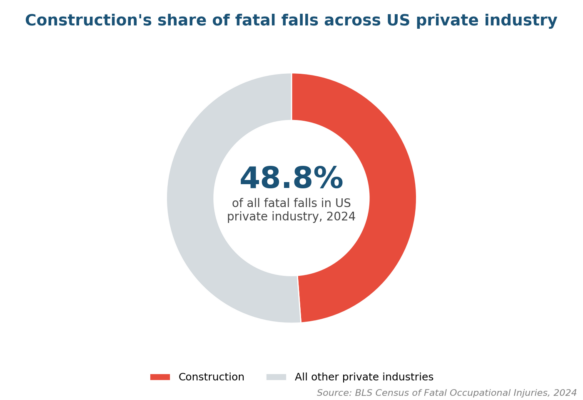

Figure 2. Construction produced 48.8% of all fatal falls in US private industry in 2024 (BLS CFOI).

Falls remain the pattern to break, which is why OSHA’s Stop Falls campaign targets them directly. Fatal falls, slips, and trips among construction and extraction workers did drop 7.5% to 370 in 2024. Progress is real; the base rate is still unacceptable.

One caveat keeps the model honest: risk is not only downside. A positive risk such as early material procurement before a tariff deadline can add margin if someone is assigned to capture it. Registers that track opportunities alongside threats also get read far more often.

How the Construction Risk Management Process Works

The construction risk management process runs identify, assess, respond, monitor, in a loop that repeats at a fixed cadence. It is the same spine as generic project risk management, tuned for site conditions, subcontractor layers, and the brutal schedule coupling of construction work.

Identification works best as a structured hunt, because open brainstorming workshops surface the memorable risks and quietly miss the expensive ones. Pull from five sources, de-duplicate into the register, and hand the result to the risk assessment process for scoring. The sources that consistently earn their place:

  • Closeout reviews and claims files from your last five comparable projects.
  • The contract itself, clause by clause, hunting ambiguity and unpriced obligations.
  • Site investigation reports, utility surveys, and geotechnical data.
  • Trade-by-trade interviews with the superintendents who will build the work.
  • External data: weather records, supplier financials, and permit authority backlogs.

Assessment ranks what identification finds. Score each entry for likelihood and impact, then rank by exposure so the top ten get management attention weekly. Our definition of risk assessment in construction walks the scoring mechanics; the fundamental is that the ranking sets the weekly meeting agenda.

Response and monitoring close the loop. Every red-zone risk gets a response, an owner, and a trigger metric, then the register is re-scored monthly and at every phase gate. A key risk indicator such as RFI aging or unapproved change orders gives early warning between reviews.

Qualitative and Quantitative Assessment in Practice

Qualitative assessment sorts risks fast using judgment scales; quantitative assessment prices the ones that matter. Neither replaces the other. A 5×5 matrix from the risk assessment pillar handles the first pass, and quantitative risk management tools then model the survivors in dollars and days.

Dimension Qualitative pass Quantitative pass
Input Expert judgment on likelihood and impact scales Cost data, productivity records, price indexes
Output Ranked register, red-amber-green Expected monetary value, P50/P80 contingency
Best for Screening the full register quickly Top exposures and bid-level contingency
Trap Scores drift optimistic without anchors False precision from thin data

A worked example makes the quantitative pass concrete. Suppose steel delivery delay carries a 30% probability and a $400,000 schedule impact: expected monetary value is $120,000. Price that into contingency alongside the other top risks, and the reserve becomes a defensible number instead of a habitual 10%.

Schedule risk deserves the same numeric treatment, because a Monte Carlo run on the programme exposes which activities actually drive completion dates. Dedicated schedule risk analysis software does this against the live programme, and energy and infrastructure owners already require it on major project risk assessments.

Choosing a Risk Response: Avoid, Transfer, Mitigate, Accept

Four responses cover every risk on the register, and picking one deliberately is the whole game. The wrong pattern is accepting by default, which is what happens to every risk nobody prices. Our risk management techniques guide covers the decision logic; the table shows the construction application.

Response When it fits Construction example
Avoid Exposure exceeds any available reward Decline the fixed-price bid on incomplete drawings
Transfer A counterparty prices the risk better Builder’s risk insurance; subcontractor flow-down clauses
Mitigate Controls cut likelihood or impact economically Winter concrete procedures; early steel procurement
Accept Residual exposure is small and priced Minor weather days inside the schedule float

Transfer needs one warning: moving a risk on paper does not move the consequence. The Bangkok tower’s owner had contracts with a joint venture; the collapse still killed 96 people and halted the project. Transferred risks stay on the register with a verification control attached.

Mitigation is where risk mitigation in project management earns its budget, and the test is arithmetic: control cost below expected loss reduction. A $30,000 dewatering plan against a $120,000 expected flood loss clears the bar. Guards on a hazard the assess-and-mitigate cycle already designed out do not.

Building the Plan and Pricing the Contingency

The risk management plan turns the register into commitments: who owns each risk, what the response costs, and when reviews happen. The structure in our project risk management plan guide adapts directly to site work. Keep it under fifteen pages, or nobody on the project will open it twice.

Length is a design decision, and short wins because a plan competes with drawings, submittals, and daily fires for the team’s attention. A construction risk plan that survives contact with the site carries exactly five sections, each one answerable in a progress meeting:

  • The scored register, cut to the top twenty exposures with named owners.
  • Response plans and trigger metrics for every red-zone risk.
  • Contingency: a priced reserve tied to expected values, plus drawdown rules.
  • Escalation criteria: which movements reach the project executive within 24 hours.
  • The review calendar: monthly re-scoring, phase-gate reviews, and post-incident updates.

Price the contingency against current conditions, never last year’s. AGC’s January 2026 analysis shows aluminum mill shapes up 30.5% and steel mill products up 17% year over year, and chief economist Ken Simonson expects further increases while tariffs hold. Escalation clauses and early procurement belong in the response column.

Fundamentals of Construction Risk Management

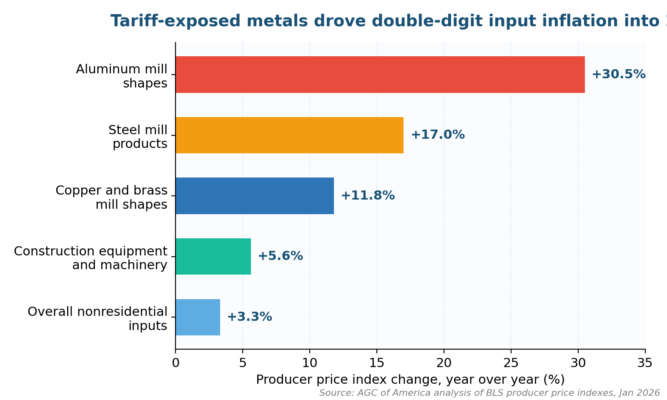

Figure 3. Tariff-exposed metals drove double-digit input inflation into 2026 (AGC analysis of BLS data).

The pressure is not easing. Nonresidential input prices rose at a 12.6% annualized rate in early 2026, the fastest pace since the 2022 supply shocks, and the materials PPI sits at a record 354.9. A contingency set from 2024 unit rates is a plan to lose money.

Technology, Documents, and the Data Problem

Most construction claims are won or lost on records, which makes document discipline one of the cheapest risk controls a contractor owns. Daily logs, photographs, notices, and change orders form the evidence chain. Software-heavy delivery models add their own exposures, which belong on the register like any subcontractor.

Tool class Risk it attacks Register entry it retires
Common data environment Version confusion, information silos Building from superseded drawings
Field capture apps Missing daily records Unsupported delay and disruption claims
Schedule risk software Optimistic single-point dates Unquantified completion risk
Sensor and drone monitoring Unseen site conditions Late discovery of settlement or water

Integration matters more than tool count, because fragmented systems recreate the silos they were bought to remove. An integrated risk management approach links field data to the register so triggers fire from live numbers. The same feed serves the business impact analysis when operations depend on the completed asset.

Where Programs Stall and How to Unstick Them

Risk programs rarely die loudly; they quietly stop being used. The pattern is visible in risk management examples across sectors, and in construction it has recognizable signatures. The table names the frequent failures and the fixes that have worked on real programs.

Pitfall Root cause Remedy
Register written once, never reopened Risk treated as a bid-stage deliverable Standing agenda slot; re-score monthly
Every risk scored medium No anchored scales, optimism bias Define scales in dollars and days; calibrate
Risks without owners Committee accountability One name per risk; owner reports, or the risk escalates
Contingency spent as budget No drawdown rules Release only against register entries, signed
Subcontractor risk invisible Flow-down assumed, never verified Prequalification plus insurance verification

The hardest current constraint is people, and it cannot be mitigated with software. Associated Builders and Contractors’ model says the industry must attract 349,000 new workers in 2026, rising to 456,000 in 2027. ABC chief economist Anirban Basu warns that shortfalls will push labor costs higher.

Fundamentals of Construction Risk Management

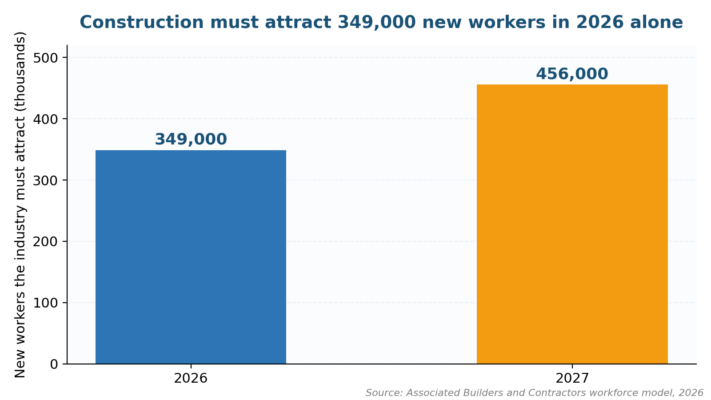

Figure 4. ABC’s workforce model: 349,000 new workers needed in 2026, 456,000 in 2027.

Treat workforce as a register entry with real responses: named-crew clauses in subcontracts, cross-training on critical trades, retention pay tied to milestones, and schedule logic that survives a thin crew. Programs that price labor risk into their bids are consistently outbidding programs that discover the same shortage mid-pour.

Common Construction Risk Management Questions Practitioners Ask

What are the fundamentals of construction risk management?

Five fundamentals: classify exposure across safety, schedule, financial, contractual, and environmental categories; run the identify-assess-respond-monitor loop; quantify top risks in dollars and days; assign one owner per risk; and review on a fixed cadence. Everything else in the discipline is an elaboration of those five.

What are the five main risk categories in construction risk management?

Safety, schedule, financial, contractual, and environmental. Safety leads because construction produced 48.8% of all fatal falls in US private industry in 2024. The categories exist to force balanced coverage, so a register heavy in one family and silent in another gets caught at review.

How does construction risk management differ from general project risk management?

The process spine is identical; the exposure profile is not. Construction adds fatality-level safety risk, deep subcontractor layering, weather coupling, and material price volatility that office-based projects rarely face. Registers, contingency models, and insurance structures are all heavier as a result, and site records carry far more evidential weight.

When should construction risk management start on a project?

At feasibility, before land or contract commitments. The decisions with the greatest influence, such as siting, procurement route, and contract form, happen before design freeze. A pre-construction risk assessment at that stage costs a workshop; the same finding discovered during excavation costs change orders, claims, and schedule.

What does a construction risk management plan contain?

Five sections: a scored register cut to the top twenty risks with named owners, response plans with trigger metrics, a priced contingency with drawdown rules, escalation criteria with timeframes, and a review calendar. Keep it under fifteen pages so the site team actually uses it.

How much contingency should construction risk management set aside?

Build it from the register. Sum the expected monetary values of the top risks, then set the reserve at the P70 to P80 confidence level for the project’s risk appetite. Flat percentages ignore project-specific exposure, which is exactly what contingency exists to cover.

Where Construction Risk Practice Is Heading

Three shifts will mark the next two years. Tariff-driven price volatility makes escalation modelling a bid-stage requirement, with AGC economists expecting continued increases while current trade policy holds. Contingency models that refresh quarterly against published indexes will separate disciplined bidders from hopeful ones.

Accountability is tightening. The Bangkok prosecutions show regulators willing to charge named executives, and the Arcadis dispute data shows owners litigating at $60.1 million a time. Registers, inspection records, and notice trails are becoming legal armour as much as management tools.

The workforce gap will decide who can even execute a response plan. With 349,000 hires needed in 2026, crews are a scarce resource to be risk-managed like steel or cash. Firms that treat people risk as a register entry with priced responses will keep their schedules; the rest will donate float to the labor market.

If your next project needs a register, a priced contingency, and a review rhythm that survives the first pour, our risk advisory services build them with your team. Contact us to scope it this week. Bring the drawings; we bring the discipline that keeps 30-storey problems on paper.
