Software project risk management identifies what could derail a build, scores each threat as probability times impact, responds to the priorities, and repeats the loop every sprint. The method stays small: a living register, exposure math that ranks worries in weeks, named owners, and one risk question inside each ceremony the team already runs.
In April 2026, the Department of Veterans Affairs resumed deploying its Oracle Health electronic health record after a three-year pause, starting with four Michigan facilities. The program had already obligated $13.84 billion through the second quarter of fiscal 2025.
A new lifecycle estimate shown to lawmakers in December 2025 put the total near $37 billion, and an independent 2022 analysis had projected roughly $50 billion. Sixteen of eighteen GAO recommendations remained unimplemented as deployments restarted toward about 170 sites by 2031.
| Software Project Risk Management: Key Takeaways |
| One repeating loop does the work: identify what threatens the delivery, score exposure as probability times impact, respond to the priorities, and re-check every sprint boundary. |
| The VA’s electronic health record program has obligated $13.84 billion through mid-2025 against a lifecycle estimate near $37 billion, after a three-year deployment pause that ended in April 2026. |
| Birmingham City Council’s Oracle build grew from a £19 million budget to a projected £216.5 million by April 2026, and the system went live despite documented red flags. |
| Boehm’s exposure formula ranks worries in comparable units: a 60% chance of losing 8 weeks outranks a 20% chance of losing 10, and the register orders itself. |
| Per the 2025 Stack Overflow survey, 84% of developers use or plan to use AI tools while 46% actively distrust their accuracy, which makes AI-generated code a register entry, not a footnote. |
| Sprint ceremonies already contain the review cadence: backlog refinement, planning, and retrospectives each carry one risk question, so no separate risk meeting is needed. |
Every failure mode in that story belongs on an ordinary project register: schedule slip, estimate growth, stakeholder fatigue, unresolved findings. The software project risk management method below scales down from $37 billion programs to six-month builds, because the arithmetic of managing project risk does not care about the budget.
What Software Project Risk Management Covers
Done properly, software project risk management applies the standard five-step loop to the specific ways a build fails: identify threats to scope, schedule, cost, and quality; analyze probability and impact; respond; monitor; repeat. ISO 31000 supplies the frame, and the software context supplies the failure modes.
Software project risk management differs from its cousins in tempo. An enterprise register turns quarterly, while a software project generates new risk weekly as requirements shift and dependencies update, so the cadence must live inside the delivery rhythm itself. That tempo argument shapes everything that follows, including where the risk management plan document ends and daily practice begins.
Scope the register to the project’s own promises. A build that commits to a fixed launch date carries schedule risk as its currency; a fixed-price contract converts everything into cost. Write the register in whichever unit the promise was made, a rule our worked software risk assessment applies line by line.
Two Programs, Fifty Billion Dollars of Warning

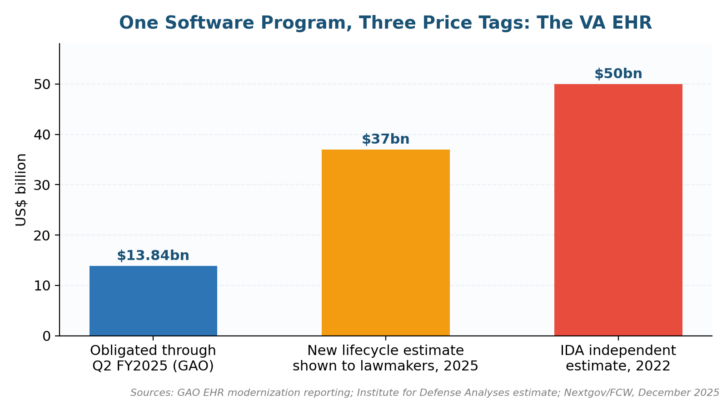

The VA program shows what compounding assumptions cost at federal scale, and its trajectory is worth a hard look before writing your own register. Three price tags now describe one system, and the gap between them is unmanaged risk that crystallized.

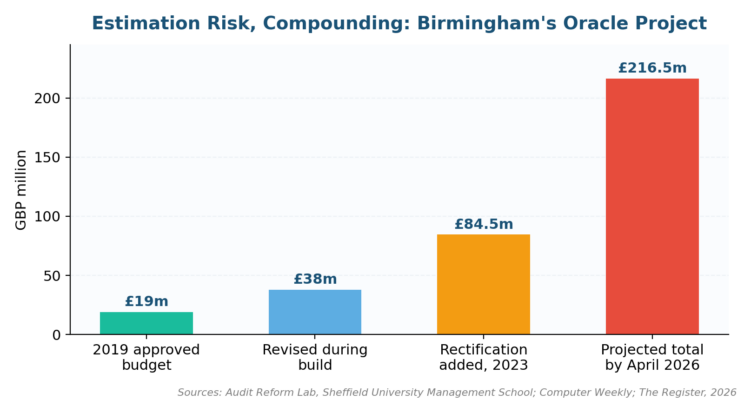

Figure 1. The distance between the bars is the price of assumptions nobody re-tested.
Birmingham City Council ran the same software project risk management failure at municipal scale. Its Oracle Fusion migration, budgeted at £19 million in 2019, slipped from a December 2020 launch to April 2022, went live anyway, and could not produce auditable accounts afterward.
The projected bill reached £216.5 million by April 2026, eleven times the approved budget, and £69 million of anticipated savings were written off. A February 2025 Grant Thornton review named poor project management and culture, and the go-live proceeded despite documented red flags. Both programs failed on governance long before they failed on technology.
The Six Risks That Sink Software Builds
Between them, the two programs cover most of the standard catalogue, from optimism-priced estimates to go-lives that outran their own evidence. Six categories account for nearly every loss we see in software project risk management registers, and each carries an early signal a team can watch for well before the damage arrives on the schedule.
| Risk type | Where it shows up | Early signal | First response |
| Estimation | Deadlines set before sizing; optimism baked into the plan | Velocity misses two sprints running | Re-estimate with actuals; reset the date |
| Scope | Features growing past the MVP line mid-build | Backlog grows faster than burn-down | Change control with priced trade-offs |
| Technical | New stack, fragile integration, accumulating debt | Defect rate climbs release over release | Spike stories; pay debt on a schedule |
| Vendor | One API, library, or supplier under a critical path | Deprecation notices; support slows | Second source; wrap with an abstraction |
| People | Knowledge concentrated in one engineer | Bus factor of one on any component | Pairing, documentation, staged handover |
| Security | Findings deferred to a hardening phase that shrinks | Unresolved criticals age past 30 days | Gate releases on the finding, not the date |

Figure 2. Estimation risk compounds quietly: each revision looked reasonable from where it was made.
Security deserves its own sentence in software project risk management because it behaves differently: it accrues silently and bills late. NIST’s Secure Software Development Framework and CISA’s Secure by Design push controls into the build itself, which is where information security risk stops being a phase and becomes a habit.
Put a Number on the Worry

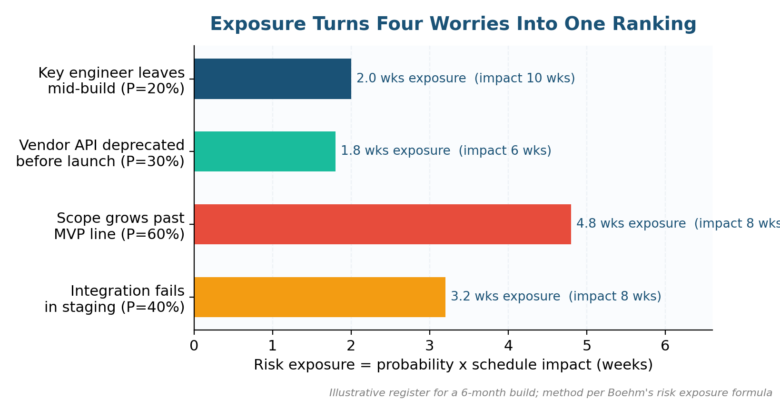

Categories organize the software project risk management register; exposure math ranks it. Boehm’s formula multiplies the probability of a risk by its schedule or cost impact, producing exposure in comparable units. A 60% chance of losing eight weeks scores 4.8; a 20% chance of losing ten scores 2.0, and the argument about which matters more is over.

Figure 3. Four worries, one ranking: exposure math ends priority debates a matrix cannot.
Calibrate the probabilities against history rather than mood. Past sprint data, defect trends, and vendor track records anchor the percentages, and IEC 31010 catalogues the estimation techniques when the stakes justify heavier tooling. Our assessment methodology guide shows the anchoring step in detail.
Re-score at every sprint boundary, because exposure decays and spikes with the build. The vendor risk that scored 1.8 in discovery may hit 4.0 the week its API posts a deprecation notice, and a register still showing January’s numbers in June is a decoration, whatever the template cost. Key risk indicators automate the watching.
Running the Loop Inside Sprint Ceremonies
None of this requires a new meeting, and adding one is usually how software project risk management dies. The ceremonies agile teams already run, born from the Agile Manifesto’s preference for working software and conversation, each absorb one risk question without adding a minute of ceremony overhead:
- Backlog refinement: which items carry assumptions nobody has tested yet?
- Sprint planning: what could make this sprint’s commitment fail, and who watches it?
- Daily stand-up: any blocker that repeats twice gets promoted to the register.
- Retrospective: which risk fired this sprint, and did the response we planned actually work?
- Release review: are unresolved security findings and debt items aging past their thresholds?
Iterative delivery is itself a treatment, a point the spiral model made formal decades before Scrum. Shipping an MVP early converts the largest unknown on most builds, whether anyone actually wants the product, into evidence bought for a fraction of the full build cost.
Elite delivery performance and software project risk management turn out to be the same behaviors. DORA’s research links small batches, fast feedback, and deployment automation to lower change-failure rates, which is risk reduction wearing engineering clothes. Track the four DORA metrics and you are already running half the indicator set a project needs.
Choosing a Response When a Risk Is Real
Scored and ranked, each priority risk gets one of the four standard software project risk management responses: avoid by cutting the feature or the dependency, reduce with engineering work, transfer through contracts and insurance, or accept with a named owner and a trigger that reopens the decision.
Software work skews the economics toward reduction, since a spike story or an abstraction layer is usually cheaper than the insurance equivalent. Transfer still matters at the edges: fixed-price vendor clauses, liability caps, and cyber cover belong in the technique inventory for exposures engineering cannot shrink.
Acceptance is the response that needs paperwork, because on software teams it happens silently when a known issue ships. Write the acceptance down, name the approver, and set the threshold that converts it back into work. Our collection of documented cases shows what each response looks like when a real organization chose it.
People Risks and the Quiet Inbox
Process risks announce themselves in metrics; people risks arrive as silence, and software project risk management has to listen for both. A client who stops answering email, a lead engineer interviewing elsewhere, a product owner triple-booked across three parallel projects: none of these appears in a burn-down chart until the damage is scheduled.
Treat the client relationship as a monitored dependency. Record decisions in writing, state the cost of each unanswered question in schedule days, and escalate through the governance route when the silence passes a week. The email that says ‘this decision is now costing three days per week’ has ended more standoffs than any status meeting.
Key-person exposure yields to boring controls: pairing rotations, documentation as a definition-of-done item, and a bus-factor check per component in the project risk questionnaire. Teams resist until the first unplanned absence proves the point, and then the controls write themselves.
What Goes Wrong, and the Fixes That Work
Across software project risk management registers the same failures recur, and most are process breaks rather than surprises. Risk in Focus 2026 ranks the same clusters at enterprise level, which means your project register and your CAE’s are describing one animal at two zoom levels.
| Failure mode | Driver | Countermeasure |
| Register written once at kickoff | Risk treated as a compliance artifact | Exposure re-scored at every sprint boundary |
| Optimistic estimates survive contact | Anchoring on the date leadership wants | Estimate from actuals; publish confidence ranges |
| Red flags noted, go-live proceeds | Sunk cost and announcement pressure | Pre-agreed go/no-go criteria with a named veto |
| Client decisions drift for weeks | No cost attached to waiting | Decision log with schedule cost per open item |
| Security findings deferred to launch | Hardening phase absorbs every slip | Release gates keyed to finding severity |
Birmingham’s go-live-despite-red-flags pattern earns the strongest countermeasure on that list. A go/no-go gate only works when the criteria were agreed before anyone fell in love with the date, and when one named person can say no and survive saying it.
The Regulatory and Technology Horizon

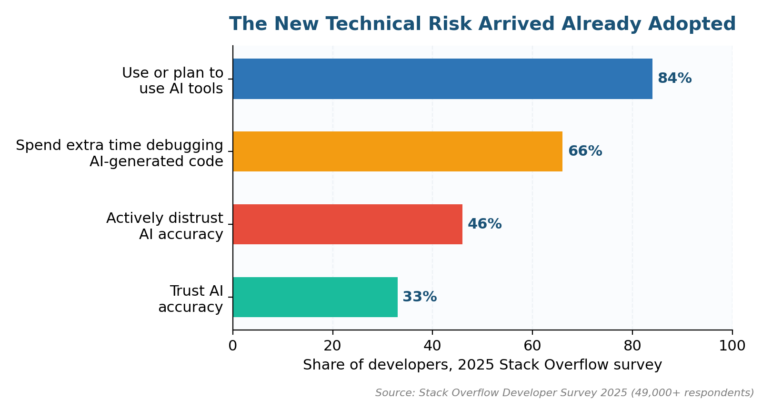

The newest software project risk management entry arrived faster than any governance cycle has ever moved. Per the 2025 Stack Overflow survey, 84% of developers use or plan to use AI tools, while 46% actively distrust their accuracy and only 33% trust it.

Figure 4. Adoption outran trust: the gap between the first bar and the last is a register entry.
The texture of the risk is specific: developers report that AI output is almost right but not quite, and 66% spend more time debugging AI-generated code than expected. Almost-right code passes review more easily than obviously-wrong code, which moves the defect discovery point later and makes review depth a scored risk.
Expect procurement and regulators to catch up through 2027: AI-assisted code disclosure clauses in vendor contracts, provenance requirements in federal work echoing the SSDF’s attestation push, and audit interest in how teams supervise generated code. Projects that fold AI usage logging into software project risk management now will answer those questions from records instead of memory.
Common Software Project Risk Management Questions Practitioners Ask
What is software project risk management in simple terms?
Software project risk management is the habit of listing what could derail a build, scoring each threat by probability times impact, acting on the biggest scores, and re-checking every sprint. It needs a register, an owner per risk, and ten minutes inside ceremonies the team already holds.
What are the biggest risks in software development projects?
Six categories cover most losses: estimation error, scope growth, technical debt and integration failure, vendor dependency, key-person concentration, and deferred security findings. Estimation and scope dominate the frequency column, while vendor and security failures dominate severity, so a balanced register watches both ends.
How do you calculate risk exposure on a software project?
Multiply the probability of the risk firing by its impact in schedule weeks or budget currency. A 30% chance of a six-week vendor delay scores 1.8 exposure-weeks. Score every register entry the same way and the ranking falls out arithmetically, ready for response planning.
How does agile handle software project risk management?
Agile embeds the loop in existing ceremonies instead of separate reviews: refinement surfaces untested assumptions, planning names sprint-level threats, stand-ups promote repeating blockers, and retrospectives test whether responses worked. Short iterations are themselves a treatment, shrinking the cost of discovering that an assumption was wrong.
Who owns risk on a software project?
In software project risk management, the project manager or product owner owns the register and the cadence; each risk carries a named owner closest to its cause; and the sponsor owns appetite, deciding which exposures the project may accept. Response ownership never sits with the register keeper alone, because a keeper who owns every response owns none of them, and the register becomes theater.
How often should software project risks be reviewed?
Re-score exposure at every sprint boundary, review the full software project risk management register at each release or phase gate, and re-run identification when scope, staffing, or a critical vendor changes. Between those points, indicators watch continuously: velocity variance, defect trends, aging findings, and decision-log latency.
Five Things to Take Away
The VA and Birmingham stories close on the same finding: neither program lacked a risk process on paper, and both drowned in unexecuted responses. Whatever the budget, the software project risk management discipline below is what separates the projects that land from the ones that testify.
- Score exposure in weeks or currency, never in matrix colors, and re-score every sprint.
- Give every register entry an owner who can act on the cause, plus a trigger that forces the next look.
- Agree go/no-go criteria before the date has fans, and give one named person a survivable veto.
- Price client silence in schedule days and put it in the decision log where everyone reads it.
- Log AI-assisted code now, because the audit questions are coming faster than the tooling.
Software projects rarely fail from the risk that nobody saw coming. They fail from the risk everybody saw and nobody owned, which is a governance problem wearing an engineering costume, and a problem that disciplined software project risk management can fix inside a single quarter.
