The Project Management Institute reported in its 2026 Pulse of the Profession that 31 percent of complex projects now fail to achieve their originally intended benefits. Two years earlier PMI put that figure at 12 percent, and nothing about project governance got easier in between.

Figure 1. Complex project failure more than doubled in two reporting cycles.
A project risk management plan is the document most teams write once, file away, and never open again. That habit is precisely what the numbers above punish, because a project risk management plan nobody consults cannot influence a single decision.
| Project Risk Management Plan: Key Takeaways |
| The Project Management Institute’s 2026 Pulse of the Profession found that 31 percent of complex projects fail to deliver their intended benefits, more than double the 12 percent PMI reported two years earlier. |
| A project risk management plan is seven things: methodology, named roles, an anchored scoring scale, a live register, response plans, funded reserves, and a review cadence. Miss the scale or the reserves and the rest collapses. |
| Scoring scales only work when the bands carry real anchors. Likelihood in percentage ranges and impact in dollars and days beats a 1-to-10 scale that every stakeholder interprets differently. |
| Contingency reserve covers identified risks and sits with the project manager; management reserve covers unknown-unknowns and sits with the sponsor. Confusing the two is why projects run out of money quietly. |
| PMI’s 2025 research found that projects led by high business-acumen managers adhered to budget 73 percent of the time and failed 8 percent of the time, against 11 percent for other leaders. |
| Every risk needs one accountable name, a trigger condition and a response written before the trigger fires. A register of unowned risks is a list, not a project risk management plan. |
We build and review project risk management plans for delivery organizations, and the useful ones all share a shape. They are short, they carry real numbers, and every risk on them has an individual name attached and a trigger written in advance. At organization level, the equivalent artifact is the enterprise risk management plan, which sets the criteria project plans inherit.
What a Project Risk Management Plan Contains
Strip the boilerplate out of any project risk management plan and seven components remain. For regulated delivery, the project manager in compliance risk management adds an obligations register beside these plan components. Each one answers a question a sponsor will eventually ask, and a plan missing any of them will fail that conversation at the worst possible moment.

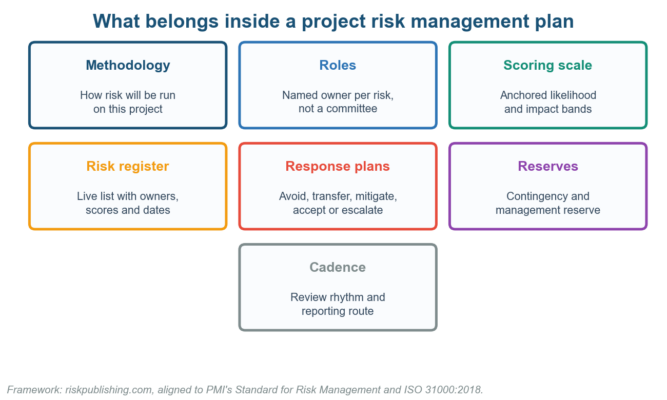

Figure 2. Seven components, and the two most often missing are scoring anchors and reserves.
| Component | What it settles | What good looks like |
| Methodology | How risk will be run on this specific project | Half a page, not a copy of the corporate framework |
| Roles and ownership | Who owns each risk and who escalates | One accountable name per risk, never a committee or a team |
| Scoring scale | What likely and major actually mean here | Percentage bands for likelihood, dollars and days for impact |
| Risk register | The live list everything else reads from | Owned, scored, dated, and visible in the tool the team already uses |
| Response plans | What happens when a risk materializes | Avoid, transfer, mitigate, accept or escalate, chosen per risk |
| Reserves | Where the money comes from when it does | Contingency for known risks, management reserve for the rest |
| Cadence | When the plan gets looked at again | Weekly at team level, monthly to the sponsor, plus trigger-based |
The register is the component everything else depends on. Our guide to building a risk register and the fields a register must carry apply directly, and the difference between a register and a risk log is worth settling before the first workshop.
Setting a Project Risk Management Scoring Scale That Means Something
Here is where most plans quietly fail, and it is worth being blunt about it. A scale that asks people to rate probability and impact from one to ten produces numbers that look precise and mean nothing, because no two stakeholders anchor those numbers the same way.
Anchors fix that problem cheaply and permanently. Express likelihood as a percentage band tied to the delivery window, and express impact in the currency the sponsor actually manages, which is dollars and calendar days rather than adjectives like moderate or significant.

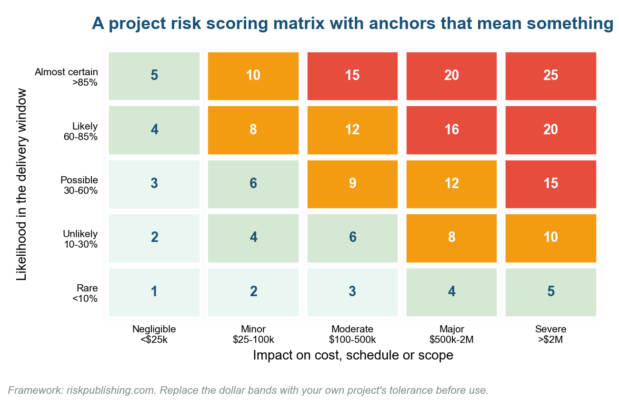

Figure 3. The same matrix without the anchors is a colouring exercise.
| Score band | Meaning | Who decides | Required action |
| 15 to 25 | Threatens the project’s business case | Sponsor, at the next steering meeting | Named response funded and started within two weeks |
| 8 to 12 | Threatens a milestone or a workstream | Project manager, with the risk owner | Response planned, trigger defined, tracked weekly |
| 4 to 6 | Manageable within the workstream | Risk owner | Monitored, response drafted but not funded |
| 1 to 3 | Noise unless conditions change | Risk owner | Recorded, reviewed monthly, no action |
Choosing the grid size matters far less than choosing the anchors, though it is not irrelevant either. Our comparison of 5×5 against 4×4 scoring covers where each one distorts, and a ready risk matrix template saves an argument about colours.
Two published standards underpin project risk management scoring properly. ISO 31000:2018 gives the process, and IEC 31010 catalogues the assessment techniques, which is the reference to reach for whenever a stakeholder insists their favourite method is the only credible one available.
Building the Register Inside Your Project Risk Management Plan
With a scale agreed, the register stops being a wish list and starts being a decision tool. Identification is the easy half; what separates a working project risk management plan is that every entry carries an owner, a trigger and a pre-agreed response.
| Response strategy | When to choose it | Worked project example |
| Avoid | The risk threatens the business case and the approach can change | Drop the custom integration and use the vendor’s supported connector |
| Transfer | Another party is better placed to carry the exposure | Fixed-price the migration workstream, or insure the site works |
| Mitigate | The risk is inherent but its likelihood or impact can be cut | Run a two-week technical spike before committing the architecture |
| Accept | Cost of response exceeds expected loss | Log the risk, fund it from contingency, review monthly |
| Escalate | The risk sits outside the project’s authority | Regulatory change affecting scope goes to the sponsor, not the plan |
Triggers are the part teams skip and later regret. A trigger states the observable condition that converts a risk into an issue, such as vendor test environment unavailable for five consecutive working days, and it belongs in the register alongside the response itself.
Project risk identification benefits from real structure rather than from one unstructured brainstorm held at kickoff week. Our eight-step project risk assessment and a reusable project risk questionnaire surface the risk categories a workshop tends to miss under time pressure.
Funding the Project Risk Management Plan With Reserves
A project risk management plan with no money standing behind it is only a prediction, never a working control. The distinction that matters most, and the one most commonly fudged, is between contingency reserve and management reserve.
| Reserve type | What it covers | Who releases it |
| Contingency reserve | Identified risks already in the register, sized from their scored exposure | Project manager, within the approved baseline |
| Management reserve | Unknown-unknowns that no register could reasonably have listed | Sponsor or steering committee, outside the baseline |
Size the contingency reserve from the register itself rather than from habit or precedent. Summing likelihood multiplied by cost impact across scored risks gives a defensible number, and it beats the flat ten percent that most project plans apply without any evidence.
Reserves also settle an argument about accountability before it starts. When a risk fires and contingency covers it, the project absorbed a known exposure exactly as designed, which is a different conversation from a sponsor discovering an overrun after the fact.
Who Owns What in Project Risk Management
Ownership is where project risk management plans most often go soft in practice. Older guidance assigned risks to functions such as technical staff or finance staff, and a risk owned by a whole function is a risk owned by nobody in particular.
| Role | Accountable for | Not accountable for |
| Sponsor | Management reserve, escalated risks, appetite for the project | Day-to-day register maintenance |
| Project manager | The plan, the cadence, contingency, and register quality | Owning every individual risk personally |
| Risk owner | One named risk: its score, trigger, response and status | Risks outside their control or expertise |
| Workstream leads | Surfacing new risks early from their delivery area | Deciding the project’s overall risk appetite |
| PMO or assurance | Challenging optimism, checking the register is current | Managing the risks it reviews |
That separation mirrors the wider governance model used outside project work. The IIA’s Three Lines Model makes the same distinction between managing risk and providing assurance over it, and our walkthrough of the three lines translates it for delivery teams, while COSO’s enterprise risk guidance supplies the governance layer above the project.

Figure 4. Judgment about the business, not volume of process, separates the outcomes.
PMI’s 2025 Pulse of the Profession found that projects run by managers with strong business acumen adhered to budget 73 percent of the time and failed 8 percent of the time, against 11 percent elsewhere. Process alone does not produce that gap.
Running the Project Risk Management Plan After Approval
Approval is the start of a project risk management plan’s useful life, not the end of the work. Three rhythms keep it alive, and a plan reviewed only at stage gates will already be stale by the time anyone consults it.
| Rhythm | What happens | Output |
| Weekly team review | New risks logged, scores challenged, triggers checked | Register updated with dated changes, not silent edits |
| Monthly sponsor report | Top risks, movement since last month, decisions needed | One page the sponsor reads, tied to the register |
| Trigger-based | A defined condition fires and the pre-agreed response starts | Risk converts to issue with the response already funded |
Indicators are what make project risk management reviews genuinely forward-looking rather than merely retrospective. Adapting key risk indicators to a project means tracking things like requirement change rate, defect reopen rate and critical-path float, each with a threshold agreed in advance.
Scale the project risk management effort to the size of the project itself. Our guidance on managing risks in complex projects and on risk across portfolios and programs covers where a single project register stops being the right unit of control, a boundary programme management standards define more formally.
Where Project Risk Management Plans Fail
A construction client showed us a register with 140 entries last year, none scored above medium, and a project four months late. Everything had been logged and nothing had been decided, which is the most common failure pattern we meet.
| Failure | Why it happens | Fix |
| Register logged but never used | Written for the stage gate, not for decisions | Tie register review to the weekly delivery meeting |
| Unanchored scoring | Nobody wanted to defend a dollar figure | Set percentage and dollar bands before the first workshop |
| Everything scored medium | Scoring done to avoid escalation | Force ranking: the top five risks must be identifiably worse |
| Risks owned by functions | Naming an individual felt confrontational | One person per risk, recorded, updated when people rotate |
| No triggers | Teams assume they will notice in time | Write the observable condition when the risk is first logged |
| Contingency set at a flat percentage | Copied from the last project | Size it from summed exposure across scored risks |
| Closed risks never removed | Register grows until nobody reads it | Close with a dated reason; keep the live list under thirty |
Federal delivery shows the same pattern at scale. GAO’s reviews of federal IT modernization repeatedly find programs years behind schedule where risk processes existed but produced no decisions, and its 2026 duplication report puts the addressable waste above $100 billion. The same pattern shows in DoD IT acquisitions and in NASA’s major project assessments.
Project Risk Management: Common Questions Answered
What is a project risk management plan?
A project risk management plan is the document that sets out how risk will be identified, scored, owned, funded and reviewed on one specific project. It covers methodology, roles, the scoring scale, the register, response plans, reserves and the review cadence.
How do you start a project risk management plan?
Agree the scoring anchors with your sponsor before running any project risk identification workshop. Teams that identify risks first and define the scale afterwards end up rescoring everything, because the early entries were rated against a scale nobody had actually agreed.
What is the difference between a risk register and a project risk management plan?
The project risk management plan is the method; the register is the data that method produces. A register lists individual risks with owners and scores, while the plan explains how those scores were derived and what happens when one crosses a threshold.
How much contingency should a project risk management plan hold?
Size it from the register rather than by convention, summing likelihood multiplied by cost impact across scored risks. The flat ten percent most plans apply is a starting sanity check, not a defensible figure in front of a finance director.
Who should own project risk management on a project?
The project manager owns the project risk management plan and its cadence, while each individual risk carries one named owner who may sit anywhere in the team. The sponsor owns management reserve and any risk escalated beyond the project’s authority.
How often should a project risk management register be reviewed?
Review it weekly with the delivery team, monthly with the sponsor, and immediately whenever a trigger condition fires. Registers reviewed only at stage gates are archives rather than controls, since most project risks change faster than the gate calendar does.
Does agile delivery still need project risk management?
Yes, although project risk management does look considerably lighter under most agile delivery methods. The register folds into backlog refinement, triggers become explicit acceptance conditions, and the sprint rhythm supplies the review cadence the plan needs without adding any separate meetings.
Three Shifts That Will Rewrite Project Risk Management
Complexity is the first, and PMI’s own data makes the case. When 31 percent of complex projects miss their benefits and four in five suffer distinct fallout from mismanaged complexity, the plan has to address interdependency rather than a flat list of risks.
The second shift moves project risk management toward benefits rather than the iron triangle. Sponsors increasingly ask whether the project delivered its intended outcome, so registers tracking only cost and schedule exposure will look incomplete against PMI’s risk management standard. Public companies carry a further trigger through the SEC cybersecurity disclosure rule.
The third shift is technical risk moving into every project, whatever the sector. Software and AI components now carry exposures that generic project templates never anticipated, which is why we treat software development risk as its own discipline alongside the general risk management process.
Delivery teams shipping any code should reflect that in their gates. Mapping build and release criteria to NIST’s Secure Software Development Framework and translating cyber exposure through NIST CSF 2.0 keeps the project risk management plan credible with a security function.
Put Your Project Risk Management Plan to Work
Open your current register and check two things this week: how many risks have a named individual owner, and how many have a written trigger. If either answer is low, the plan is documentation rather than control, and that is fixable in a fortnight.
We help delivery organizations set their project risk management anchors, size the reserves properly, and build registers that sponsors will actually read each month. Browse our advisory services or get in touch about the project you are least confident in.
Teams working through project risk management alone should start with what a risk management plan is, follow the build steps in how to make a risk management plan, then run a structured risk assessment against the current phase.
Anchor the project risk management method in something durable rather than in a downloaded template. ISO 31000 principles alongside the ISO risk management hub, the complete risk assessment guide, and a defensible appetite statement give the plan a spine that outlasts any single project.
Practitioners looking to formalise the project risk management skill have two credible routes available to them. We compared PMP against PMI-RMP for risk roles, the PMI-RMP credential itself is the specialist option, and we set both against the wider field in our ranking of risk management certifications.

Chris Ekai is a Risk Management expert with over 10 years of experience in the field. He has a Master’s(MSc) degree in Risk Management from University of Portsmouth and is a CPA and Finance professional. He currently works as a Content Manager at Risk Publishing, writing about Enterprise Risk Management, Business Continuity Management and Project Management.
