On 25 February 2026, Black Duck published its Open Source Security and Risk Analysis of 947 commercial codebases and reported an average of 581 open source vulnerabilities per codebase. One year earlier the same audit found 281, a 107 percent rise the firm attributes directly to AI-accelerated code creation.
Every one of those numbers lands inside somebody’s delivery pipeline. A software development risk management plan is the document, and more importantly the operating routine, that decides whether your project is the one that catches those defects before a customer or a regulator does.
| Software Development Risk Management Plan: Key Takeaways |
| Black Duck’s 2026 Open Source Security and Risk Analysis, published 25 February 2026, found the average commercial codebase now carries 581 open source vulnerabilities, a 107 percent jump in a single year that the report ties to AI-accelerated code creation. |
| A software development risk management plan is a living register with named owners, quantified triggers and stage gates across the delivery pipeline, not a document written at kickoff and filed. |
| AI-generated code is now a first-class risk category: roughly one in four AI code samples carries a confirmed vulnerability, yet only 24 percent of firms fully evaluate the code their tools produce. |
| The regulatory clock is running. EU Cyber Resilience Act reporting obligations start 11 September 2026 and full obligations land 11 December 2027, reaching any US firm that ships digital products into Europe. |
| NIST SSDF SP 800-218 supplies the secure-development practices, its 800-218A profile of July 2024 extends them to generative AI, and ISO 31000 supplies the risk process that joins them to the business. |
| The July 2024 CrowdStrike update, which cost US Fortune 500 companies an estimated $5.4 billion, was a release-stage failure, proof that deployment risk deserves the same rigor as build risk. |
The version of this article we published in 2023 treated software development risk as a paperwork exercise, and much of the internet still does. This rebuild takes the opposite position: the plan is a set of decisions with owners and triggers, and the document is just where they are recorded.
What a Software Development Risk Management Plan Actually Contains
Strip the template language away and the plan answers four questions. What can hurt this project, how badly and how likely, who owns each exposure, and what happens automatically when a threshold is crossed. Everything else in the document exists to make those four answers auditable.
| Component | What it does | What good looks like |
| Risk register | Records every identified software development risk with score, owner and response | Live artifact in the team’s tracker, reviewed at sprint cadence, not a spreadsheet updated quarterly |
| Scoring method | Makes likelihood and impact comparable across technical and business risks | One agreed scale, anchored with dollar and schedule definitions, applied by everyone |
| Ownership map | Assigns one accountable name per risk, distinct from the person doing mitigation work | No risk owned by a committee, a vendor or the word team |
| Stage gates | Blocks progression when defined criteria are unmet at plan, build, test and release | Gates that have actually stopped a release at least once, proving they are real |
| Triggers and responses | Pre-agrees the action when an indicator breaches its threshold | If dependency CVE count exceeds X, freeze features and burn down, written before the breach |
| Communication rhythm | Moves risk information to sponsors and stakeholders on a fixed cycle | A one-page report the sponsor actually reads, tied to the register, not a slide ritual |
The register deserves most of the early effort because every other component reads from it. Our guide to building a risk register and the fields a register must carry translate directly to software projects, with the pipeline stage added as one extra column.
Scoring is where teams overcomplicate first. A calibrated 5×5 matrix beats a 4×4 for software work because delivery risk clusters in the middle of the scale, and a downloadable risk assessment matrix gets a team arguing about anchors instead of colors.
The Software Development Risk Categories That Matter in 2026
Categories only earn their place in a software development risk management plan if they change who you assign and what you monitor. Five cover the current threat picture, and two of them barely existed when most of the templates still circulating online were written.

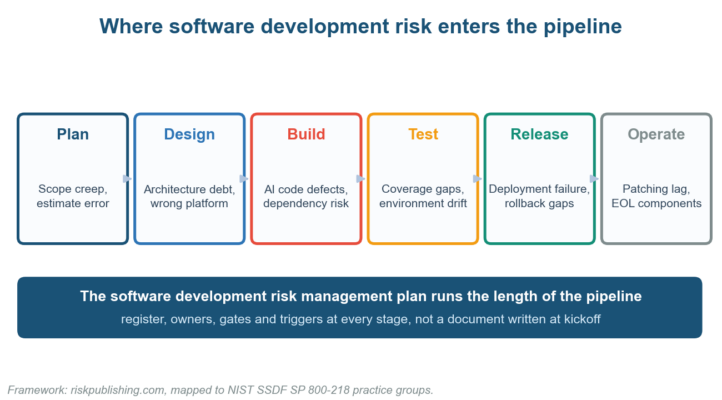

Figure 1. Each pipeline stage admits a different family of software development risk.
Dependency and Supply Chain Software Development Risk
Open source is no longer a component choice, it is the substrate. The 2026 audit found open source in 98 percent of codebases, 87 percent carrying at least one vulnerability and 44 percent carrying critical-risk issues, per Black Duck’s announcement.

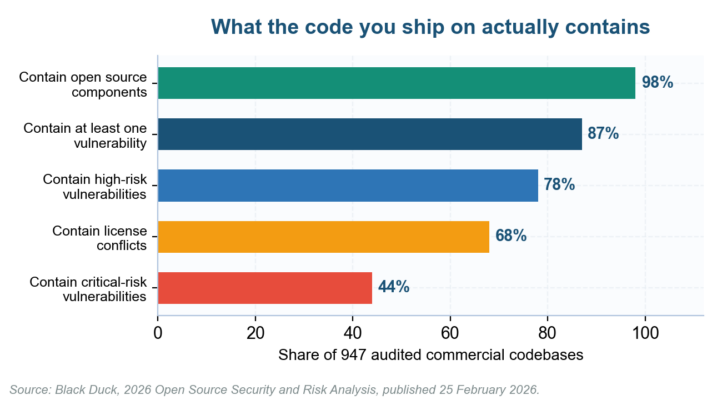

Figure 2. Nearly half of audited codebases carried critical-risk vulnerabilities.
The software development risk plan’s answer is a maintained software bill of materials and a dependency-update budget treated as scheduled delivery work rather than optional hygiene done in spare time. NIST’s C-SCRM guidance and a third-party risk framework give the register its supplier-facing entries.
License risk rides the same rails and gets a fraction of the attention. Two-thirds of audited codebases now contain license conflicts, the highest rate the study has recorded, and a conflict discovered during due diligence can stall an acquisition faster than a CVE.

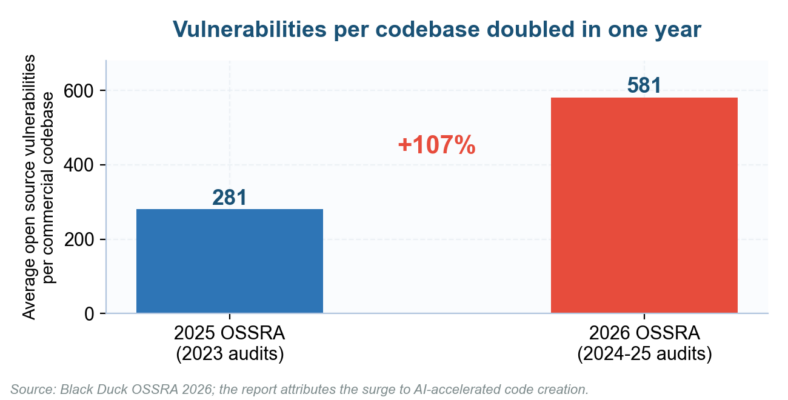

Figure 3. The one-year doubling that put dependency risk at the top of the register.
AI-Generated Code as a Software Development Risk
Assistants changed the volume equation before the control equation caught up. Roughly one in four AI-generated code samples contains a confirmed vulnerability when tested against the OWASP Top 10, yet only 24 percent of organizations fully evaluate the AI code they merge.
The working posture is to treat AI output as untrusted contribution from a fast, confident junior developer who never gets tired. NIST SP 800-218A, published 26 July 2024, extends secure development practice to generative AI, and an AI governance framework decides who is allowed to merge what.
Schedule, Deployment and Operational Software Development Risk
Classic project risks did not retire while the technical ones multiplied. Estimate error, scope creep and key-person loss still sink more projects than exploits do, and the risk management process handles them the same way it always has: named owner, quantified trigger, pre-agreed response.
Release risk earned its own register section on 19 July 2024, when a faulty CrowdStrike content update crashed 8.5 million Windows machines and cost US Fortune 500 firms an estimated $5.4 billion. One deployment control, a staged rollout with automatic rollback, was the difference between vendors that shrugged and vendors that testified.
Operational exposure begins the moment code ships and keeps compounding after the project team disbands. Pair the software development risk plan with an incident response plan and a tested disaster recovery template, because the register’s operate-stage entries are only credible if recovery has been rehearsed.
Standards Behind a Software Development Risk Management Plan
Nothing in a software development risk management plan needs inventing from scratch, and auditors respond far better to mapped frameworks than to homegrown ones. Four documents carry most of the weight, and each one answers a different question the plan must settle.
| Framework | What it contributes | Where it lands in the plan |
| NIST SSDF SP 800-218 | Four practice groups for secure development: prepare, protect, produce, respond | The build and release gate criteria, mapped practice by practice |
| NIST SP 800-218A, July 2024 | Extends SSDF to generative AI and dual-use foundation models | The AI code review policy and model-sourcing entries |
| ISO 31000:2018 | The risk process: identify, analyze, evaluate, treat, monitor, communicate | The plan’s spine, register structure and review cadence |
| ISO/IEC 27001 | Certifiable information security management system | Control selection for data-handling and access risks |
| NIST CSF 2.0 | Enterprise cyber language, govern function added February 2024 | Translation layer between the project register and the CISO’s reporting |
| EU Cyber Resilience Act | Mandatory security requirements for products with digital elements | Regulatory entries with dated triggers, September 2026 and December 2027 |
The SSDF project page is the practical starting point for software development risk because its practices convert directly to gate criteria. Underneath it, ISO 31000 supplies the process discipline, and our plain-language ISO 31000 guide covers the vocabulary it assumes, while NIST CSF 2.0 and ISO/IEC 27001 join the register to enterprise security.
Regulation is the newest column in the register and the least forgiving. The EU Cyber Resilience Act begins vulnerability-reporting obligations on 11 September 2026 and applies in full on 11 December 2027, reaching US firms that ship digital products into Europe regardless of headquarters.
Public-company teams carry one more dated trigger in the software development risk register. The SEC cybersecurity disclosure rule compresses a materiality decision into four business days, which means a production incident on your product can become a filing before your sprint ends.
Building the Software Development Risk Management Plan in Six Steps
Sequence beats thoroughness here, because a software development risk plan that arrives after the architecture decisions is a commentary, not a control. The six steps below assume a real project with a real deadline, not a compliance exercise built around somebody’s template.
| Step | What you do | Evidence it is done |
| 1. Frame | Set scope, appetite and scoring anchors with the sponsor before design closes | One page stating what the project will not risk, signed by the sponsor |
| 2. Identify | Run structured identification per pipeline stage, not one brainstorm at kickoff | Register entries tagged to plan, design, build, test, release and operate |
| 3. Score | Rate likelihood and impact on the agreed scale, in money and days where possible | No entry scored high without a number behind it |
| 4. Assign | One accountable owner per risk plus a response: avoid, reduce, transfer or accept | Zero risks owned by team, vendor or TBD |
| 5. Gate | Convert top risks into stage-gate criteria and pipeline triggers | A release blocked by a gate at least once without escalation drama |
| 6. Monitor | Review the register at sprint cadence and report to the sponsor monthly | Register history showing scores that moved, closed and were added |
Step one is the one teams skip and regret. An appetite conversation forces the sponsor to say aloud whether the deadline or the defect rate wins when they collide, and worked appetite statements give you language for a conversation most sponsors have never been asked to have.
Step six is where indicators earn their place in the software development risk routine. A small set of key risk indicators, dependency CVE count, test coverage trend, deploy failure rate and unplanned-work share, tells you the register is aging before a milestone slips.
Teams wanting an external benchmark for that software development risk indicator set can borrow directly from DORA’s delivery research. Change failure rate and time to restore service are software development risk measures in everything but name, and executives already trust them.
Running the Software Development Risk Plan Without Killing Velocity
The loudest objection to any software development risk process on a delivery team is speed, and it deserves a straight answer. A plan that adds meetings will fail; a plan that moves decisions earlier pays for itself in unblocked releases and shorter arguments.
| Friction point | What teams fear | The working compromise |
| Sprint-cadence register review | Another standing meeting | Fold it into existing sprint planning as one fifteen-minute agenda item |
| Stage gates | Bureaucratic release blockers | Automate the checkable criteria in CI so the gate is a pipeline status, not a meeting |
| AI code evaluation | Reviewing volume that grew tenfold | Risk-tier the review: full scrutiny for auth, payments and data paths, sampling elsewhere |
| SBOM maintenance | Endless dependency bookkeeping | Generate it from the build, alert only on new critical CVEs and license changes |
| Sponsor reporting | Status theater | One page, top five risks, movement since last month, decisions needed |
The pattern across all five rows is the same one throughout. Convert human ceremonies into pipeline signals wherever the criterion is checkable by a machine, and spend all of the recovered attention on the software development risks that genuinely need human judgment.
Escalation only works if the route is drawn before it is needed. The three lines model settles who challenges the project’s own risk view, and an integrated risk management program is where a software register meets the enterprise one instead of living in a silo. It also connects upward to the wider project risk management plan.
Seven Traps That Derail Software Development Risk Plans
A fintech client showed us a beautifully formatted plan last year, thirty pages, current logos, zero register updates since the kickoff workshop eight months earlier. The document had been mistaken for the discipline, which is the parent failure behind most of the traps below.
| Trap | Root cause | Correction |
| Write-once plan | Plan treated as a deliverable rather than an operating routine | Tie register review to sprint cadence and show movement history |
| Risks without numbers | Fear of being wrong in front of the sponsor | Score in money and days; let monitoring correct bad estimates |
| Committee ownership | Nobody wanted the difficult entries | One name per risk, revisited when people rotate off the project |
| Gates that never fire | Criteria written to be passable | Audit gate history; a gate that never blocked anything is decoration |
| AI code merged unreviewed | Volume outran the review model | Risk-tiered review with full scrutiny on sensitive paths |
| SBOM produced once | Treated as a customer checkbox | Regenerate per build and alert on deltas, not snapshots |
| Register ends at release | Plan scoped to the project, not the product | Carry operate-stage risks into the run team’s register with owners |
Federal delivery experience backs the write-once finding at much larger scale. GAO’s reviews of major IT programs repeatedly connect cost and schedule overruns to risk processes that existed on paper but produced no decisions, which is the same failure at billion-dollar scale.
The deeper correction is cultural rather than procedural, and it costs nothing. A team that treats a fired gate as the system working, rather than as an embarrassment to be explained away, has a functioning software development risk plan regardless of what the document looks like.
Software Development Risk Management Plan: Your Questions Answered
What is a software development risk management plan?
It is the register, scoring method, ownership map, stage gates and monitoring routine a project uses to find and control threats to delivery and to the product. The document records those decisions; the discipline is the recurring review that keeps them current.
What are the main categories of software development risk?
Five categories cover the 2026 software development risk picture: dependency and supply chain risk, AI-generated code risk, schedule and estimation risk, deployment and release risk, and operational risk after go-live. Each maps to a different pipeline stage and needs a different accountable owner.
How often should a software development risk register be reviewed?
At sprint cadence for the delivery team, monthly for the sponsor, and immediately whenever a defined trigger fires. A software development risk register reviewed quarterly is an archive, because dependency and AI-related exposures now move considerably faster than a quarter.
Who should own the software development risk management plan?
The project or delivery manager owns the software development risk plan and its routine, while each individual risk carries one accountable owner who may sit in engineering, security or the business. Escalation runs through the second line, never through the loudest stakeholder.
How does AI-generated code change software development risk?
It multiplies output volume while roughly one in four generated samples carries a confirmed vulnerability, so unreviewed merging converts speed straight into defect debt. The working controls are risk-tiered review, provenance tracking and the NIST SP 800-218A practices written for generative AI.
What standards should a software development risk plan follow?
Map the software development risk plan to NIST SSDF SP 800-218 for secure development, ISO 31000 for the risk process, ISO/IEC 27001 where certification matters, and NIST CSF 2.0 for enterprise translation. Firms shipping into Europe add the Cyber Resilience Act’s dated obligations.
Is a software development risk management plan needed on agile projects?
Yes, and agile makes the software development risk plan lighter rather than optional. The register folds into sprint planning, gates become automated pipeline criteria, and the fixed review cadence agile already provides is exactly the monitoring rhythm the plan requires anyway.
The Regulatory and Technology Horizon for Software Development Risk
The next two years are unusually easy to calendar. EU CRA reporting obligations arrive 11 September 2026, full obligations on 11 December 2027 under Regulation 2024/2847, and every dated obligation belongs in the register now with a named owner and a lead time.
Expect buyer pressure to outrun regulation on software development risk, because procurement teams move faster than parliaments ever will. CISA’s Secure by Design initiative has already pushed large customers to demand SBOMs and secure-development attestations in contracts, turning what was compliance into a sales-qualification gate.

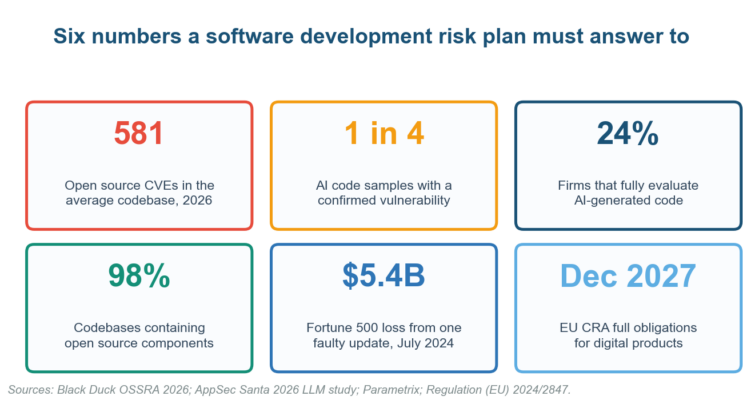

Figure 4. The numbers that should anchor a 2026 software development risk register.
AI risk will keep shifting from the code to the system. As assistants become agents that open pull requests unprompted, the register inherits questions the NIST AI Risk Management Framework was built for, and the breach data in IBM’s annual study already prices unmanaged AI at a premium.
Our forward position is simple. The teams that thrive will treat the software development risk plan as pipeline infrastructure, wired into CI and reviewed like code, while the teams that suffer will still be formatting documents when the auditor, or the outage, arrives.
Pressure-Test Your Software Development Risk Plan With Risk Publishing
Ask your delivery lead two questions this week: when did a gate last block a release, and what happens automatically when the dependency CVE count breaches its threshold. Silence on either is the finding, and it is fixable in a quarter.
We help engineering and risk leaders build software development risk registers, gates and appetite statements that survive first contact with a real release calendar. Review our advisory services and start a conversation about the project you are least sure of.
Teams starting alone should draft the software development risk register first, run a structured risk assessment against the current release, and check the security column against our NIST CSF and ISO comparison before the next architecture decision locks anything in.
Then connect it upward, because a project register that never reaches the enterprise view protects nobody. Operational risk management, business resilience and vendor concentration analysis are where software development risk stops being an engineering topic and starts being a board one.

Chris Ekai is a Risk Management expert with over 10 years of experience in the field. He has a Master’s(MSc) degree in Risk Management from University of Portsmouth and is a CPA and Finance professional. He currently works as a Content Manager at Risk Publishing, writing about Enterprise Risk Management, Business Continuity Management and Project Management.
