What is Project Risk Management?

Photo of author
Written By Chris Ekai

Project risk management is the process of identifying threats and opportunities that could affect a project’s objectives, analyzing their likelihood and impact, responding with a chosen strategy, and monitoring the results throughout delivery. It runs on a living risk register with named owners, and it treats upside risk with the same rigor as downside. A register earns its keep only when you plan a response for every entry, with one strategy, a named trigger, and funded action.

In July 2025, the Federal Railroad Administration terminated roughly $4 billion in grants for California’s high-speed rail project. The agency’s 300-page compliance review listed a $7 billion funding gap, a missed 2024 train-procurement deadline, and one finding that belongs in every project management course: a failure to keep the risk register up to date.

Project Risk Management: Key Takeaways
Identify whatever could push the project off its objectives, score it, respond, and monitor: four moves, one loop, with a living risk register at the center.
The FRA terminated about $4 billion in California high-speed rail grants in 2025, and its 300-page review cited a failure to keep the risk register up to date among the grounds.
Bent Flyvbjerg’s database of 16,000+ projects shows 8.5% finishing on budget and on time, and 0.5% also delivering the promised benefits, which is the case for the discipline in two numbers.
Risk cuts both ways: threats get avoided, reduced, transferred, or accepted, while opportunities get exploited, enhanced, shared, or accepted, and one register should hold both.
The project manager owns the register and cadence, risk owners act on causes, sponsors set appetite and decide acceptances, and every team member identifies.
A stale register is evidence against you: reviewers now read it as proof of whether the project was governed or merely scheduled.

California dropped its lawsuit over the termination that December, while the 171-mile Merced-to-Bakersfield segment kept building on state funds. A generation of American megaproject ambition now hangs partly on how well one document was maintained, and the document in question was a risk register.

That is the stake this page defines. Project risk management is not paperwork riding on top of delivery; it is the part of delivery that funders, auditors, and courts read when they decide whether a project was governed. The definition, the roles, and the working parts follow.

Project Risk Management, Defined

At definition level, project risk management identifies, analyzes, and responds to uncertainty that could affect a project’s objectives, then monitors whether the responses work. ISO 31000 frames it as one repeating process, and the UK’s Association for Project Management defines it the same way from the delivery side.

Three boundaries sharpen the definition. A risk is uncertain, separating it from an issue that has already landed, and it is tied to objectives, so a threat touching nothing you promised is noise. It also carries direction, because uncertainty can help as easily as hurt, a point the positive risk literature keeps having to re-argue.

The working tool is the risk register: one line per risk with cause, consequence, score, owner, response, and date. The FRA finding shows what the register has quietly become, which is the audit evidence of governance itself, checked by outsiders who fund and review projects for a living.

Two Numbers That Justify the Whole Discipline

The case for project risk management fits in one dataset. Bent Flyvbjerg’s database of more than 16,000 major projects across 136 countries finds 8.5% delivered on budget and on time, and 0.5% delivered on budget, on time, and with the benefits promised in the business case.

What is Project Risk Management?

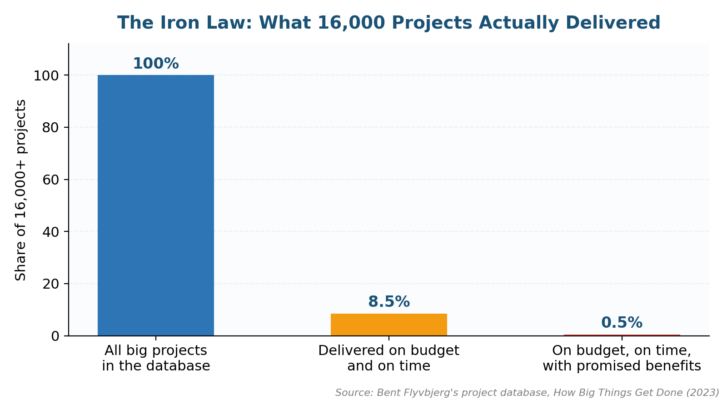

Figure 1. The iron law of megaprojects: over budget, over time, under benefits, over and over.

Flyvbjerg calls it the iron law of megaprojects, and his diagnosis is optimism and political pressure baked into the baseline, not bad luck in delivery. Which means the estimates themselves were the first unmanaged risk, standing there before ground was ever broken.

The same pattern shows up at audit scale. The UK’s National Audit Office keeps finding that major programmes fail at the front door, through unrealistic baselines and ungoverned optimism, and internal audit surveys rank the same causes on the corporate side. Registers built on honest baselines are rarer than templates suggest, and honest baselines are where project risk management earns its keep.

Threats Cut, Opportunities Compound

Every risk on a project risk management register takes one of eight responses, four for each direction of uncertainty. Threats are avoided, reduced, transferred, or accepted; opportunities are exploited, enhanced, shared, or accepted. The full response logic is the same arithmetic run in two directions.

What is Project Risk Management?

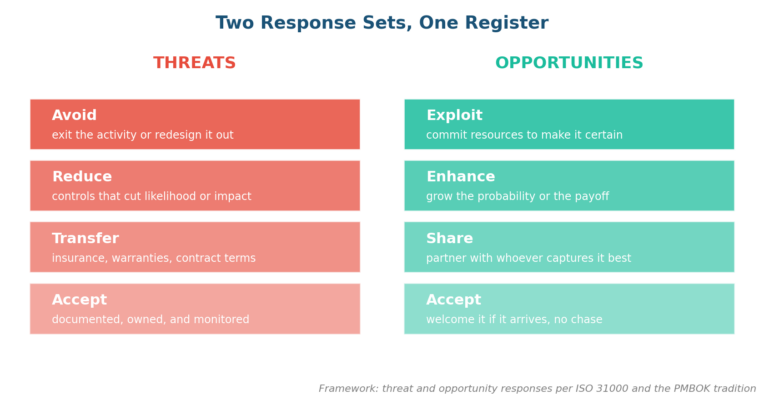

Figure 2. Eight responses, two directions: the register should be running both columns.

Opportunity management is where most registers go blank, and the blankness costs real money that never shows up on any variance report. A team that discovers reusable components, an early-finish possibility, or a supplier willing to co-invest is holding upside risk, and exploiting it needs the same owner-action-date treatment as any threat on the page.

One caution keeps the upside honest: chased opportunities are how scope creep enters wearing a friendly face. Price every enhancement against the baseline before adopting it, the same discipline our worked risk examples apply to threats, and mission creep stays visible instead of accumulating.

Who Owns What on a Live Project

Accountability is where project risk management definitions either become practice or stay slideware. The project manager owns the register, the cadence, and the escalation route; risk owners act on individual causes; the sponsor sets appetite and signs acceptances; and identification belongs to everyone on the delivery floor.

What is Project Risk Management?

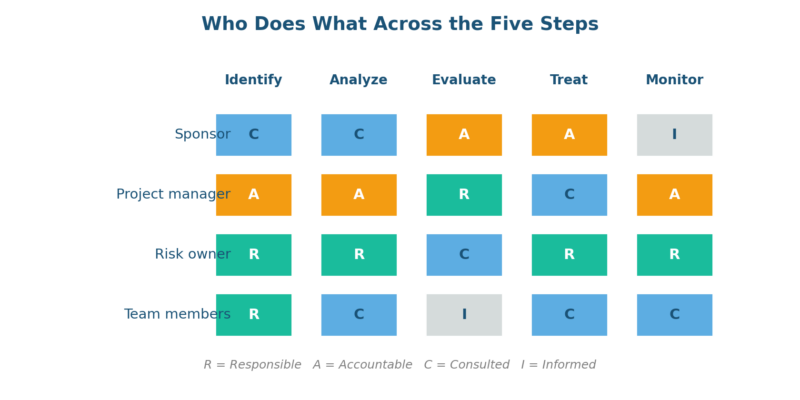

Figure 3. One accountable name per cell: the grid fails wherever a box holds a committee.

Two failure patterns dominate. Registers kept by the project manager alone turn into diaries nobody else reads, and acceptances made below sponsor level turn into surprises with no signature attached. The governance route exists precisely so those two shortcuts have somewhere visible to fail.

On multi-project estates the ownership question climbs a level, because concentration builds across registers that each look fine alone. That aggregation problem belongs to portfolio risk management, and it is the reason single-project registers roll upward on a schedule.

The Process, Compressed to One Pass

The project risk management loop is five steps, and this site walks each in depth: identify against objectives, analyze likelihood and impact, evaluate against appetite, respond, and monitor. The full five-step walkthrough covers the deliverables; here the compressed version shows where projects differ from enterprises.

Step Project-specific twist Where it lives in the schedule
Identify Workshops per phase, plus lessons from prior projects Kickoff, then every stage gate
Analyze Score in schedule days and budget currency, never colors alone Before each baseline commit
Evaluate Rank against the sponsor’s stated tolerance per objective Steering committee cycle
Respond Fund the action inside the project budget, name the owner Change control, same week
Monitor Indicators reviewed at the cadence delivery already runs Weekly status, every gate

Iterative delivery folds the loop into shorter turns, a point the agile tradition made structural: each sprint is a small bet with a built-in review. Our software project guide shows that version of the loop in full, exposure math included.

Depth of analysis is a budgeting choice in its own right, and IEC 31010 catalogues the techniques for when scoring needs to go quantitative. Most project risk management efforts need a calibrated qualitative scale, a consistent methodology, and honesty about which risks deserve modelling money.

Building the Project Risk Management Plan

The project risk management plan is the document that makes the loop repeatable by people other than its author. It fixes the scales, the cadence, the escalation thresholds, and the register format before the first workshop, so scoring arguments happen once instead of monthly. Our plan-building guide walks the sections.

Keep the plan short and the register alive, because the FRA precedent inverted the old priority: a beautiful plan with a stale register now reads worse than a plain plan with a current one. Structured intake, like a project risk questionnaire, keeps identification flowing between workshops.

Tailor by scale, never by template. A complex programme earns quantitative analysis and a dedicated risk function; a three-month build earns a one-page register reviewed weekly. Formal method families like M_o_R exist for the first case, and restraint is the method for the second.

Where Risk Work Meets Project Management

The two disciplines are siblings with different verbs. Project management plans, schedules, and executes the work; project risk management protects those plans from what has not happened yet. One produces the baseline, the other defends it, and COSO’s enterprise framing shows the same division one level up.

In practice the boundary between project risk management and project management works as a handoff rhythm, with no wall in sight. Risk analysis feeds contingency into the schedule; earned-value variances feed new risks back into the register; and tracking tooling carries both streams to the same status meeting. Projects fail in the gap whenever the two run on separate calendars.

Red Flags to Watch (And Green Lights to Chase)

The FRA’s 300-page review is effectively a red-flag catalogue, and the same signals repeat at every project scale we see. Watch for these, and for their green-light inverses, which are worth as much in a funding review as the flags cost:

  • Register untouched for a quarter while the schedule moved: the FRA read that gap as ungoverned delivery.
  • Baselines with no contingency and no stated confidence range, which is optimism wearing a spreadsheet.
  • Acceptances nobody signed: a risk everyone knew about with no name attached is a finding in waiting.
  • Green light: risks retired with evidence at every gate, proof the loop is turning, not decorating.
  • Green light: opportunity entries with owners and dates, the clearest sign a register is being used to manage rather than to comply.

Boards have learned to ask for exactly these signals. The NCSC’s board toolkit teaches non-executives to probe with testable questions, and Protiviti’s 2026 survey shows executives ranking delivery-style risks near the top, so project risk management registers now get read well above the project.

Project Risk Management FAQs: Expert Answers to Critical Questions

What does project risk management mean in practice?

In practice it means asking four questions on a fixed cycle: what could push this project off its objectives, how likely and how big is each threat or opportunity, what will we do about the ones that matter, and is that response working. The answers live in a risk register with named owners and review dates.

What are the main types of project risk?

Most registers group project risks into schedule, cost, scope, technical, resource, vendor, and compliance categories, with opportunity entries alongside the threats. The mix shifts by domain: construction carries safety and ground conditions, software carries estimation and integration, and every project carries the risk of an optimistic baseline.

What is the difference between a project risk and an issue?

In project risk management, a risk is uncertain and managed ahead of time; an issue has already happened and is managed as work. When a risk fires, it moves from the register to the issue log, its response plan activates, and the register records what the scoring missed so the next pass calibrates better.

Who is responsible for project risk management?

Process ownership sits with the project manager: register, cadence, and escalation. Individual risk owners act on causes they control, the sponsor sets appetite and signs acceptances, and every team member carries identification duty. Ownership concentrated in the project manager alone is itself a red flag reviewers look for.

What is positive risk in project management?

Positive risk is uncertainty that would help the project if it landed: an early finish, reusable work, a supplier willing to share investment. It gets the same register treatment as threats, with exploit, enhance, share, and accept as the response set, priced against the baseline so upside never smuggles in scope.

How is project risk management different from enterprise risk management?

Scope and cadence divide them. Project risk management protects one temporary undertaking’s objectives on a weekly-to-gate cadence; enterprise risk management protects the whole organization’s strategy on a quarterly cycle. Project registers roll up into the enterprise view, and the enterprise appetite flows down as the tolerance each project evaluates against.

The TL;DR for Decision-Makers

Expect project risk management scrutiny to keep hardening through 2027. The FRA precedent gives every public funder a template for reading risk documentation as compliance evidence, and private capital reads the same signals in due diligence, so a current register is turning into a financing asset.

The second shift is directional: opportunity management is moving from textbook footnote to expected practice, because sponsors who watched Flyvbjerg’s 0.5% number want the upside column worked as hard as the downside. Registers that only ever list threats are starting to look like half a discipline.

Run the loop, keep the register current, put one accountable name in every cell, and price both directions of uncertainty. Projects that do this still hit weather they never predicted, but they meet it with responses already funded, which is the entire difference project risk management sells. When you run many projects at once, project portfolio risk management extends the same loop across the whole collection.

If your register would not survive a funder’s 300-page review, our advisory services rebuild it to evidence standard. Start the conversation with your current register and your next gate date, and we will work backward from what the reviewers will ask.
