The project manager in compliance risk management owns the obligations that touch the project: identifying every law, regulation, and contract clause that binds the work, building controls and evidence into the plan, monitoring compliance KRIs through delivery, and escalating breaches fast. The compliance function owns the framework; the project manager owns its execution inside the project.

On October 16, 2024, Raytheon agreed to pay more than $950 million to resolve defective pricing on U.S. Department of Defense contracts, bribery of a Qatari official, and export-control violations. The $428 million False Claims Act piece stands as the second-largest procurement-fraud recovery in the statute’s history, as Venable’s analysis notes.

Project Manager in Compliance Risk Management: Key Takeaways
The project manager owns compliance risk inside the project boundary: the obligations register, controls built into the plan, evidence trails, and escalation. The compliance function owns the framework; legal and audit own advice and assurance.
Project-level acts create enterprise-level bills. Raytheon’s October 2024 settlement, more than $950 million for defective contract pricing, Qatar bribery, and export violations, priced decisions made inside project teams.
Non-compliance costs roughly 2.7 times what compliance does ($14.82M vs $5.47M annually, Ponemon), and IBM’s 2025 breach data adds a six-figure premium wherever a noncompliance factor is present.
The compliance risk management plan is a project artifact: identify obligations (statutes, regulations, contract clauses), score exposure, assign controls to work packages, and wire KRIs with thresholds to the project rhythm.
Compliance runs through every process group, from the obligations register at initiation to evidence archiving at closure; treating it as a closing checklist item is how findings surface after handover.
Regulatory pull is rising where projects live: CMMC phases into DoD contracts through 2028, the SEC’s cyber rule makes incidents disclosable, and DOJ credits only compliance programs that demonstrably work in practice.

Every one of those violations happened inside projects: pricing proposals, a foreign military sale, engineering data crossing borders. No corporate compliance department can see those moments; the project manager can, which is exactly why the role carries real compliance weight and a three-year independent monitor now watches Raytheon’s.

What the Project Manager in Compliance Risk Management Owns

Compliance risk is the exposure to penalties, disgorgement, and reputational loss from breaching laws, regulations, or binding commitments, and ISO 37301 defines the management system for it. Within that system, the Three Lines Model puts the project manager squarely in the first line: management that owns and manages the risk.

Ownership has a precise boundary. The project manager does not interpret securities law or negotiate with regulators; the project manager makes sure every obligation touching the project is identified, assigned to a control, evidenced, and escalated when it wobbles, the same discipline any risk management process demands.

Role of Project Manager in Compliance Risk Management

Figure 1. The three-way split: projects own execution, compliance owns the framework, legal and audit own advice and assurance.

Question Project manager answers it Compliance function answers it
Which rules bind this project? Builds the project obligations register Maintains the enterprise obligations universe
Are controls actually operating? Runs controls inside work packages, keeps evidence Designs control standards and tests samples
What changed? Screens change requests for compliance impact Tracks regulatory change and interprets it
Who needs to know? Escalates breaches within agreed hours Reports to regulators, board, and committees

Why Project-Level Failures Produce Enterprise-Level Bills

The economics are lopsided and well documented. The Ponemon Institute benchmark, still the canonical comparison, put average annual non-compliance costs at $14.82 million against $5.47 million for compliance, a 2.7-times multiplier, and IBM’s 2025 breach data shows breaches carrying a noncompliance factor costing measurably more.

Role of Project Manager in Compliance Risk Management

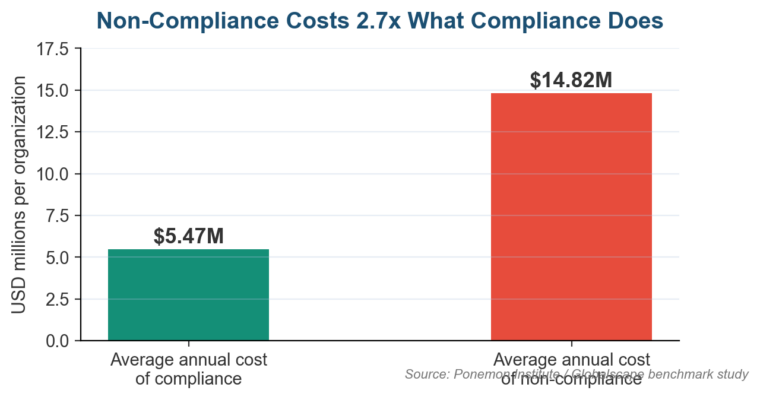

Figure 2. The multiplier that funds every compliance conversation: failing costs roughly 2.7 times complying.

Raytheon is the project-shaped proof. Defective pricing happens in proposal projects, bribery attached to a foreign military sale campaign, and ITAR violations in engineering workstreams; the DOJ’s fraud section then priced them at corporate scale, with a monitor attached for three years.

Role of Project Manager in Compliance Risk Management

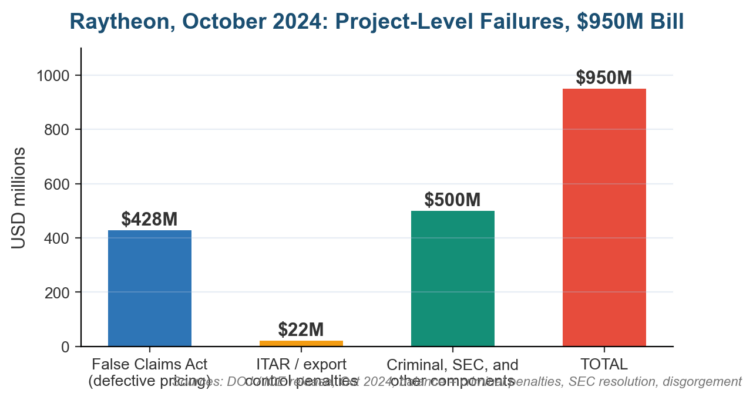

Figure 3. Raytheon’s October 2024 resolution: the $428M defective-pricing piece alone is the second-largest FCA procurement recovery.

Sentencing math rewards the same discipline the project manager provides. The U.S. Sentencing Guidelines cut penalties dramatically for organizations with effective compliance programs, and DOJ prosecutors now test whether programs work in practice, meaning evidence from live projects rather than binders, exactly what compliance risk analysis should be producing continuously.

Building the Project Compliance Risk Management Plan

Treat the plan as a project artifact with four moving parts, not a policy restatement. It slots into the broader project risk management plan as the compliance chapter, and it starts from obligations rather than from risks, because you cannot score exposure to a rule you have not listed.

Plan component What goes in it Where it lives in the project
Obligations register Statutes, regulations, permits, contract clauses (FAR/DFARS flow-downs, data terms) Annex to the project charter, owned by the PM
Compliance risk scores Likelihood and impact of breaching each obligation Project risk register, same scales as other risks
Controls and evidence Named control per material obligation, evidence format, owner Work packages and the quality plan
Monitoring and escalation KRIs, thresholds, escalation clock, reporting cadence Project governance calendar

The Obligations Register in Practice

Four columns carry the whole register: where the obligation comes from, what it requires, which control satisfies it, and what evidence proves the control ran. Keep it boring and specific; a register written at this altitude survives auditor sampling, while thematic summaries collapse under the first document request.

Source Obligation Control in the plan Evidence kept
DFARS 252.204-7012 Safeguard controlled unclassified information Enclave access reviews at each cutover Review logs, exception approvals
Export control (ITAR/EAR) No technical data to unauthorized persons Screening before contractor onboarding Screening records, license refs
Contract clause 14.2 Client data stays in-region Data-residency check per integration Architecture sign-offs
Internal policy High risks escalated within 5 days Escalation clock in governance calendar Committee minutes, tickets

Scoring works exactly like any other risk assessment: likelihood times consequence against defined criteria, with qualitative scales or quantified exposure depending on the stakes. What changes is the impact table, which must price penalties, contract termination, debarment, and delay, not just cost and schedule slip.

Anchor the plan to named sources: the FAR and its flow-downs for government work, HHS OIG’s compliance program guidance in healthcare, and the enterprise risk management policy for appetite and escalation authority. A plan that cites its sources survives audit; a generic one does not.

Running Compliance Through the Project Lifecycle

Compliance work has a rhythm that matches the PMBOK process groups, and the failure pattern is always the same: teams treat it as a closing checklist item and discover findings after handover, when fixes cost the most and the risk management lifecycle has already moved on.

Role of Project Manager in Compliance Risk Management

Figure 4. Compliance duties by process group: the obligations register opens the project and the evidence archive closes it.

Work one example end to end. A mid-size defense supplier starts an ERP implementation: at initiation the PM registers FAR/DFARS flow-downs, CMMC requirements for controlled unclassified information, and export-control screening for offshore developers; at planning, each becomes a scored risk with a control owner.

During execution the controls run inside the work: access reviews before each environment cutover, data-residency checks on every integration, screening records for every new contractor. Monitoring tracks four KRIs to the steering committee, and closure archives the evidence pack that a future risk-based internal audit or DCAA review will request. Five checkpoints keep the cycle honest:

  • Obligations register signed off before the charter is approved, and re-baselined at every major change
  • Every material obligation mapped to a named control, owner, and evidence format in the plan
  • Change requests screened for compliance impact before approval, using a standing compliance risk assessment question set
  • KRI thresholds wired to an escalation clock: breach notice to the sponsor within an agreed number of hours
  • Closure blocked until the evidence archive is complete and lessons feed the enterprise register

Skills, KRIs, and Reporting That Make the Role Work

Three capabilities separate compliance-strong project managers from checklist administrators: reading obligations well enough to ask precise questions of counsel, translating rules into work-package controls, and running evidence discipline without slowing the team. The rest is the standard toolkit of risk management techniques applied with a regulatory impact table.

Project compliance KRI Amber / red thresholds Action on breach
Obligations past due for review 1 / 3 open items Register re-baseline within five days
Open compliance findings unresolved 2 / 5 findings Sponsor escalation, remediation owner named
Mandatory training completion <95% / <85% Task-level block on affected work packages
Change requests lacking compliance screen >0 / >2 in a period Change board halts until screens complete

Report compliance risk in the same pack as cost and schedule, not in a separate annex nobody opens. KRIs with thresholds give the steering committee decisions rather than status, and the risk appetite statement defines when a project-level compliance exposure must leave the project and land on the enterprise register.

The Compliance Project Manager Career Path

Dedicated compliance project manager roles concentrate in banking, healthcare, defense, and energy, where regulatory programs run as portfolios. The Bureau of Labor Statistics puts median pay for project management specialists near $100,000, with regulated-industry compliance PMs typically earning above the general median because the obligations knowledge is scarce.

Backgrounds vary: some arrive from project management and learn the regulatory domain, others from audit, legal operations, or operational risk and learn delivery. Credentials that signal both sides, PMP or PMI-RMP plus a compliance certification, move applications fastest; the certifications ranked by hiring value guide covers the risk-side options.

The work rewards a specific temperament: comfort telling a sponsor that a milestone slips because a screening control failed, and the organization to prove it was the right call. In regulated delivery, the PM who can defend an evidence trail outranks the PM who only defends a schedule.

Project Manager in Compliance Risk Management: Your Questions Answered

What is the role of the project manager in compliance risk management?

The project manager identifies every obligation binding the project, scores the exposure, builds controls and evidence into the plan, monitors compliance KRIs through delivery, and escalates breaches on an agreed clock. The compliance function owns the enterprise framework; the project manager owns its execution inside the project boundary.

How does a project manager identify compliance requirements for a project?

Build an obligations register at initiation: statutes and regulations from the compliance function’s universe, contract clauses and flow-downs from the contract itself, permits and licenses from the delivery locations, and internal policies from the risk management policy. Have legal and compliance sign the register, then re-baseline it at every material change.

Who owns compliance risk: the project manager or the compliance officer?

Both, at different altitudes. Under the Three Lines Model the project manager, as first-line management, owns compliance risk within the project (controls, evidence, escalation), while the compliance officer owns the second-line framework of policies, interpretation, monitoring standards, and regulator liaison. Confusing the two produces either unenforced frameworks or unauditable projects.

What skills does a compliance project manager need?

Three beyond standard delivery skills: enough regulatory literacy to ask counsel precise questions, the ability to translate obligations into work-package controls with evidence, and disciplined escalation judgment under deadline pressure. Communication across technical and legal audiences carries the role; certifications like PMP plus a compliance credential signal the combination.

How much does a compliance project manager earn?

Median pay for project management specialists sits near $100,000 in current BLS data, and compliance-specialized PMs in banking, healthcare, and defense typically clear the general median because regulatory knowledge is scarce. Total compensation scales with industry, clearance requirements, and the size of the regulatory program being delivered.

What is the difference between program and project compliance risk?

Project compliance risk attaches to one defined scope: the obligations, controls, and evidence of a single delivery. Program compliance risk aggregates across related projects, adding exposures no single project sees, such as cumulative export approvals or shared-supplier obligations. Programs therefore need a consolidated register that rolls project-level positions upward.

Which frameworks guide a project manager in compliance risk management?

ISO 37301 defines the compliance management system, ISO 31000 the risk process it plugs into, and the PMBOK supplies the project lifecycle the duties attach to. Sector overlays then bind specifics: FAR/DFARS and CMMC in defense, HHS OIG guidance in healthcare, and the SEC’s cyber disclosure rule for public-company incidents.

Where Project Compliance Goes Wrong

Six failure patterns recur in project post-mortems and enforcement documents alike, and Raytheon’s monitor will be hunting exactly these. Check the first two in your own portfolio this week; they are cheap to find and expensive to ignore, and a scenario exercise exposes most of them in an afternoon.

Pitfall Root cause Remedy
No project obligations register Compliance assumed to live with the compliance team Register at initiation, signed by legal and compliance
Compliance tasks without evidence Controls run informally, nothing auditable remains Evidence format defined per control, archived at closure
Change requests skip compliance screening Change board optimizes for schedule alone Standing screen question set; no screen, no approval
Training treated as onboarding only One-time completion, long projects drift Completion KRI with task-level blocks on lapse
Escalation waits for the monthly report Breach notice buried in status packs Escalation clock in hours, agreed with the sponsor
Findings closed without root cause Pressure to clear the register before gate reviews Root-cause note required; audit samples closures

The Regulatory Horizon for Project Delivery: 2026-2028

Defense delivery is the clearest test case: CMMC phases into DoD contracts through 2028, turning cybersecurity maturity into a bid-eligibility question that project managers must evidence, not assert. Contractors that cannot produce project-level control evidence will simply stop winning work.

Disclosure keeps compressing timelines. The SEC’s cybersecurity rule makes material incidents reportable within four business days, and incidents overwhelmingly surface inside projects and changes; the PM’s escalation clock is now part of a public company’s disclosure machinery, wired through NIST CSF-aligned programs.

Regulatory-change velocity is the background pressure: Thomson Reuters’ cost of compliance research tracks compliance teams stretched across rising obligations with flat budgets, pushing execution down to the first line. The framework centralizes, the evidence decentralizes, and the project manager sits where evidence gets made, applying compliance risk management one work package at a time.

Riskpublishing helps regulated-industry PMOs build project compliance machinery that survives auditors and monitors: obligations registers, KRI packs, and governance that fits delivery rhythms. Our services include PMO risk framework builds; contact us if your projects carry obligations nobody has listed.
